Table of Contents
Production Planning Settings
Define PP Order Type
Path: Production- Shop Floor control – master data – Order – define order type
Tcode: OPJH
Select PP01
Copy SAP standard Production order PP01 as 19PO

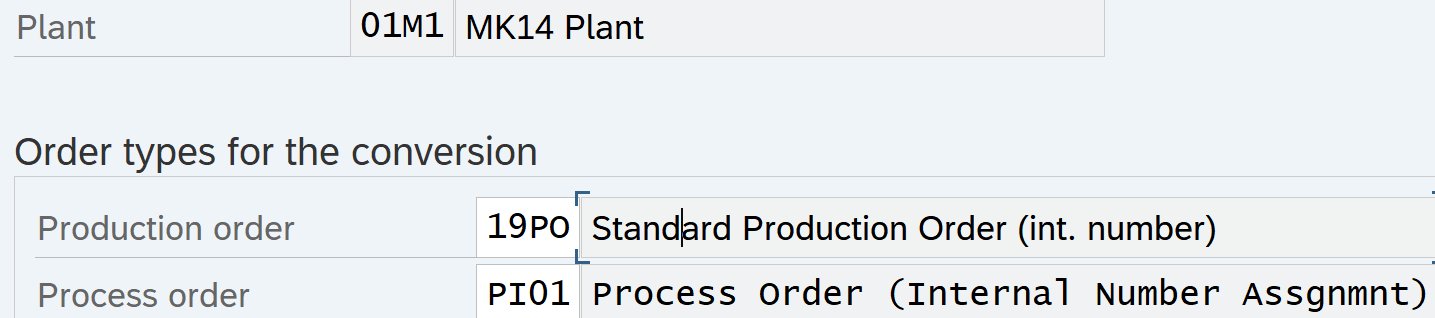

Define Order Type Dependent Parameters
Path: Production- Shop Floor control – master data – Order – define order type dependent parameters
Tcode: OPL8

Copy from plant 1000 and Order type PP01. Change Plant to 01M1 and Order type to 19PO

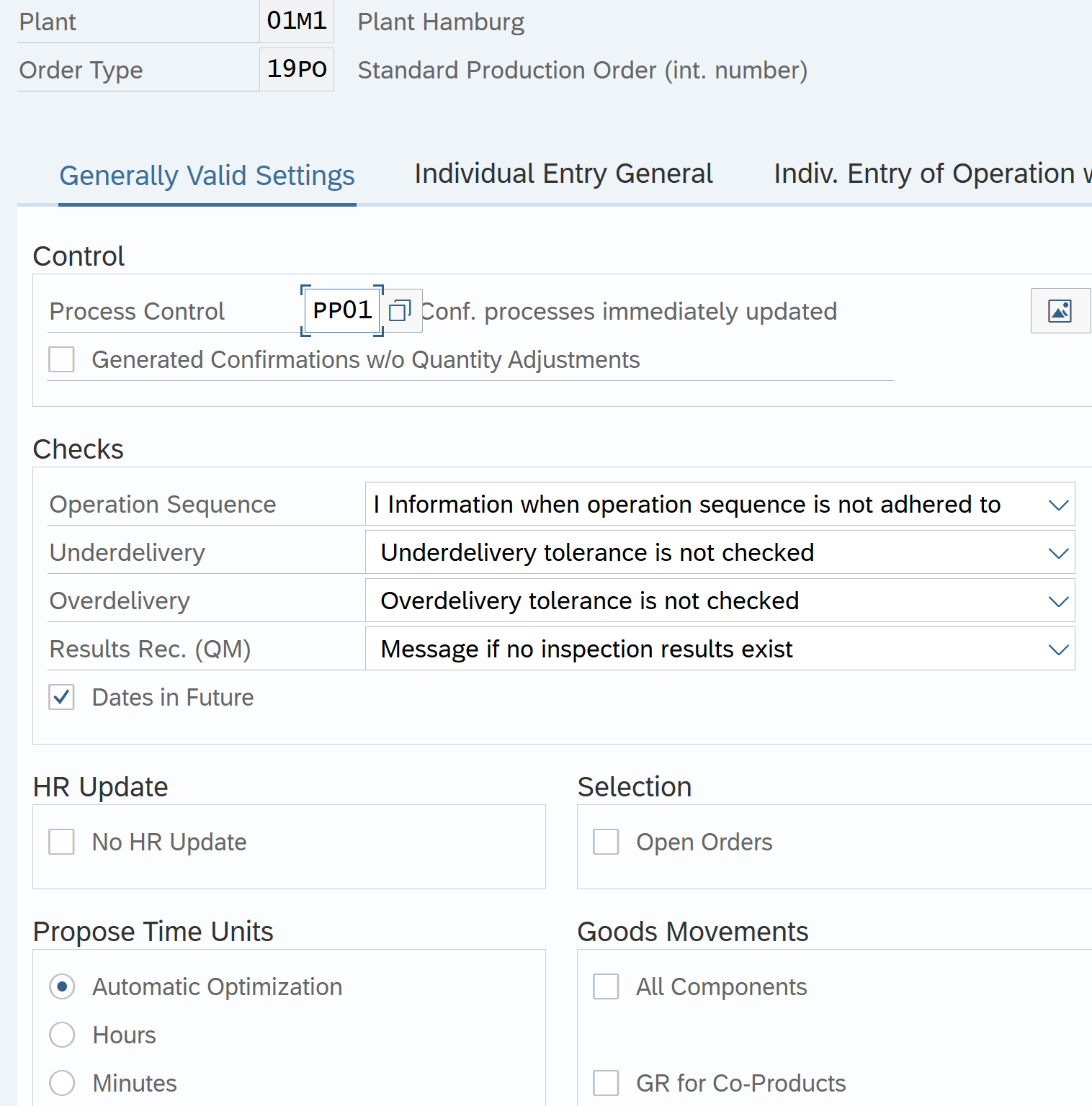

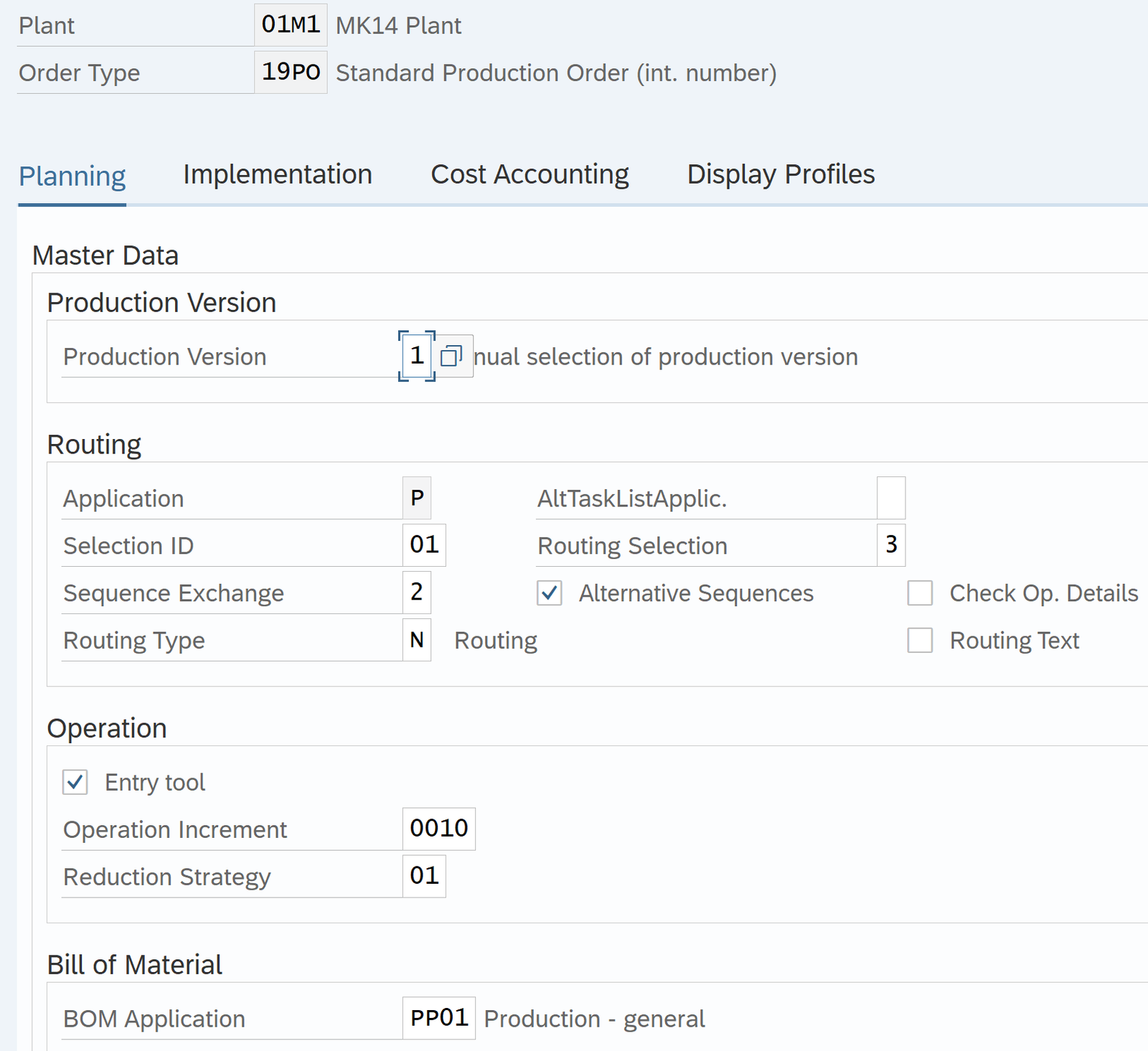

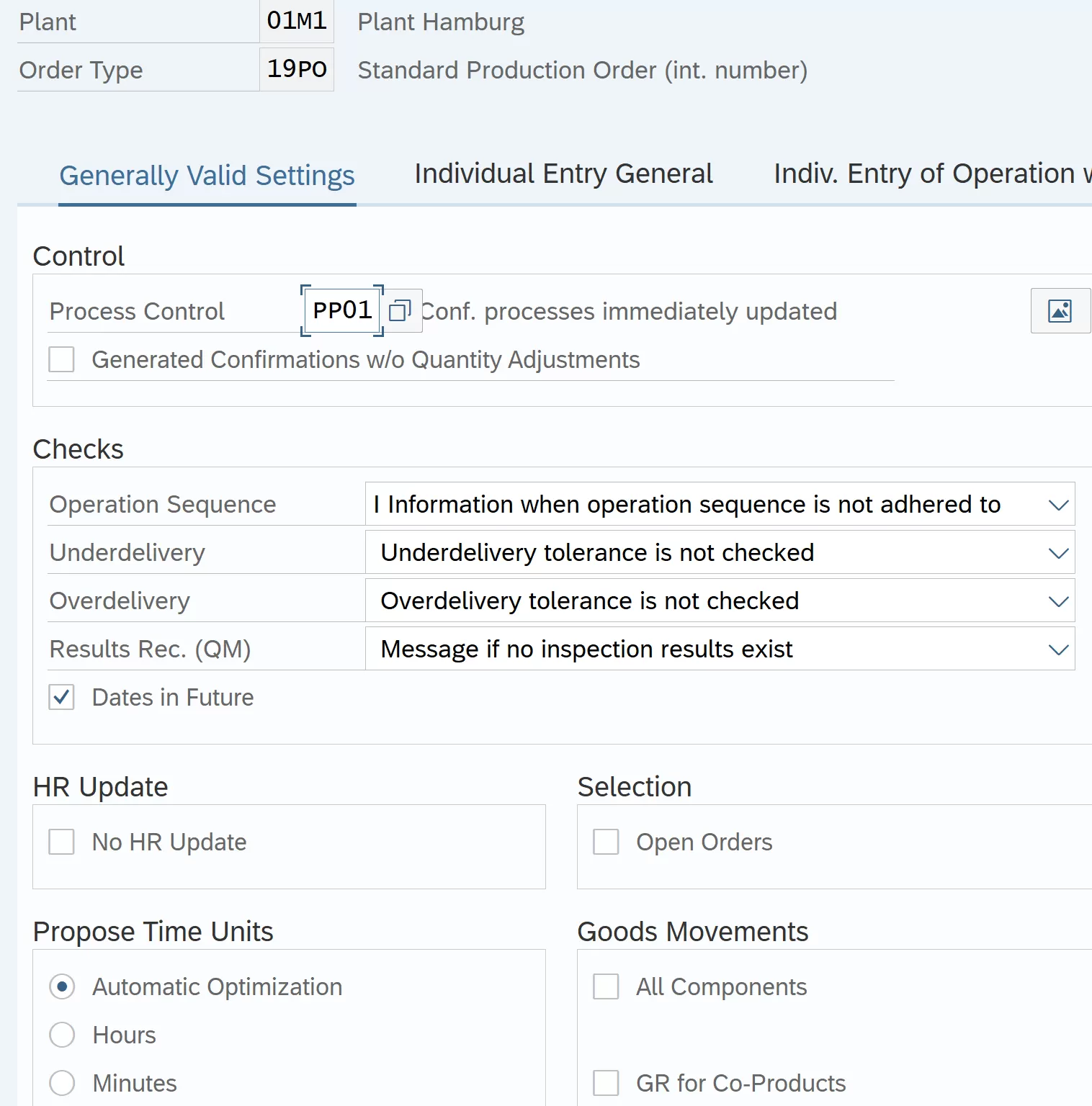

Define Scheduling Parameters for Production Order

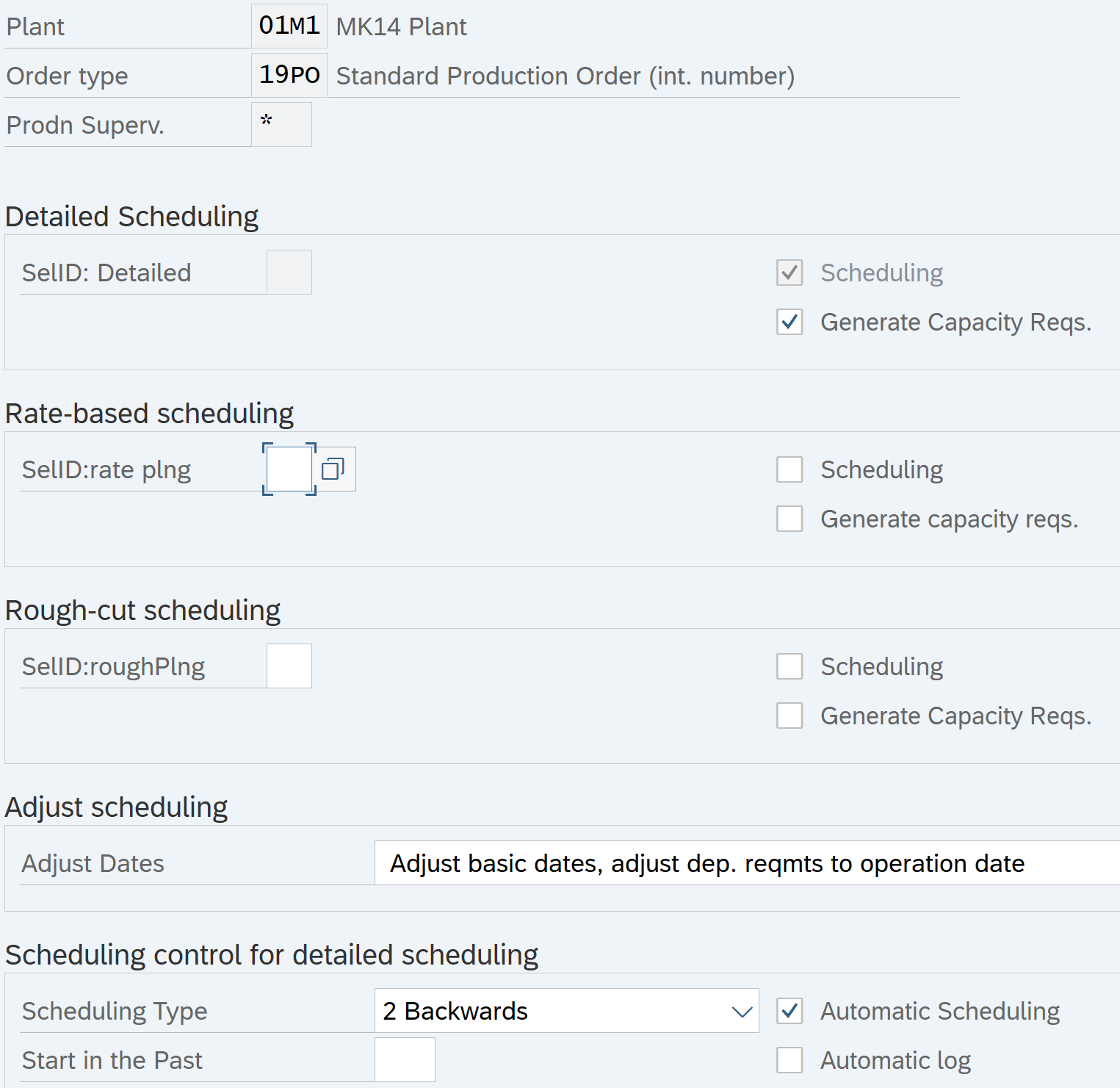

Path: Production- Shop Floor control – operations – scheduling -define scheduling parameters for production orders
Tcode: OPU3
Copy Plant 1000 and Order type PP01 as Plant 01M1 and Order type 19PO
Define Confirmation Parameters
Path: Production- Shop Floor control – operations – confirmation – define confirmation parameters
Tcode: OPK4
Copy Plant 1000 and Order type PP01 as Plant 01M1 and Order type 19PO
Define Checking control
Path: Production- Shop Floor control – operations – availability check – define checking control
Tcode: OPJK
Copy Plant 1000 and Order type PP01 as Plant 01M1 and Order type 19PO for business functions 1 and 2

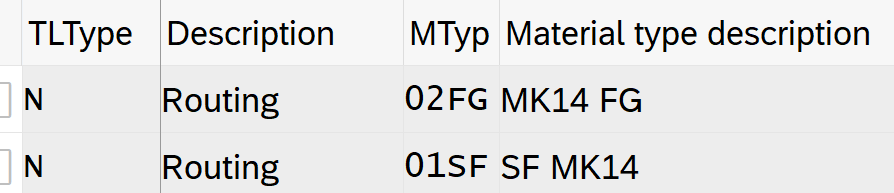

Define Material Type assignment
Path: Production – Basic Data – Routing – General Data – Define Material Type assignment
Tcode: OP50
Material Type 02FG and 01SF define in FI-MM
Maintain Overall Plant Parameters
Path: Production – MRP – Plant Parameters – carry out overall maintenance of plant parameters
Tcode: OPPQ
Copy Plant 1000 to Plant 01M1

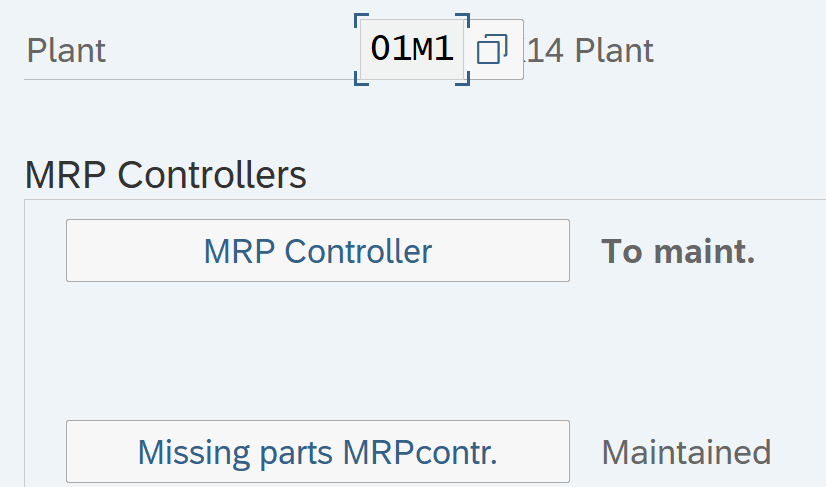

Click on Maintain – Enter plant 01M1 – Click on MRP Controllers
Click on MRP controller – New entries – Enter Plant 01M1 and save

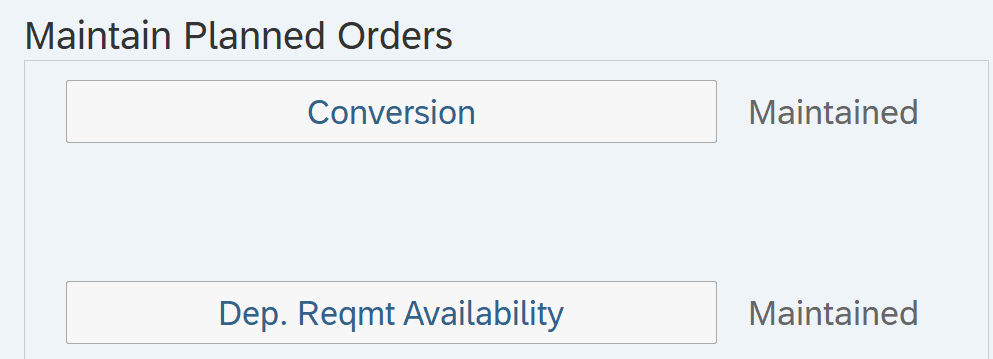

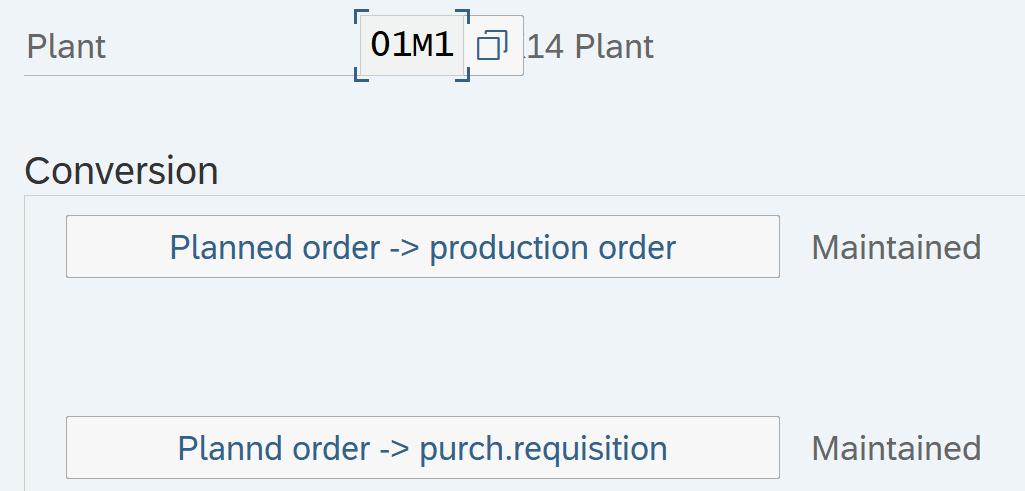

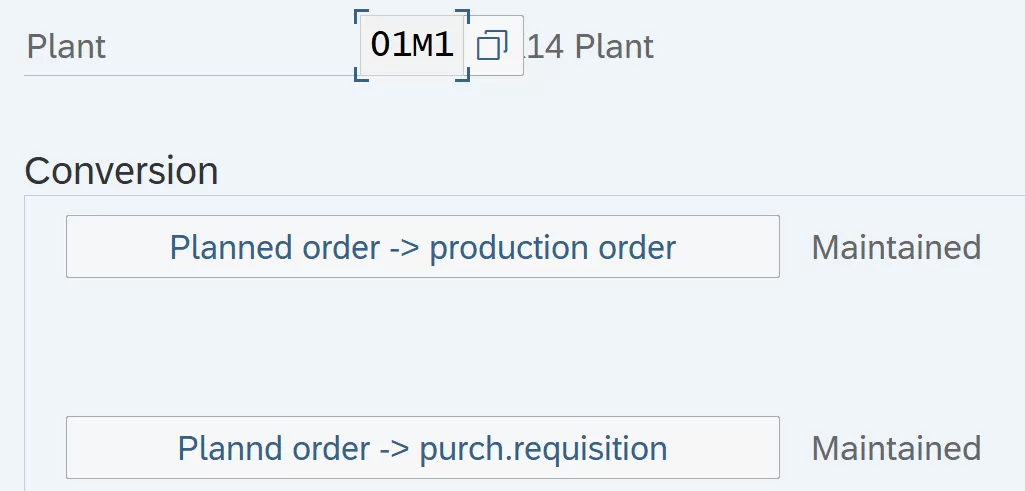

Click on Conversion under maintain planned orders
Click Planned Order and update Production Order to 19PO
Integration between CO and PP

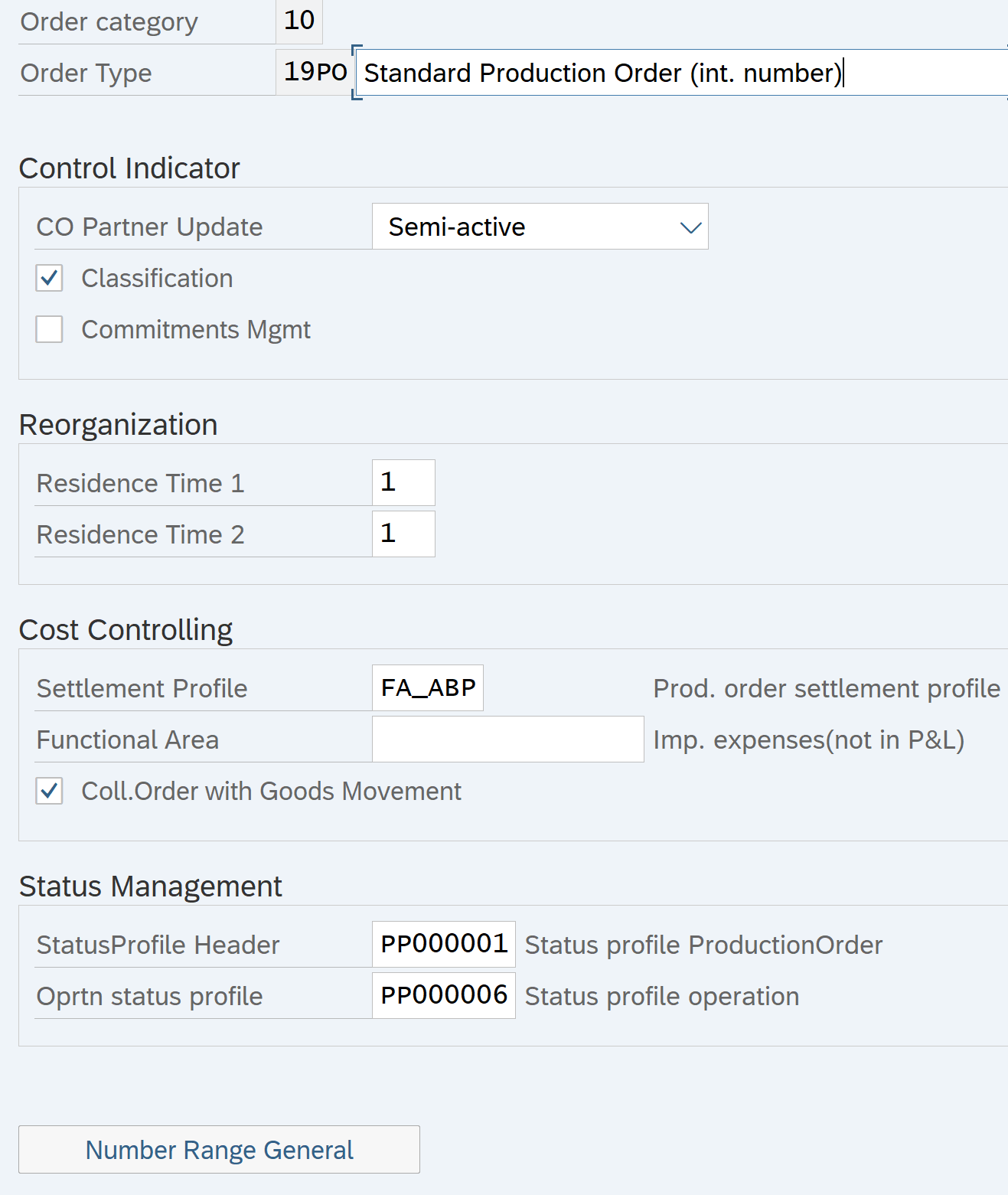

Check Order Type
Path: Controlling – Product Cost Controlling – Cost Object Controlling – Product Cost by Order – Manufacturing Orders – Check Order Types
Tcode: KOT2

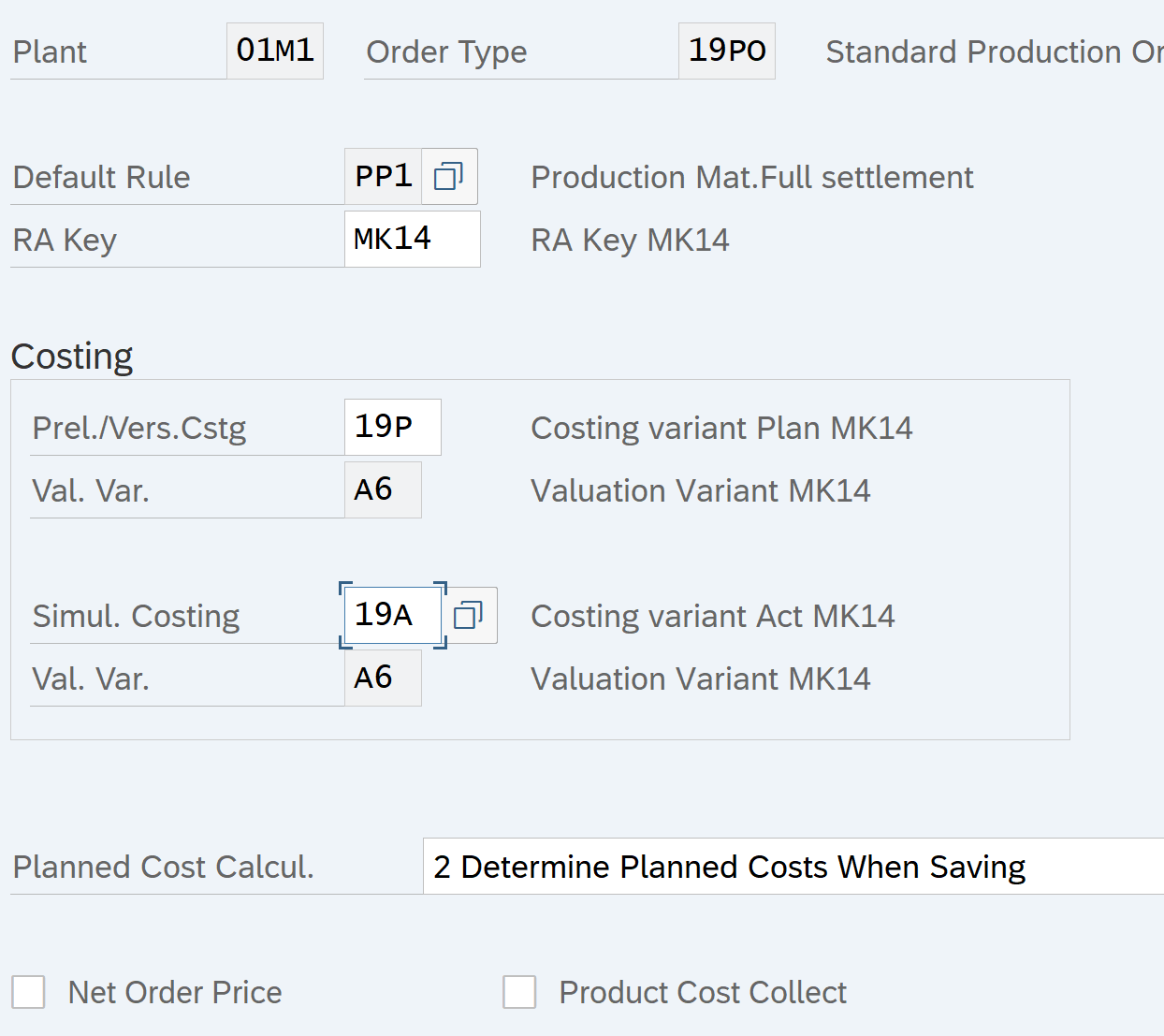

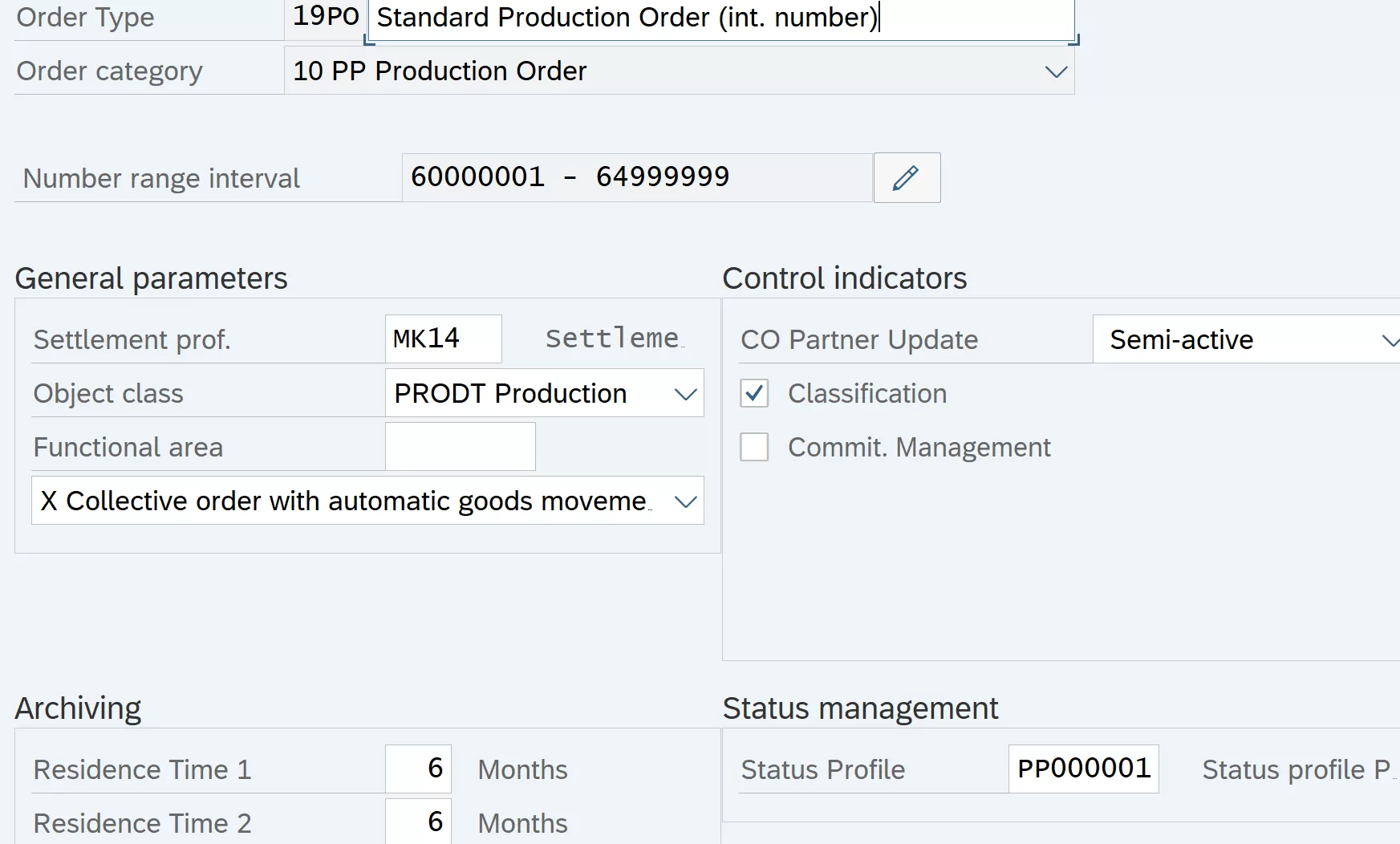

Update your order type 19PO as below
Update Settlement Profile
Update Object Class: Production
Residence Time: 6
SAP Product Costing Training-Advance
Define Cost Accounting relevant default values for order type
Path: Controlling – Product Cost Controlling – Cost Object Controlling – Product Cost by Order – Manufacturing Orders
Update as below:

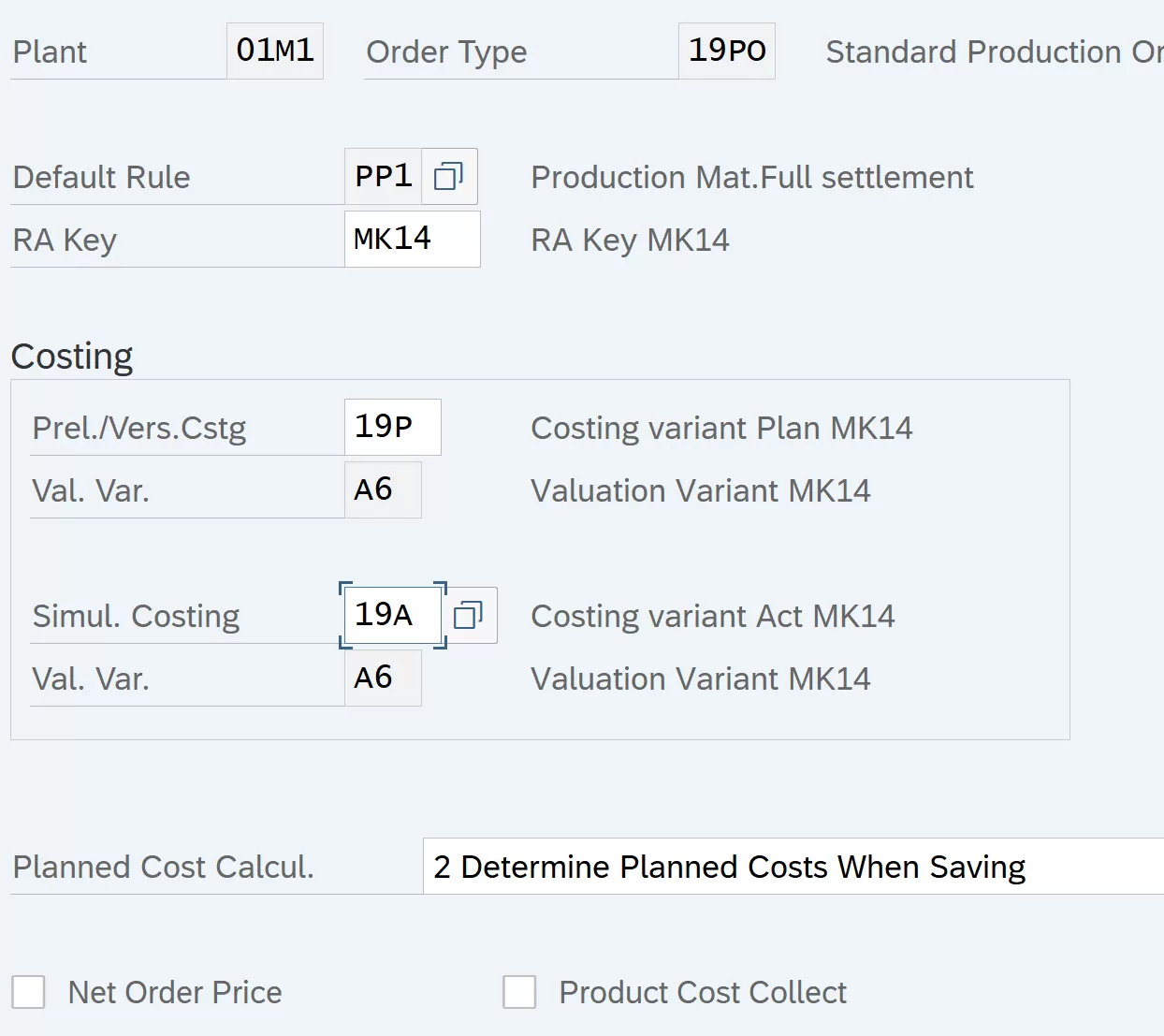

RA Key: MK14
Costing Variant Plan: 19P
Costing Variant Actual: 19A
End User Steps

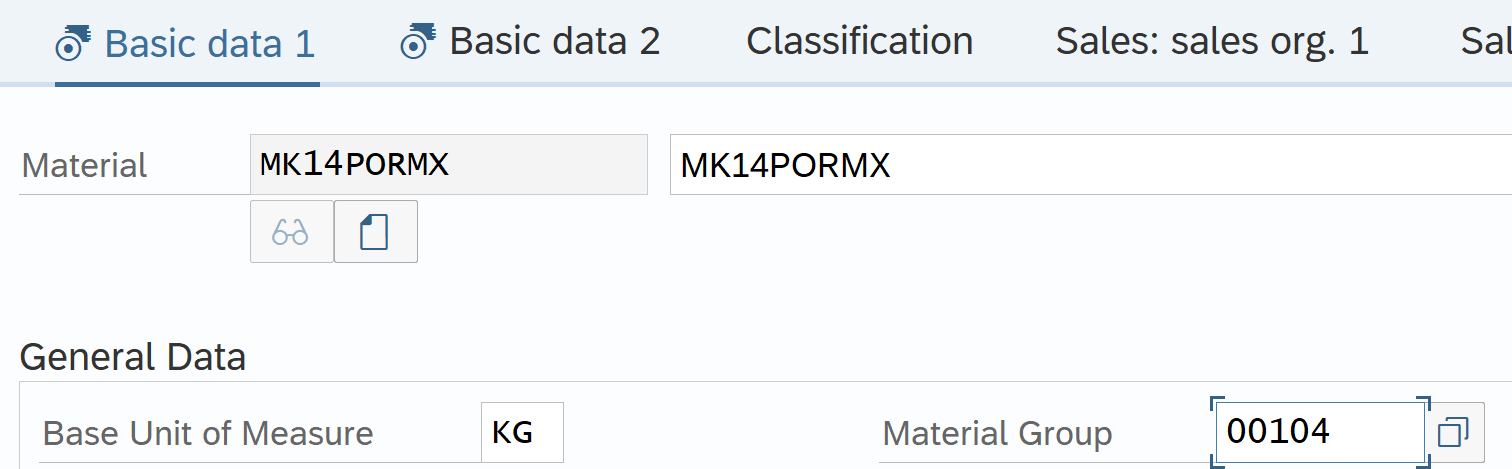

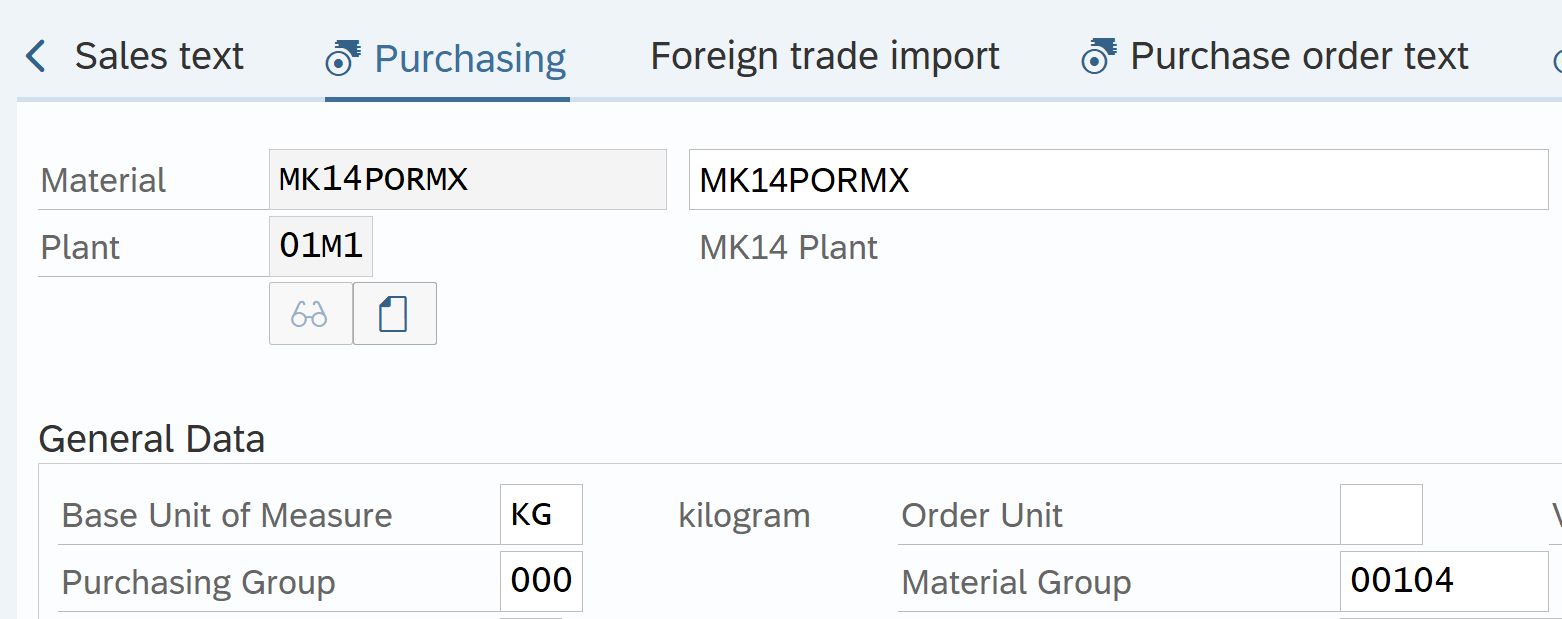

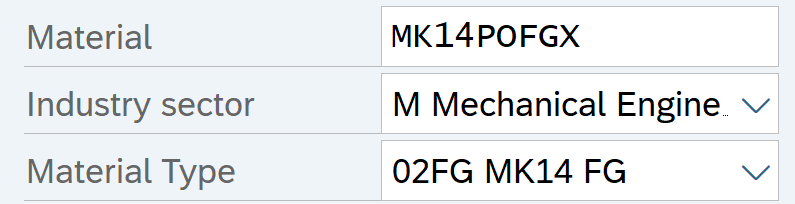

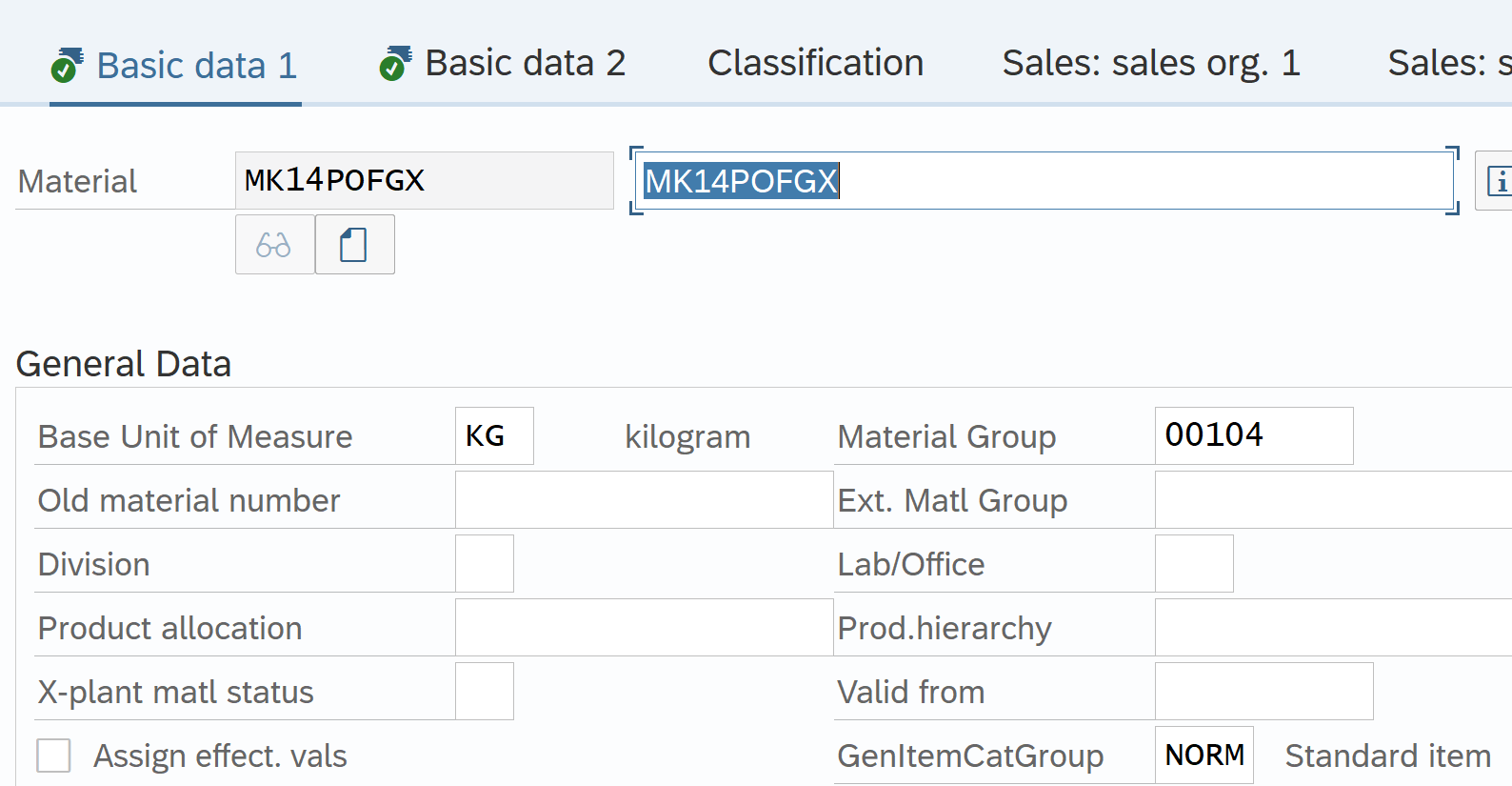

Create Finished Goods Material Master
Tcode: MM01

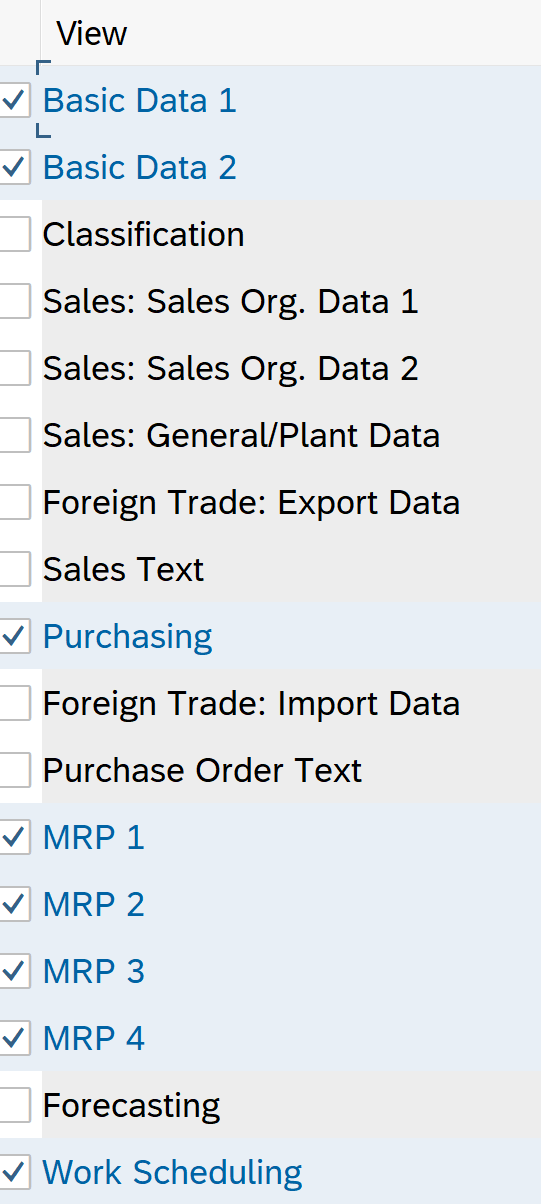

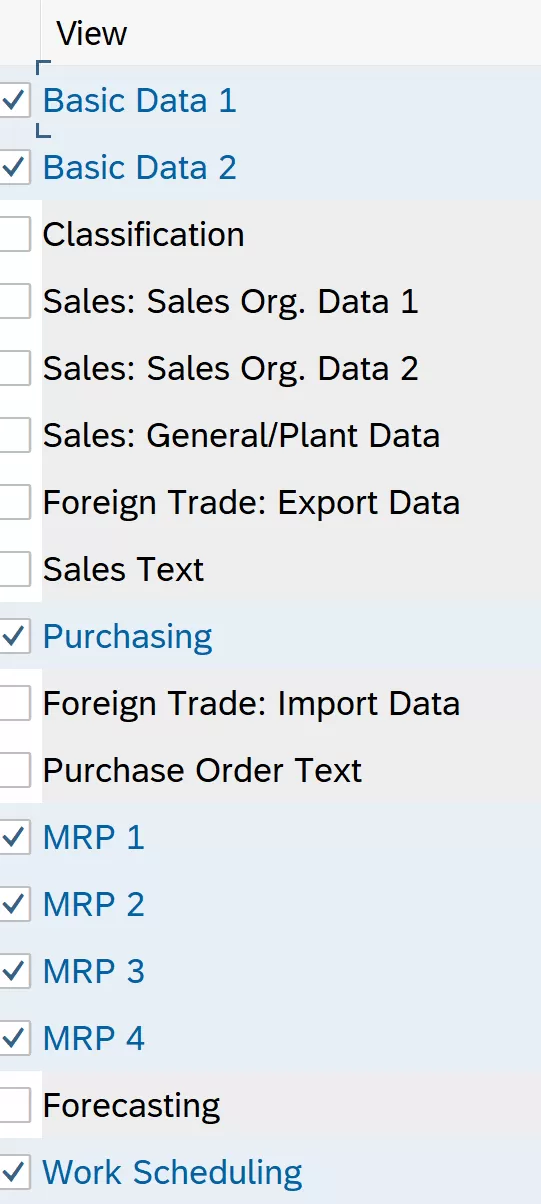

Basic Data 1 and 2 view
- Required for all material types

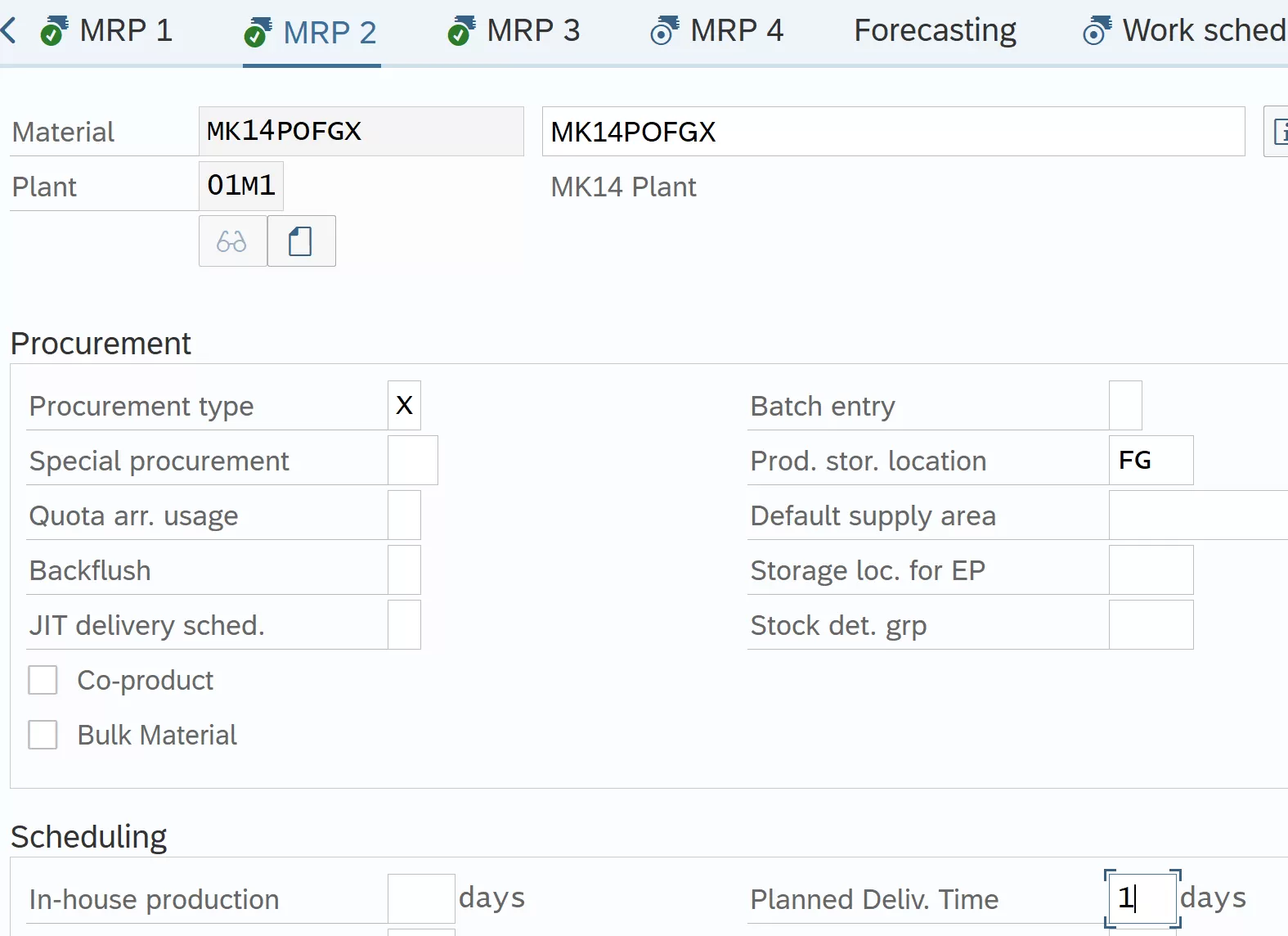

- Fields: Base Unit of Measure, Material Group, X-Plant Status, Prod Hierarchy

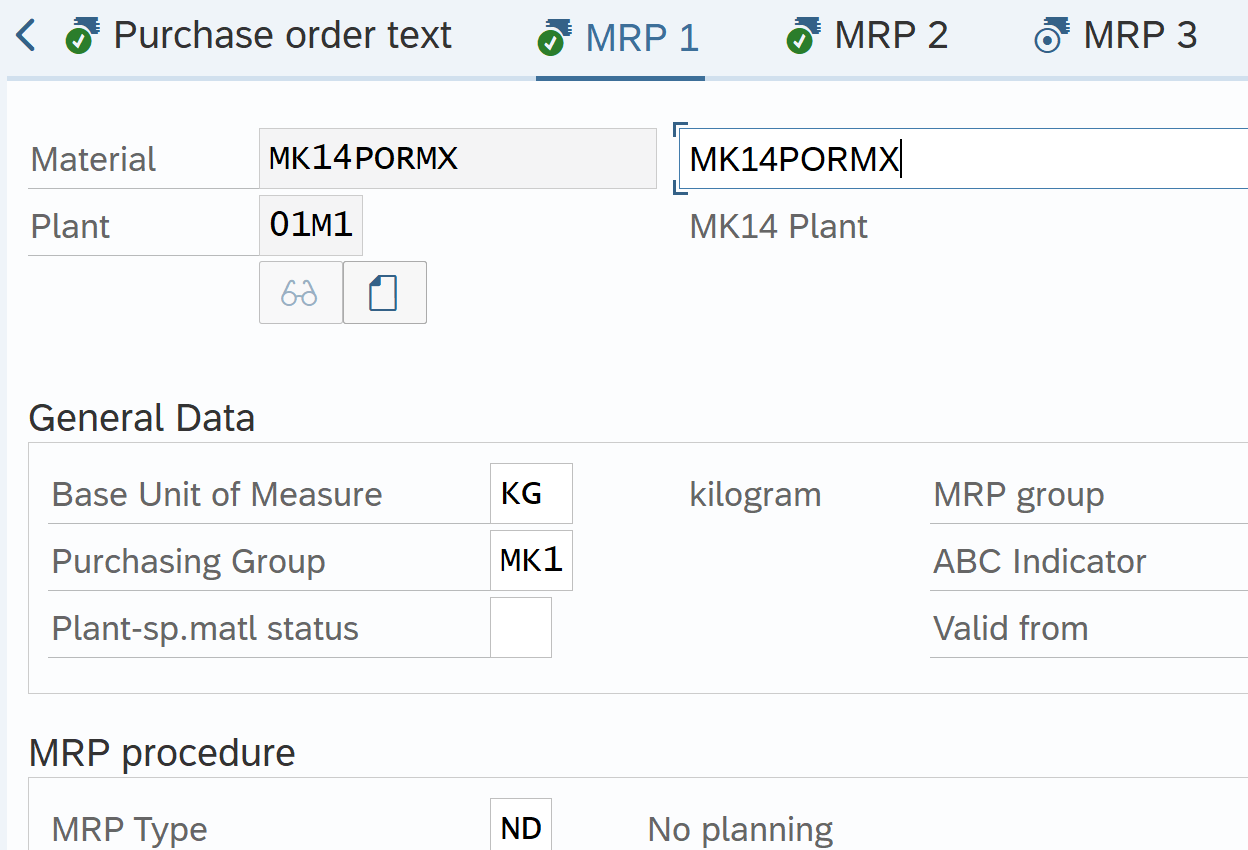

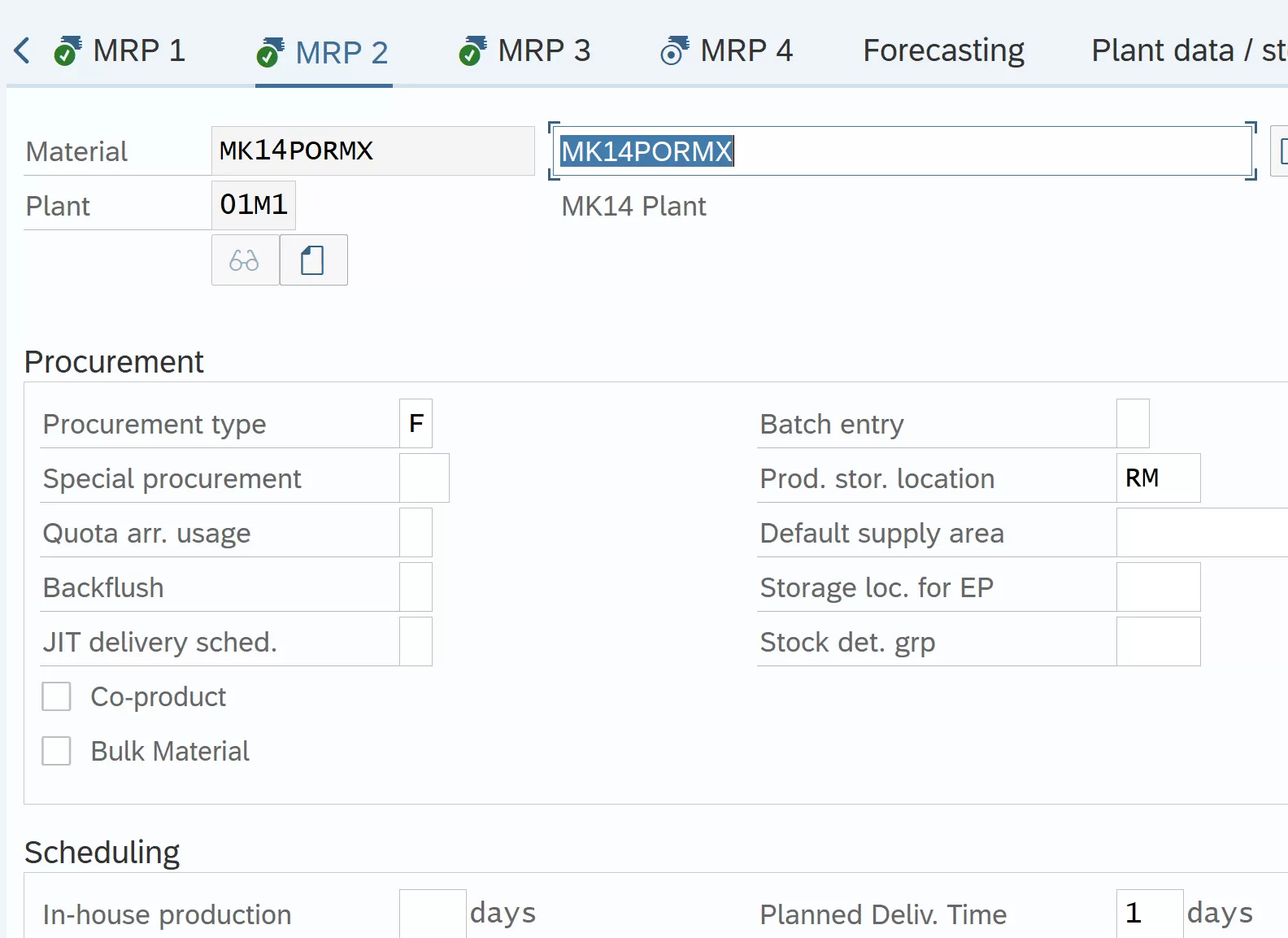

MRP 1 View (Material Requirement Planning)

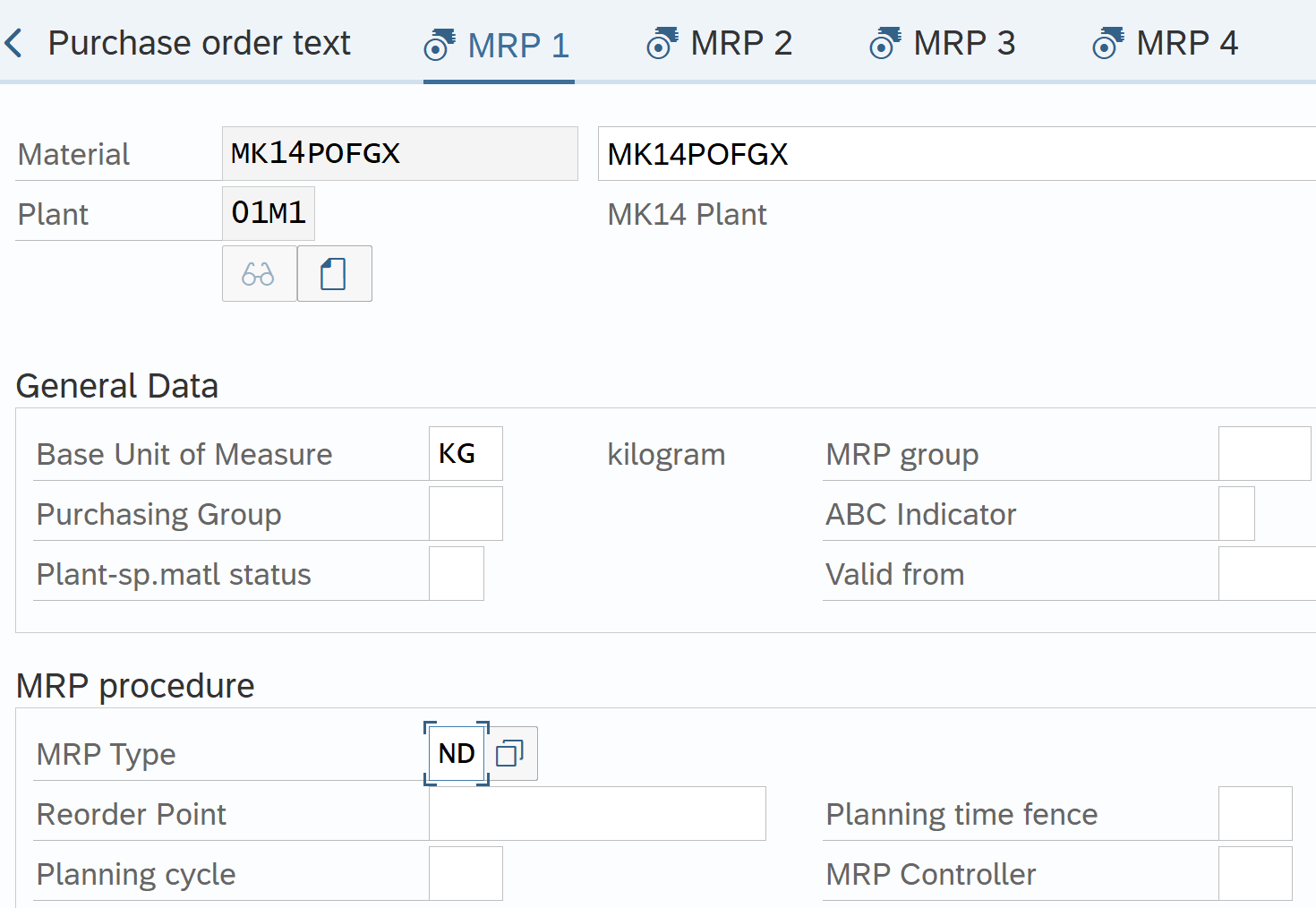

- MRP Type: ND (No Planning)
- Procurement Type: X (Both Internal and External)

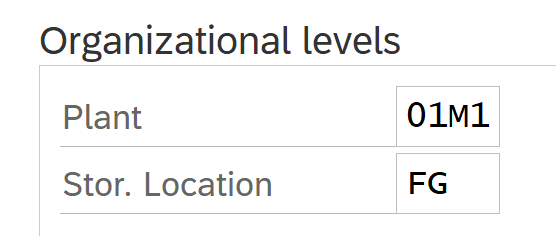

- Storage Location: FG

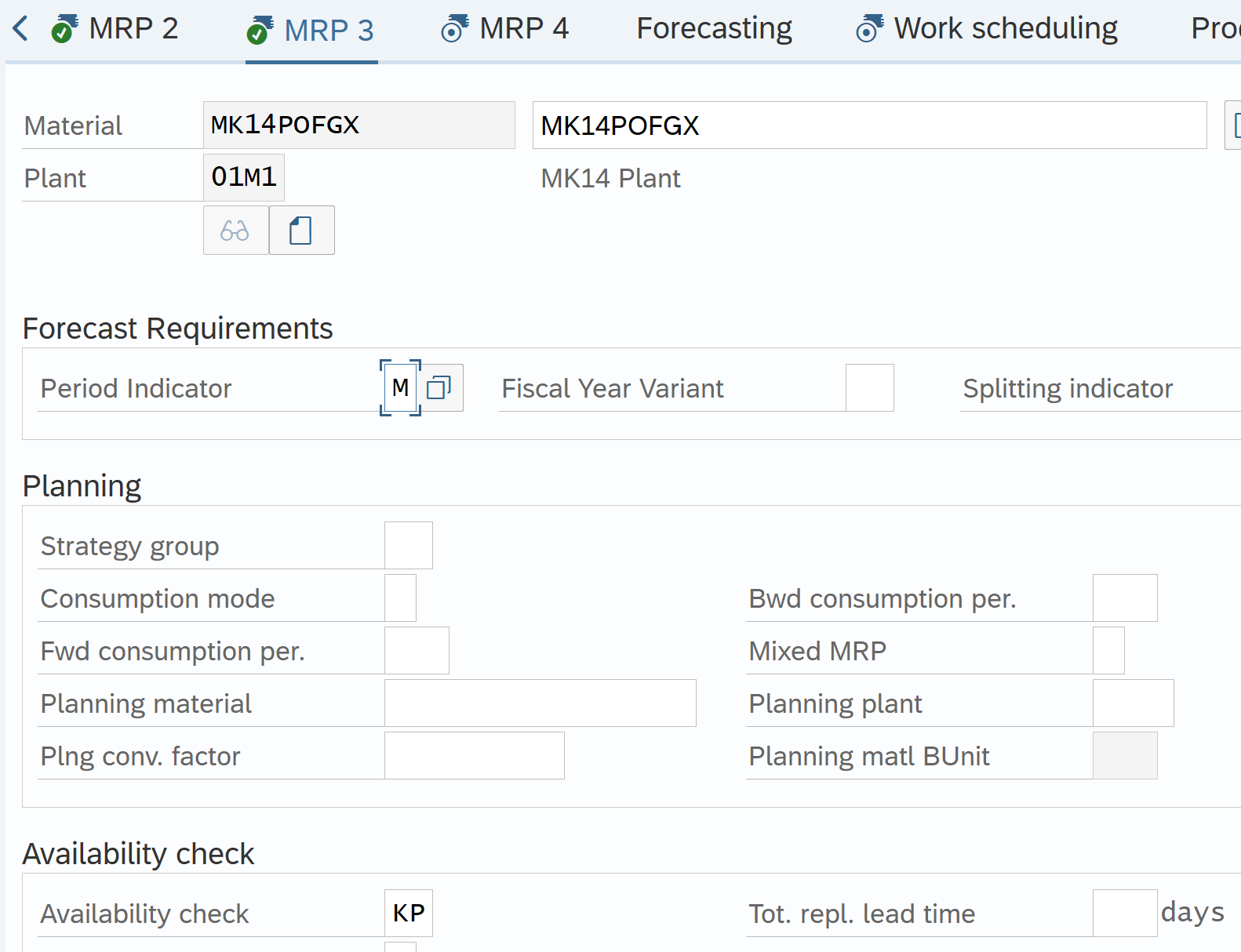

- Availability Check: KP (No Check)

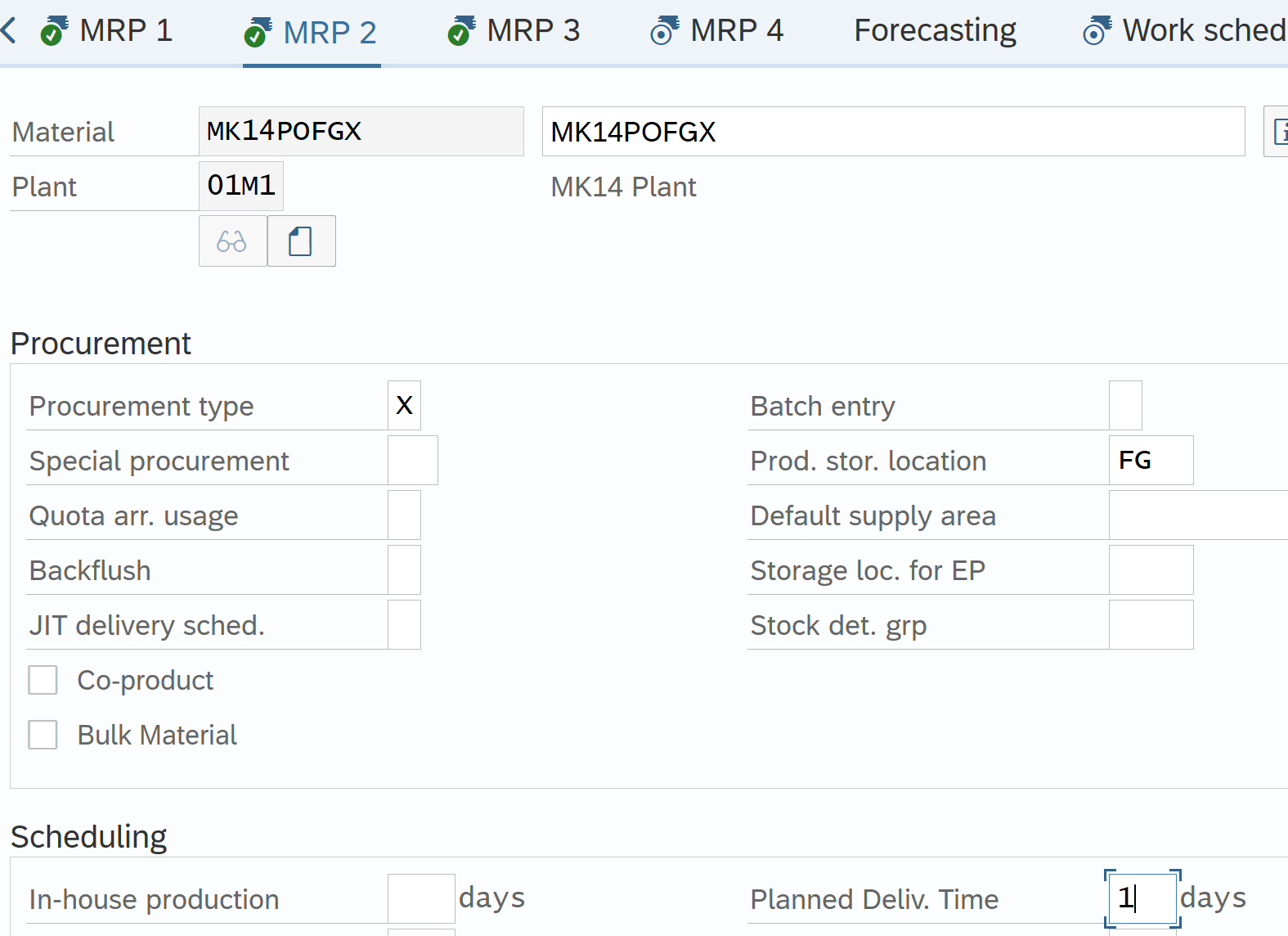

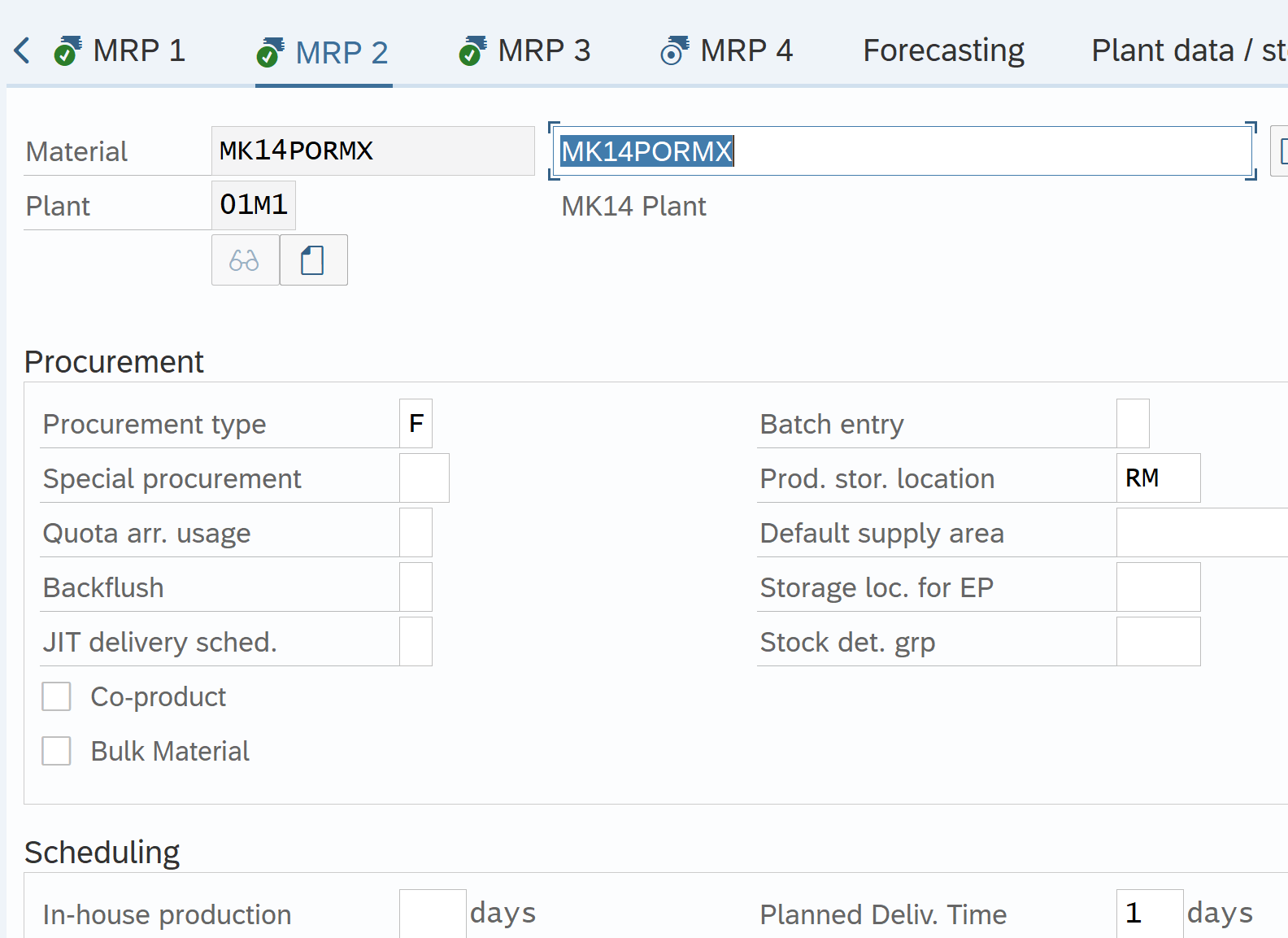

MRP 2 View
Back flush:
- Always Back flush
- Work Center decides

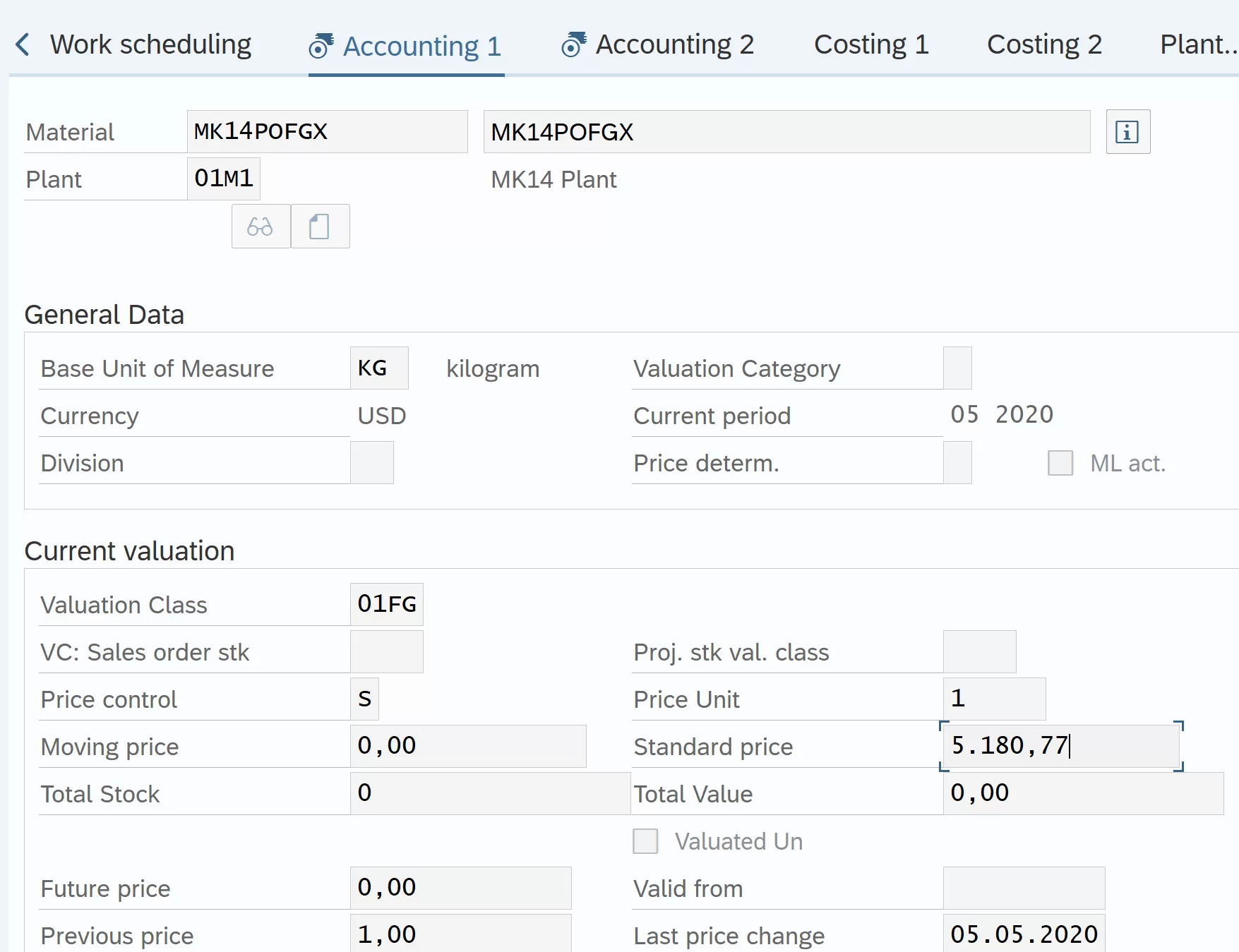

Accounting 1
- Valuation Class: Determine GL account posted
- Price Control
- S: Standard cost. Used for FG
- V: Moving average price. Used for Raw Material
- Price Unit: Cost per Unit ( Units specified here)

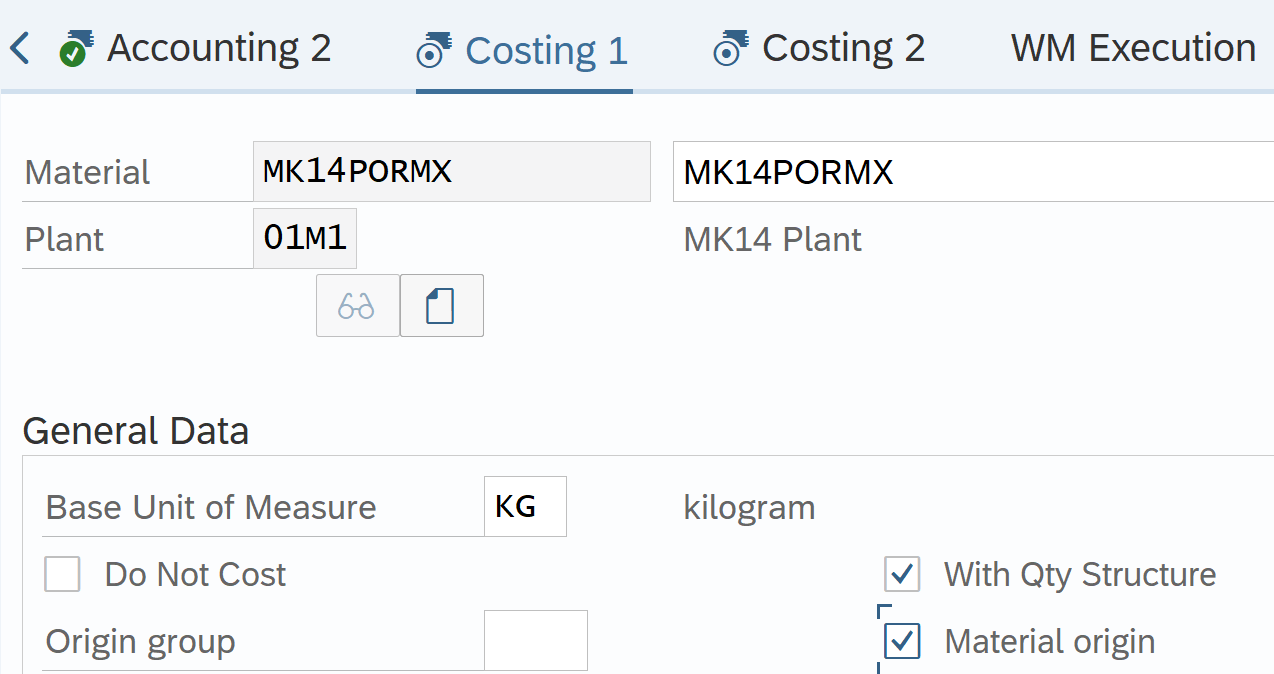

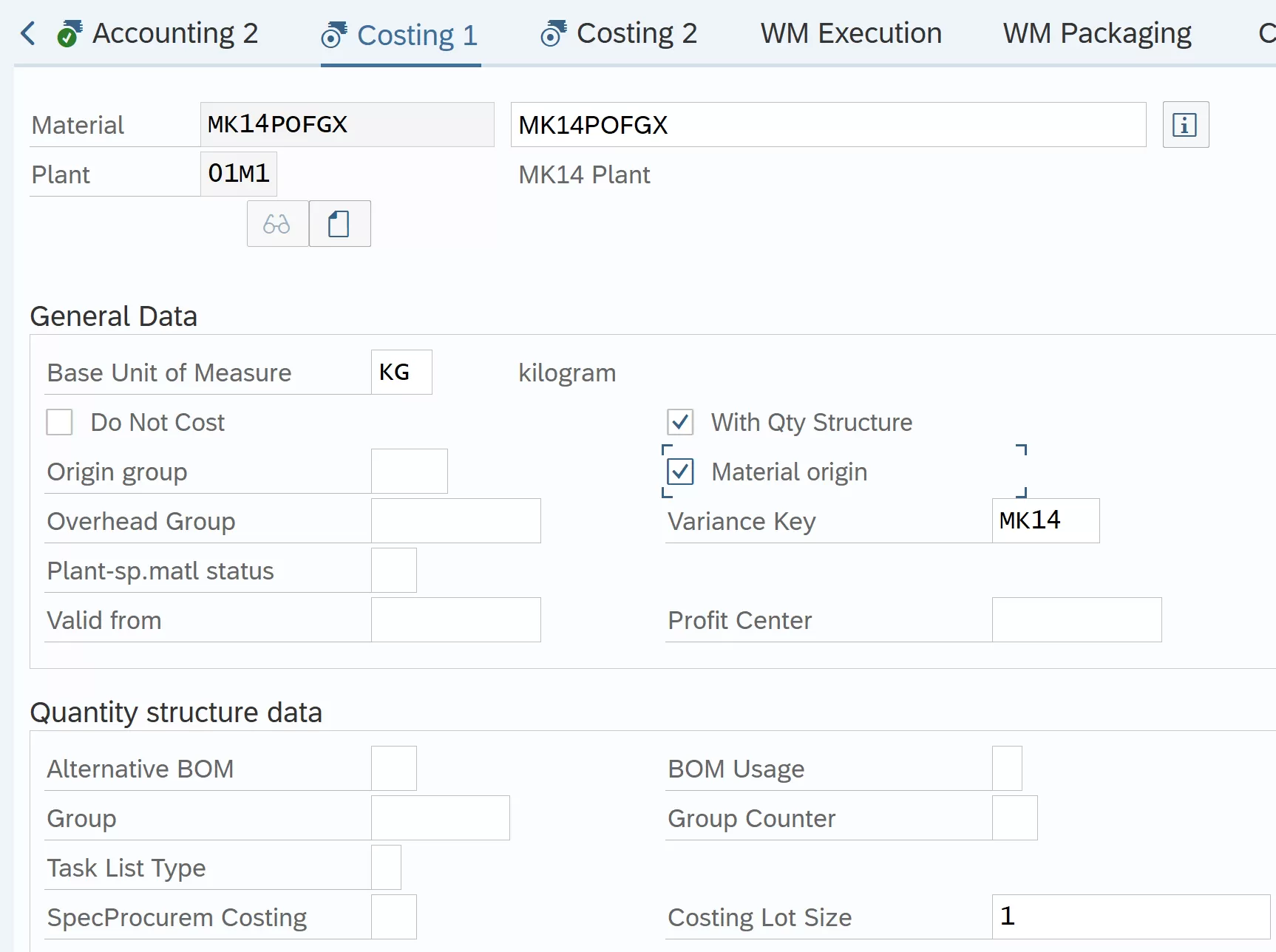

Costing 1

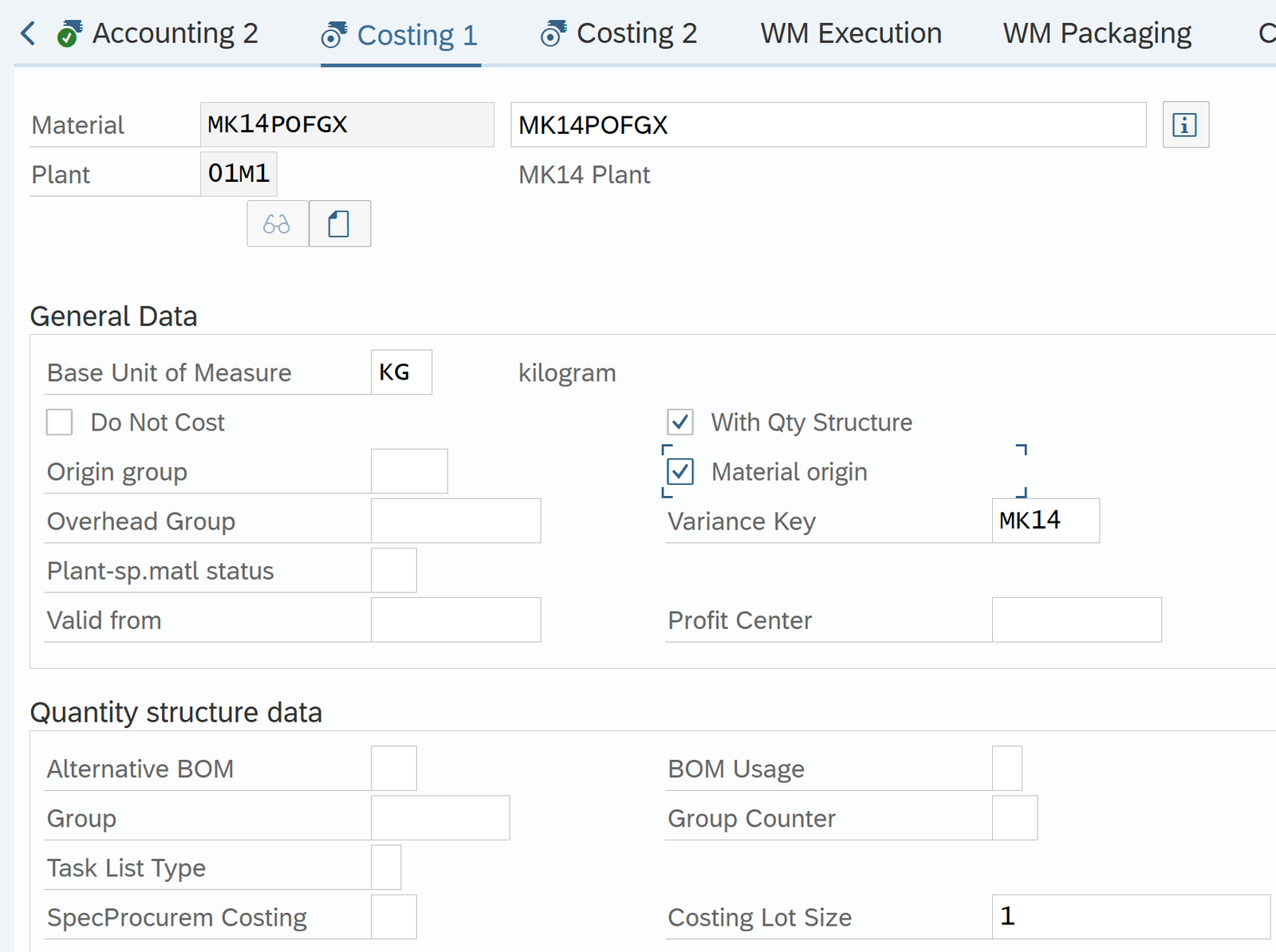

- With Qty Structure: Selected for material costed with BOM + Routing
- Material Origin: Select to display Material Number in controlling reports
- Variance Key: Specify the one created earlier.
- Costing Lot size
Costing 2
- Future Price: Current market price
- Current Price: Current Release Price
Tcode: MM01

Material MK14PORMX created
Create MK14PORMY. Same as MK14PORMX
Material MK14PORMY created
Finished Goods | Raw material |
MK14POFGX | MK14PORMX |
MK14PORMY |
Create BOM

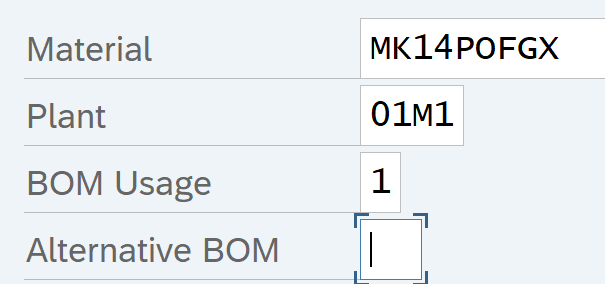

Tcode: CS01 / CS02 / CS03
Create Finished Goods BOM (Bill of Material)

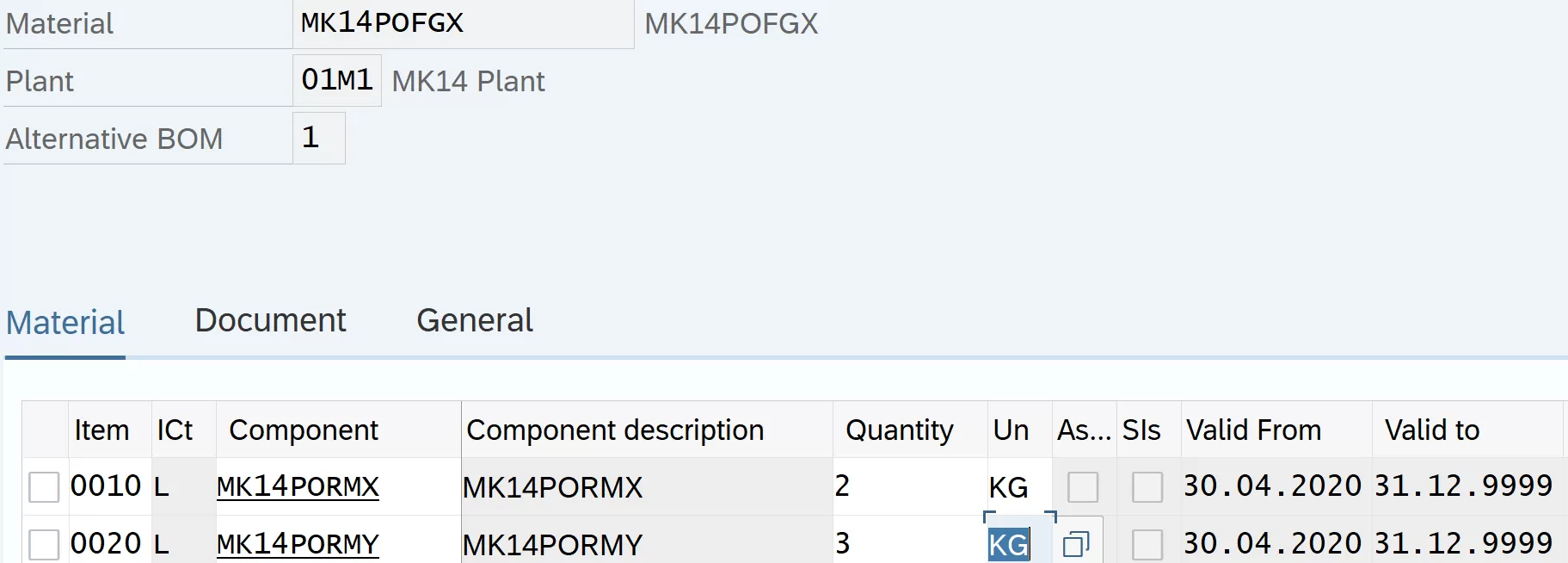

Above BOM => need 2 kg and 3 Kg of Raw material X and Y to manufacture 1 Kg of FG
Routing
Routing | Setup Activity | Machine Activity | Labor Activity | Work Center |

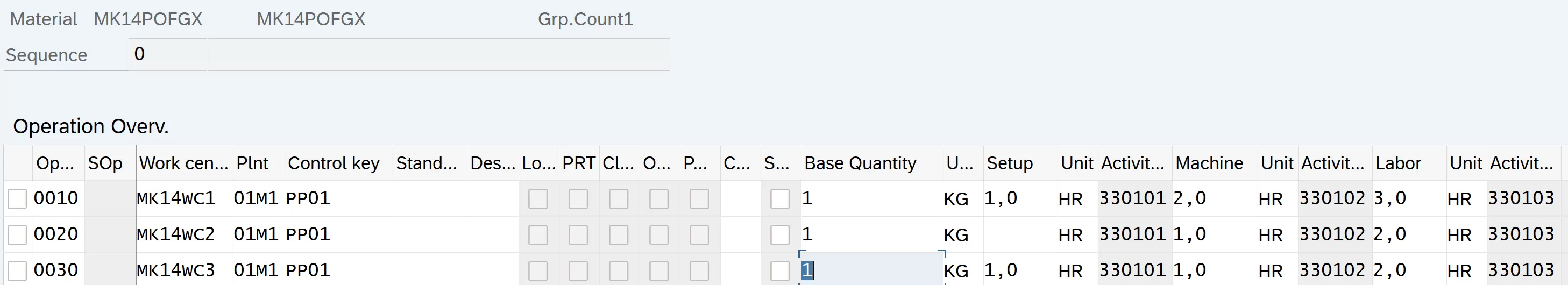

Operation 10 | 1 | 2 | 3 | WC 1 |
Operation 20 | 1 | 2 | WC 2 |
Routing is a list of Operations performed on Raw material to convert it into FG. These operations are performed at locations called work centers.

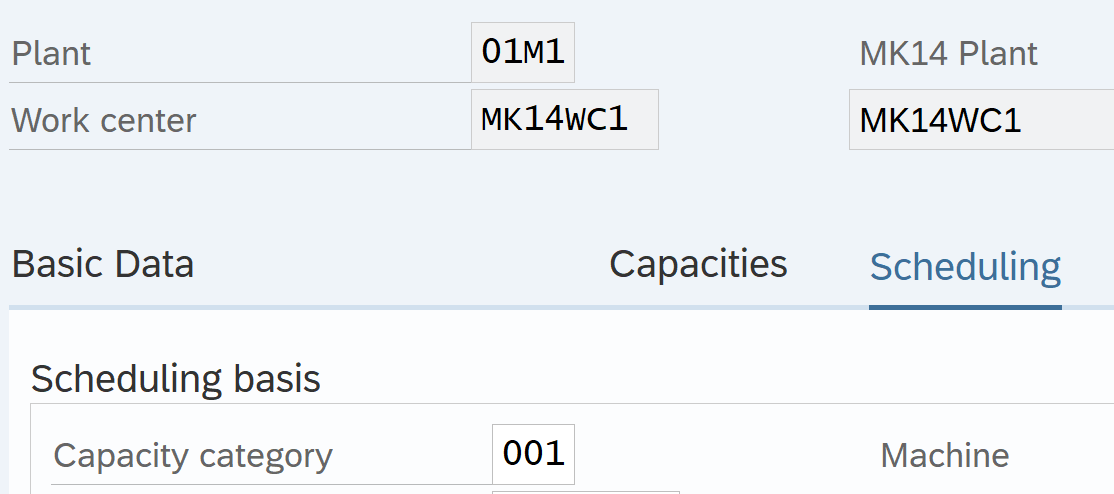

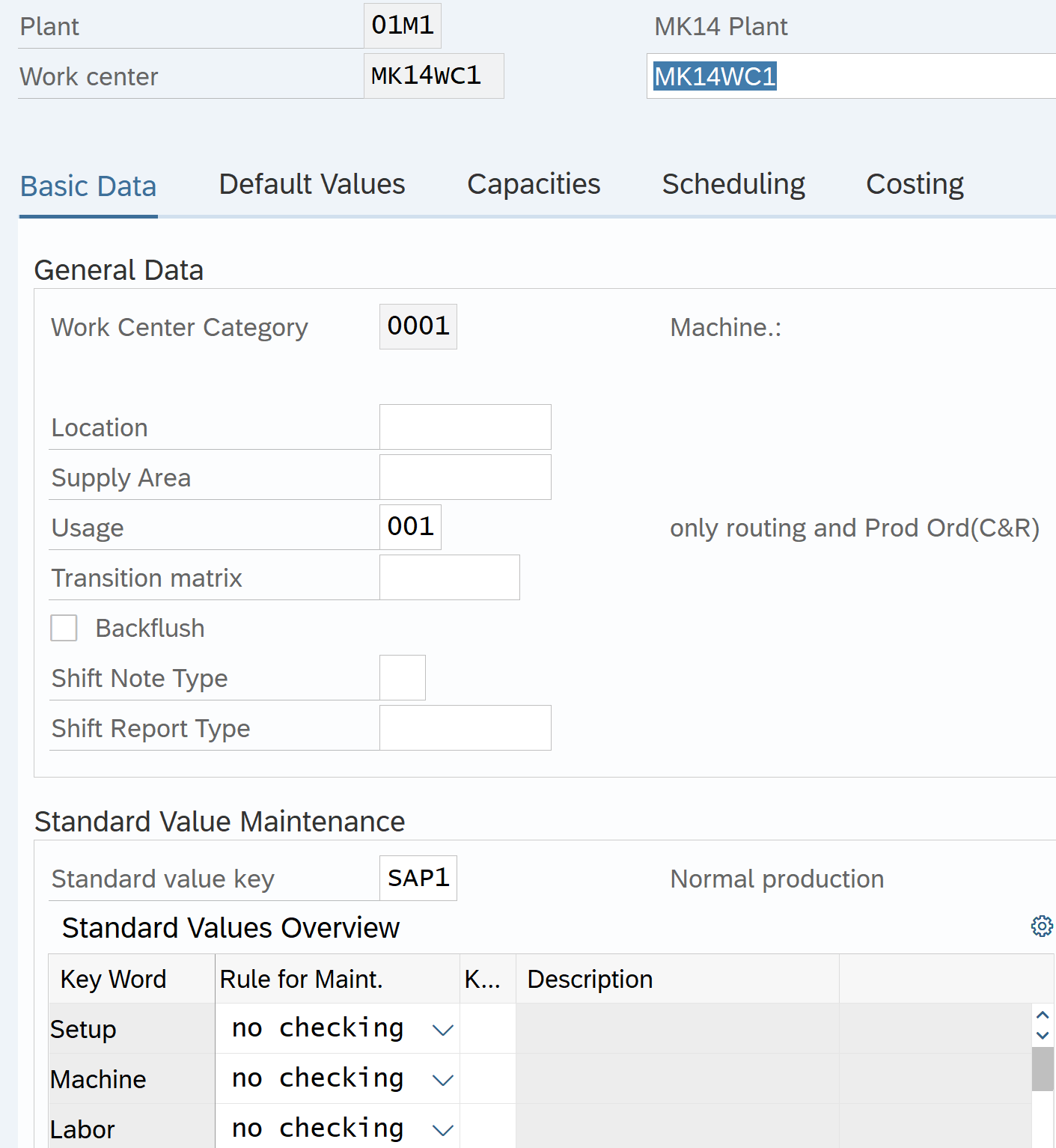

Create Work Center

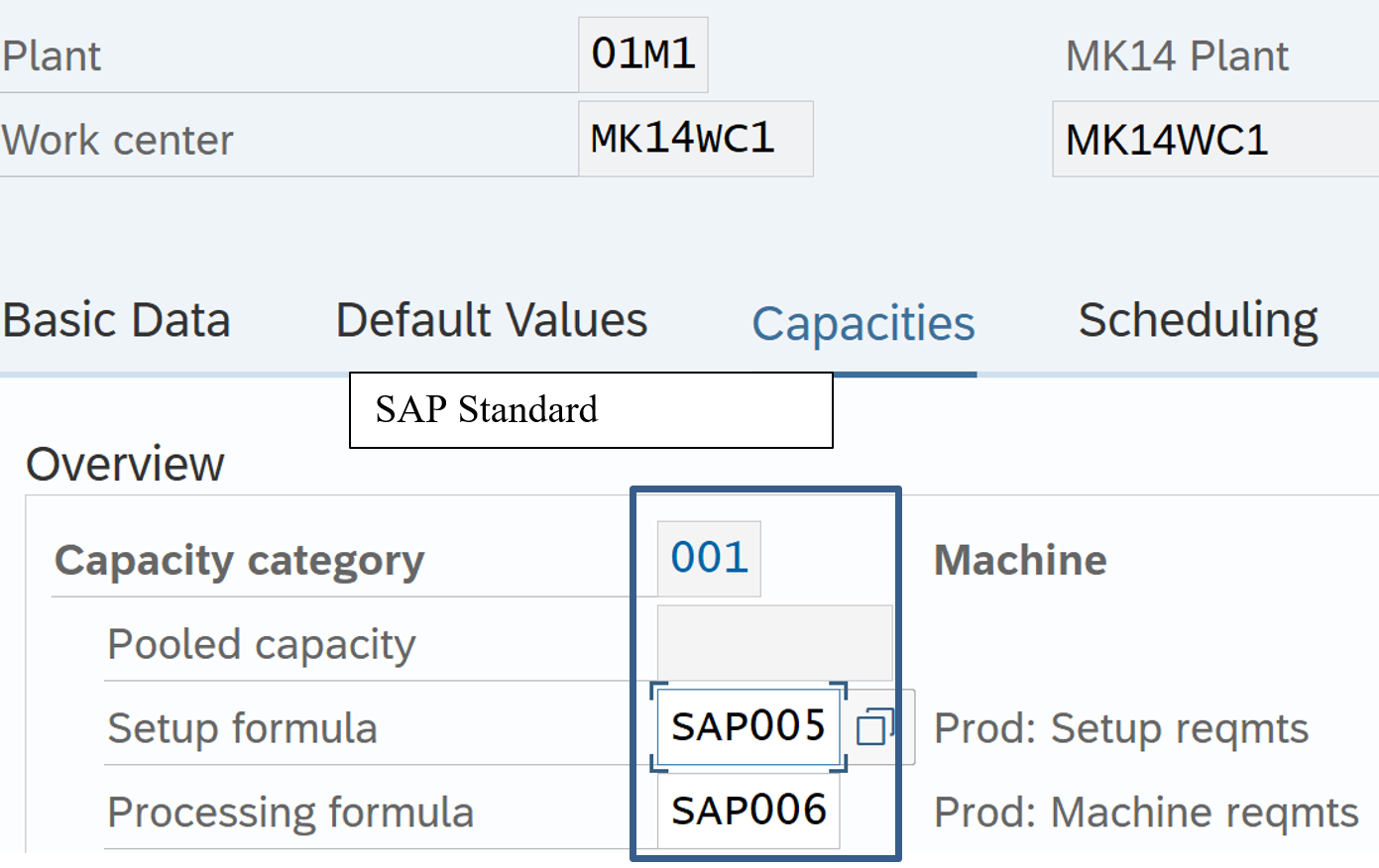

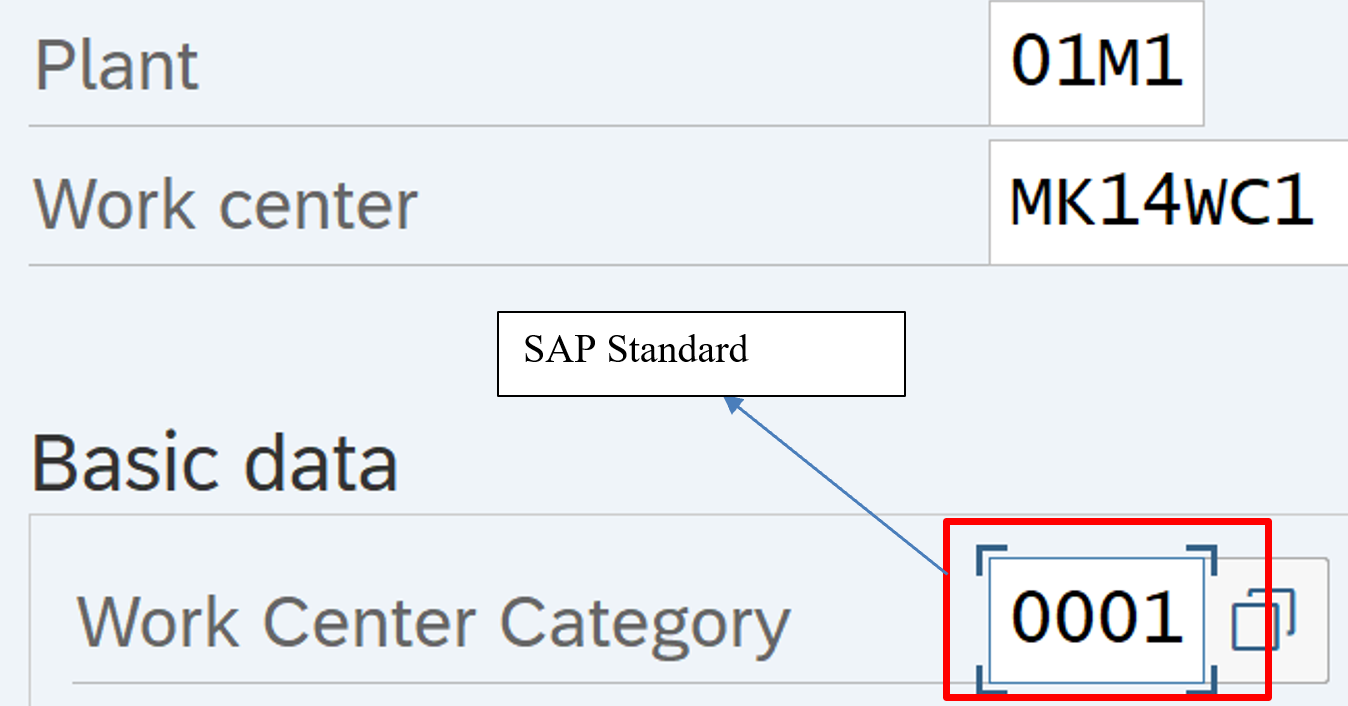

Tcode: CR01
To hide Person responsible field, go to OPFA – Basic Data – P3000-VERAN – Hide
SAP Default
Below screen appears when press enter on earlier screen

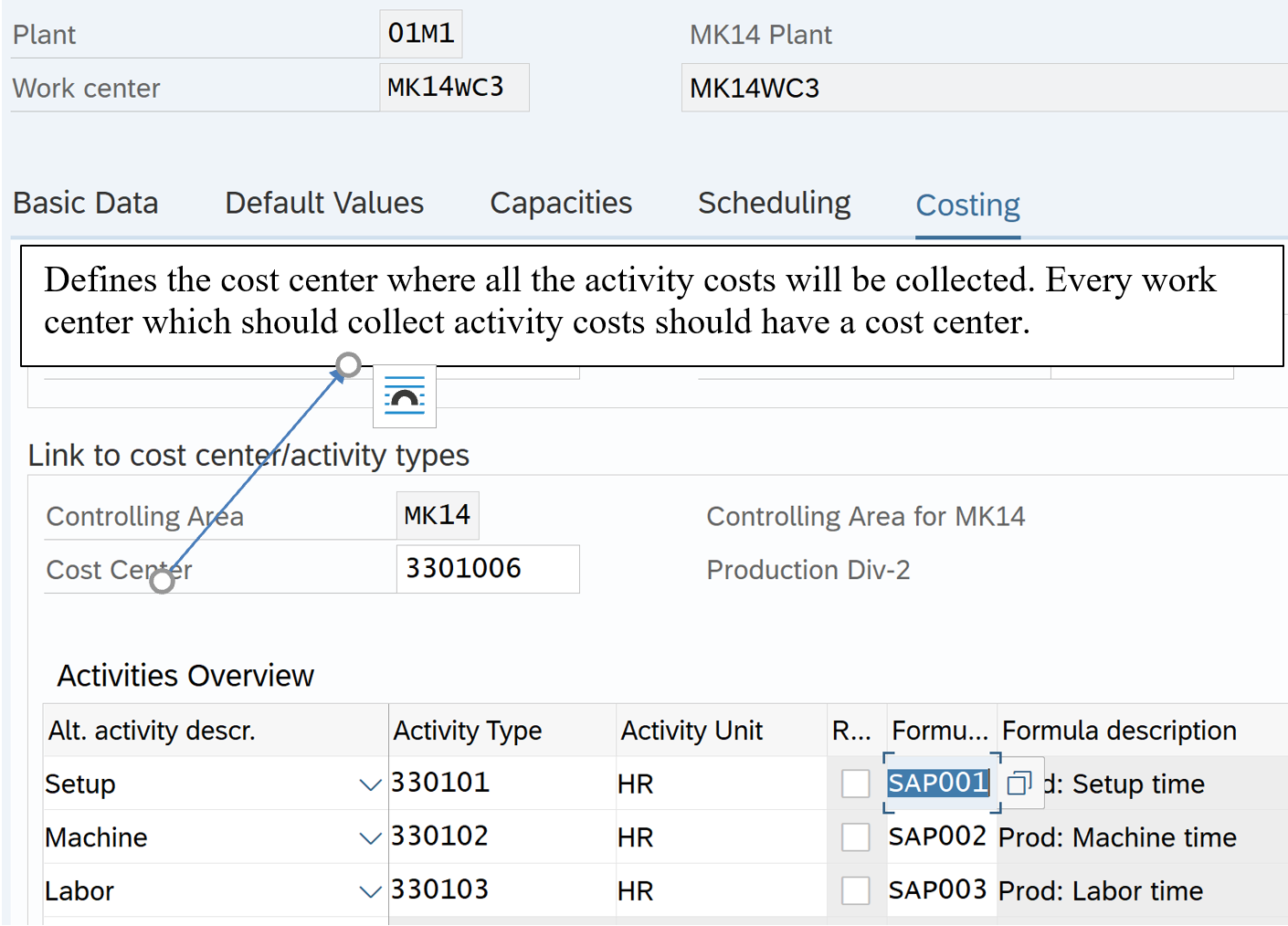

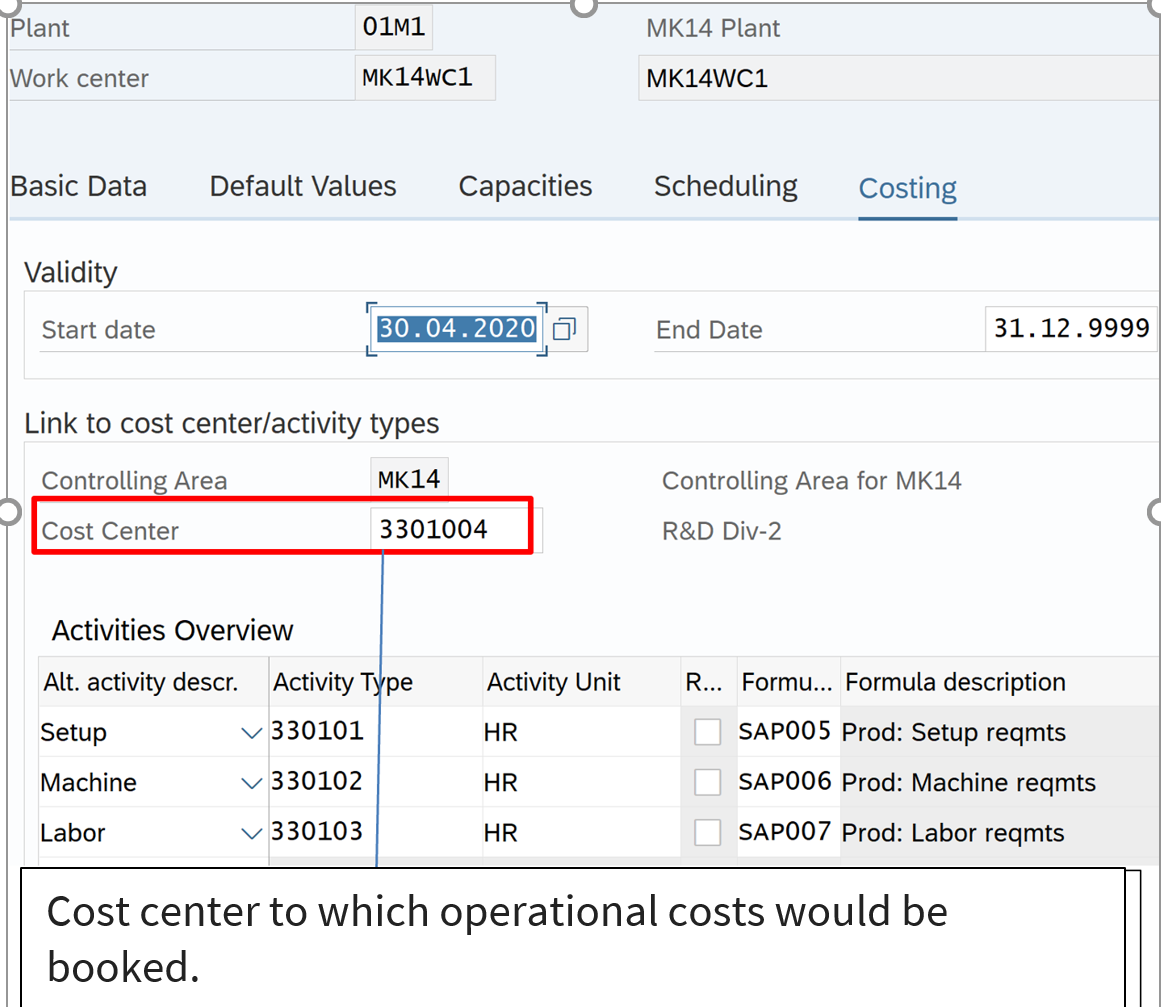

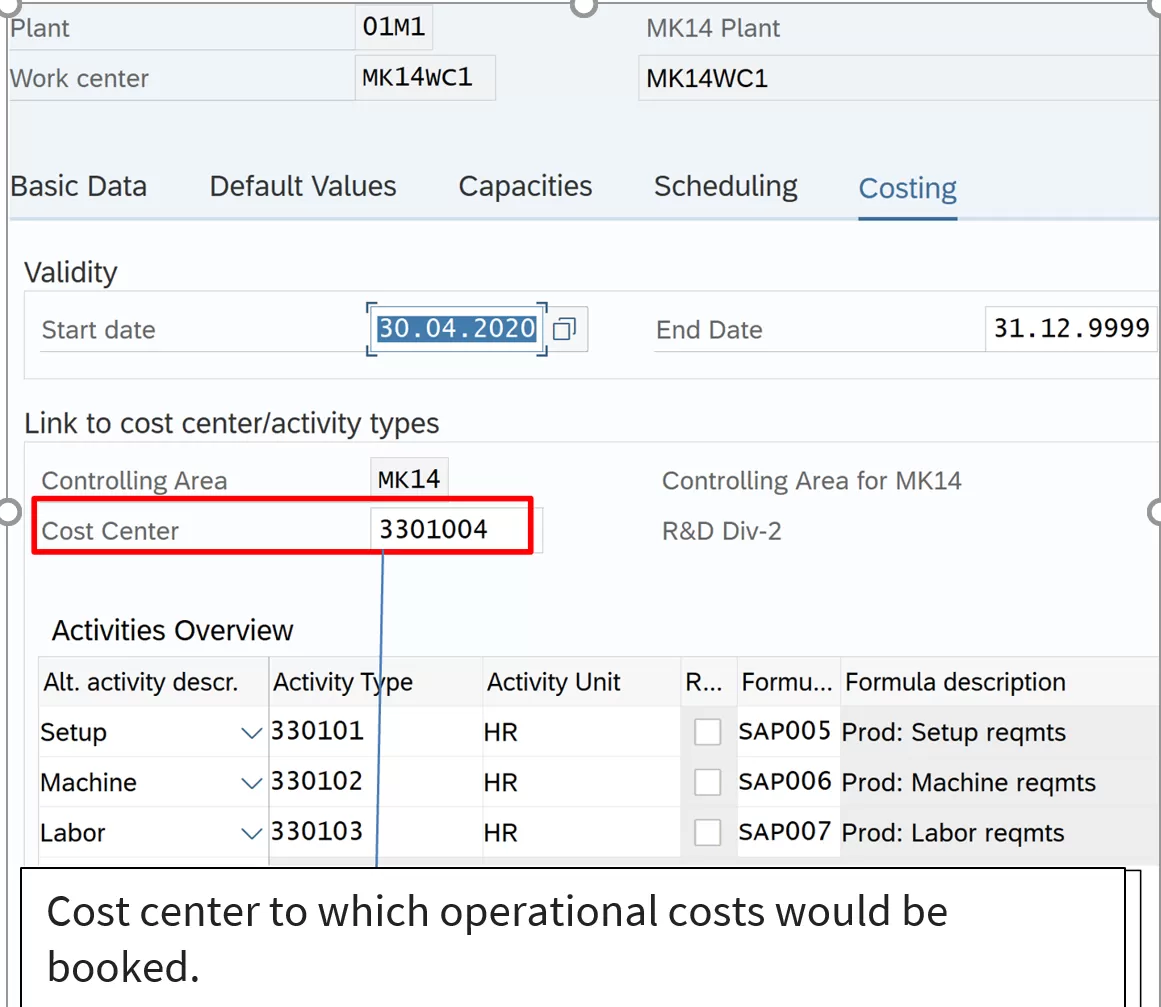

Cost center to which operational costs would be booked.
Similarly create work center 2 and WK Center 3: MK14WC2
Work center MK14WC2 in plant 01M1 was created

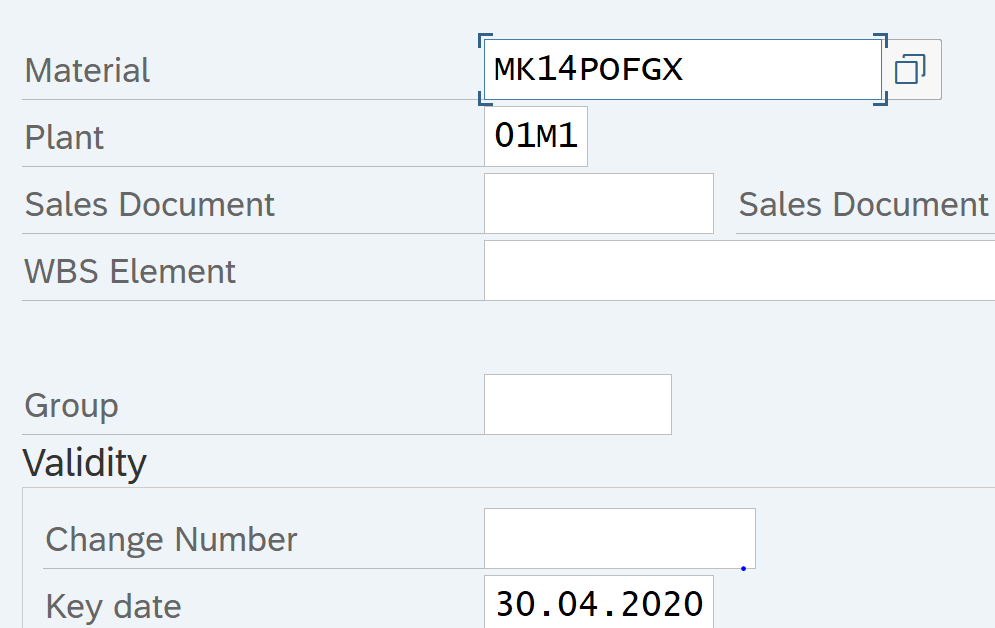

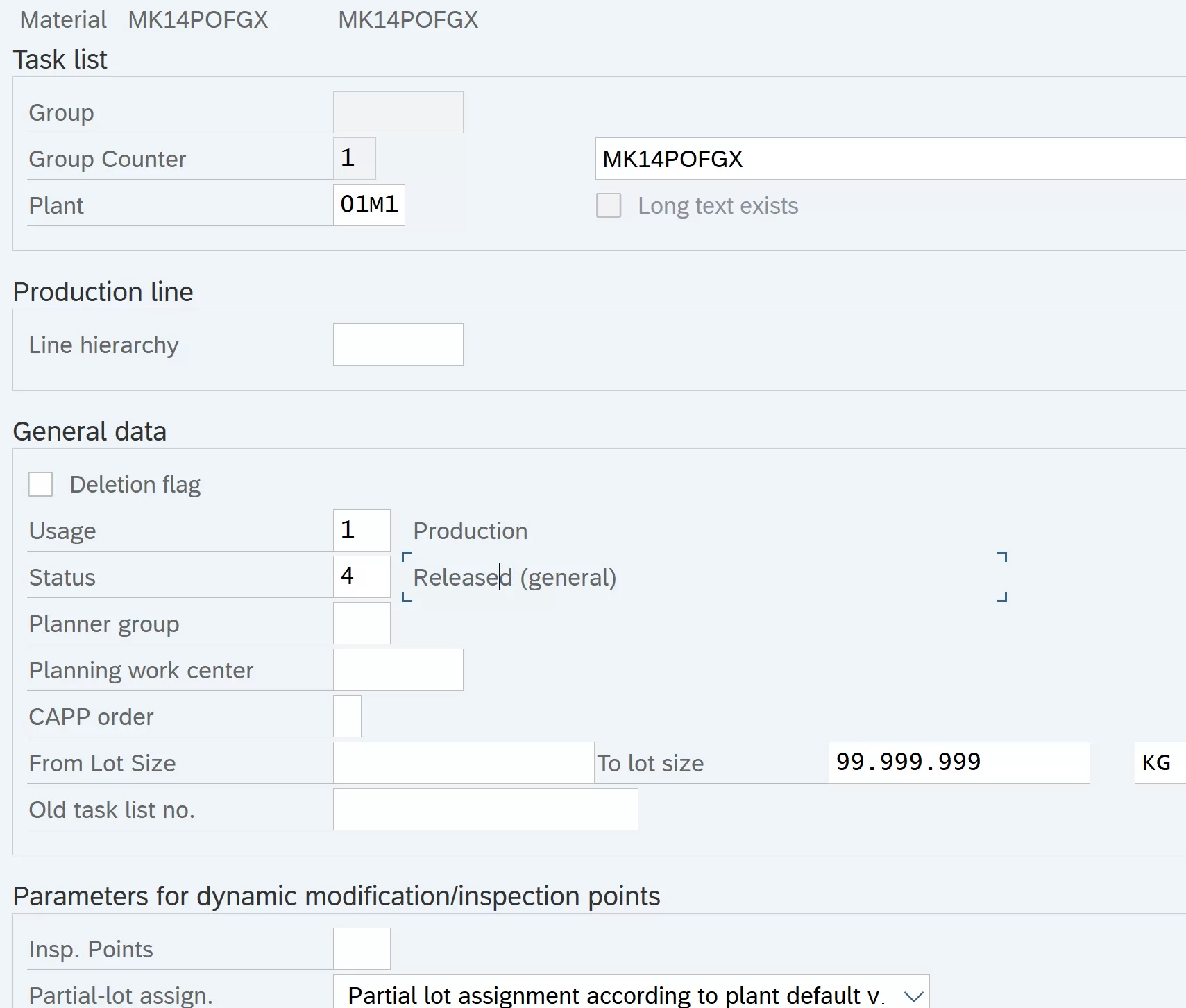

Create Routing
Tcode: CA01
Click Operations tab and enter below data

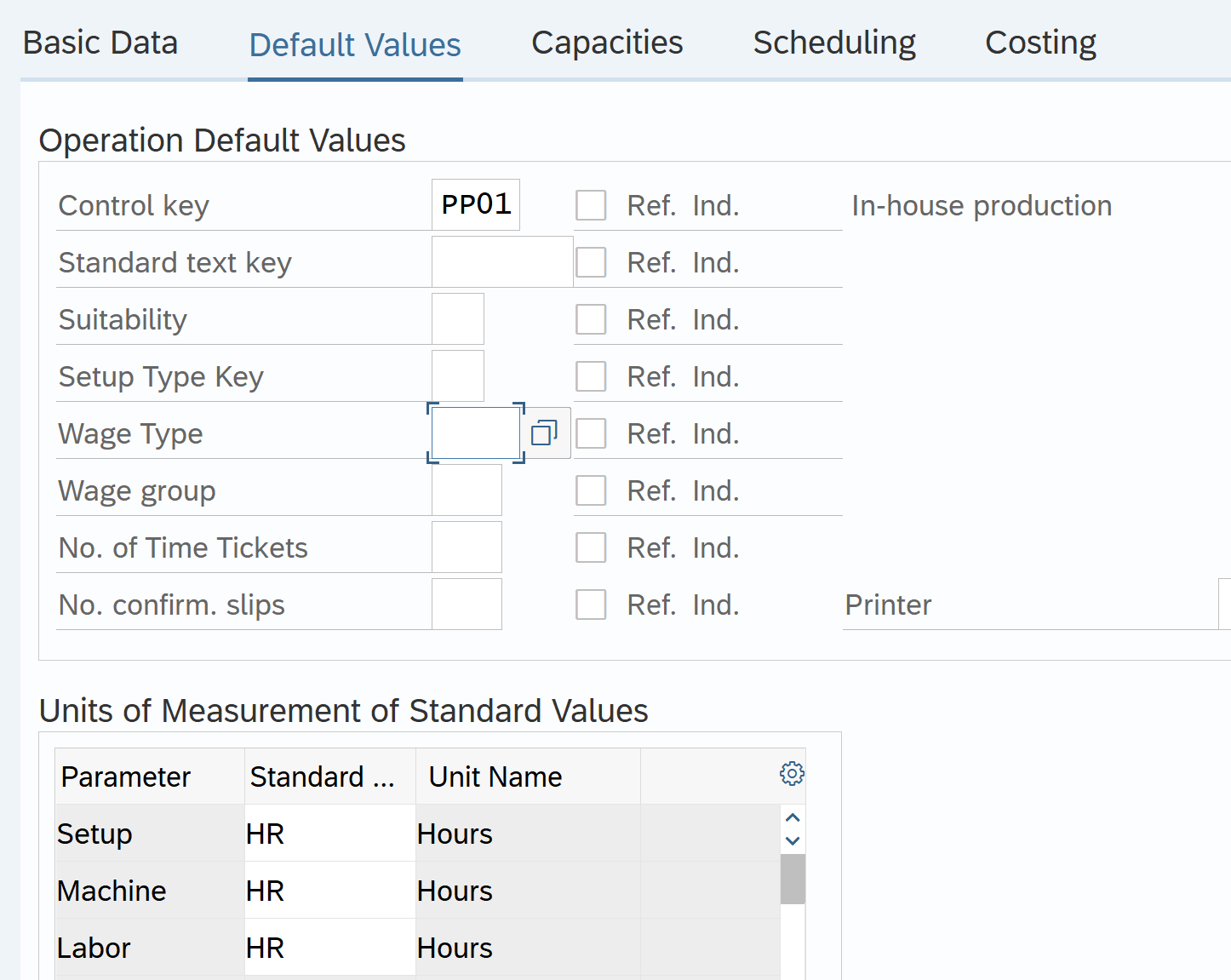

- Control Key PP01: SAP standard for In House Production. Populated from work center
- Base Unit 1: Quantity of finished goods (MK14POFGX) that will be produced by applying these operations in the work center
- MK14WC1: Work Center 1. Will perform 1 hour of Setup activity, 2 hour of Machine activity and 3 hours of labor to produce one unit of FG
- Similarly, for MK14WC2 and MK14WC3

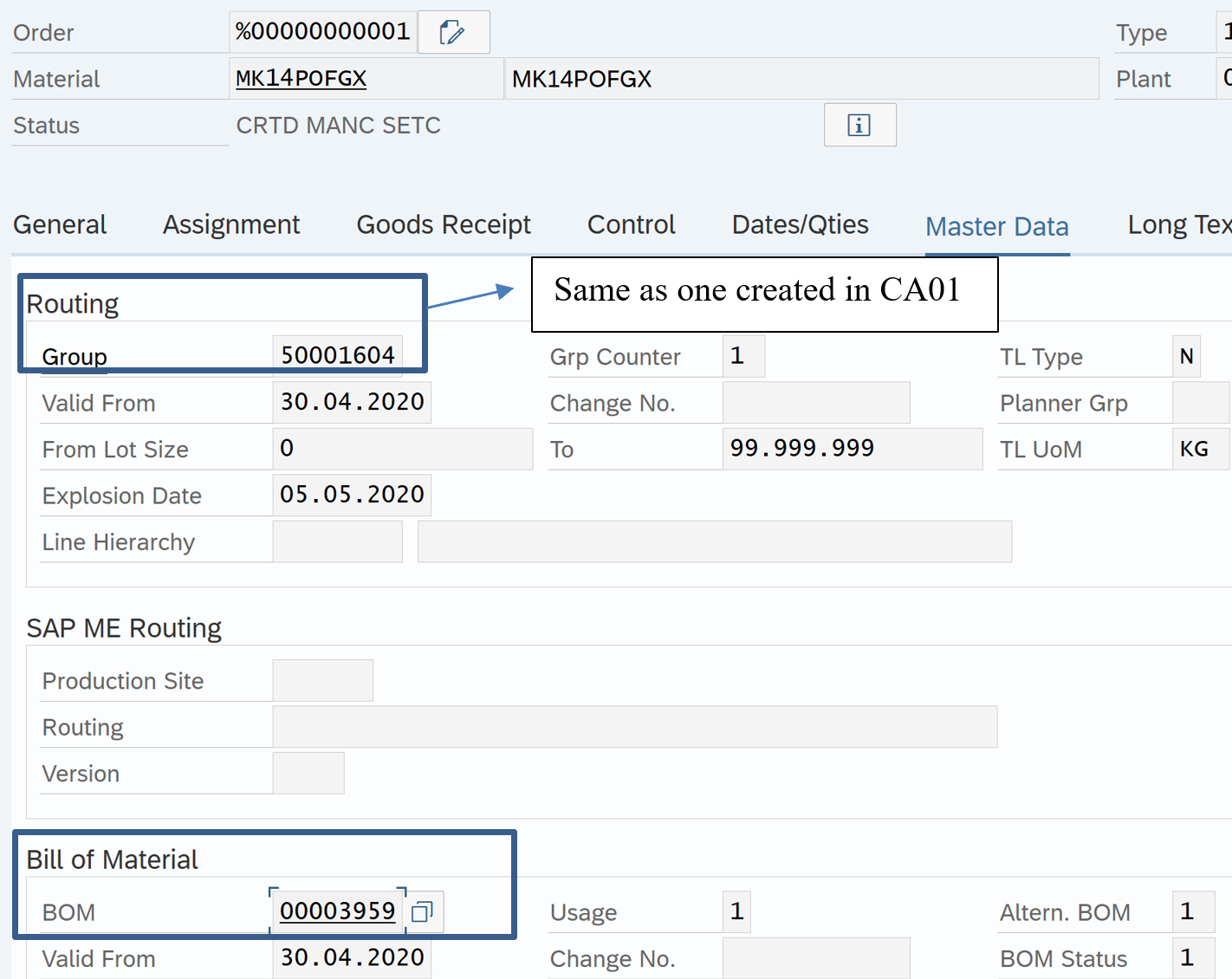

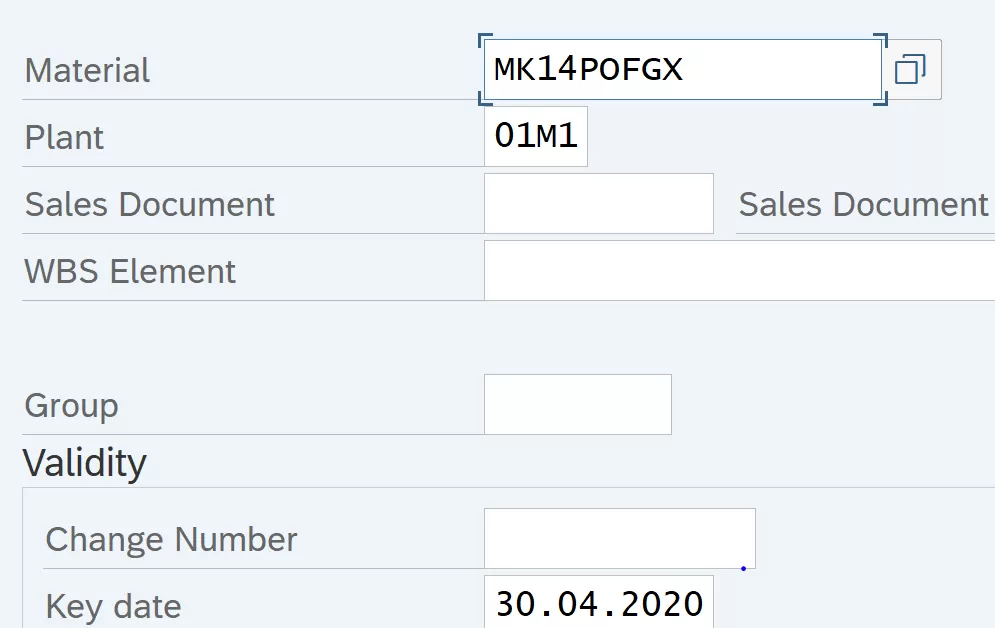

Routing was saved with group 50001604 and material MK14POFGX.
Create Standard Cost

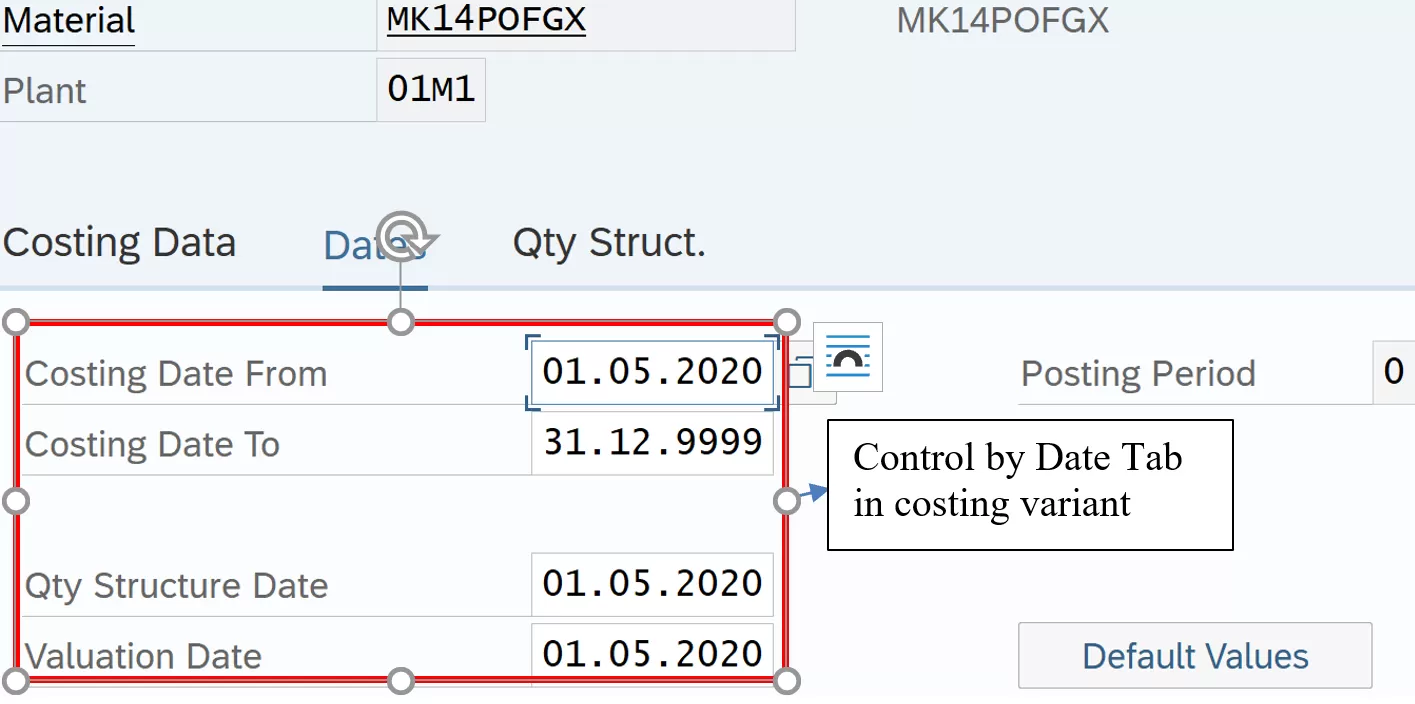

Tcode: CK11N
BOM : CS01 | ||||
FGX | Kg | |||
RMX | 2 | |||
RMY | 3 | |||
Routing: CA01 | Setup Activity | M/C Activity | Labor Activity | Work Center |
Operation 10 | 1 | 2 | 3 | WC 1 |
Operation 20 | 1 | 2 | WC 2 | |
Std Cost Estimation | ||||
Raw Material | Kg | Avg Price | Total | |
RMX | 2 | 300 | 600 | |
RMY | 3 | 400 | 1200 | |
Total Price RMX +RMY | 1800 | |||

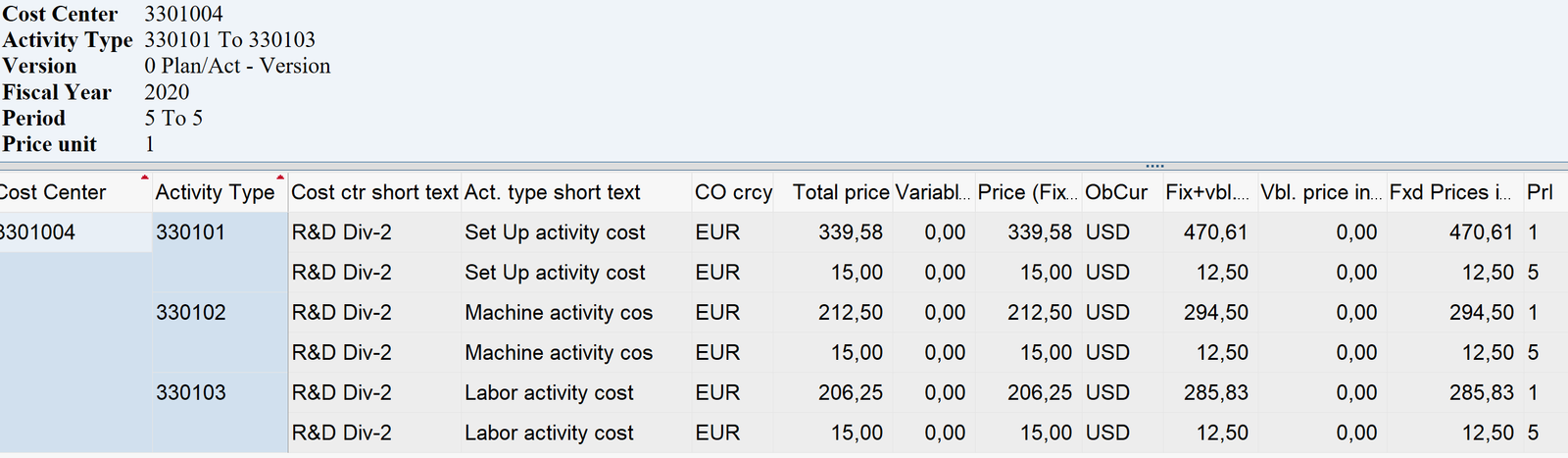

Operation 10 (Price from KSBT) | Hours | Rate/Hr/EUR | Total | |
Setup | 1 | 470 | 470 | |
Machine | 2 | 294 | 588 | |
Labor | 3 | 285 | 855 | |
Total Price OP 10 | 1913 | |||
Operation 20 | ||||
Setup | – | |||
Machine | 1 | 294 | 294 | |
Labor | 2 | 285 | 570 | |
Total Price OP 20 | 864 | |||

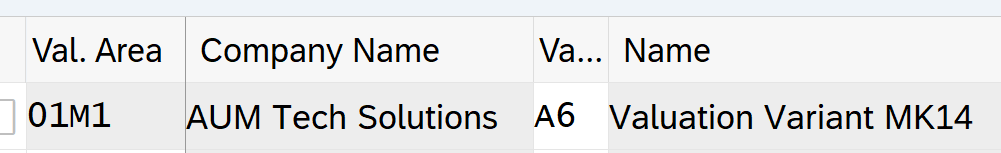

OH (Valuation variant : OKKN) | ||||
MOH | 10% | 1800 | 180 | |
AOH | 15% | 2777 | 417 | |
Total OH Price / Kg | 597 | |||

Standard Cost Estimation for 1 Kg | 5174 |

Create Standard Cost Estimate

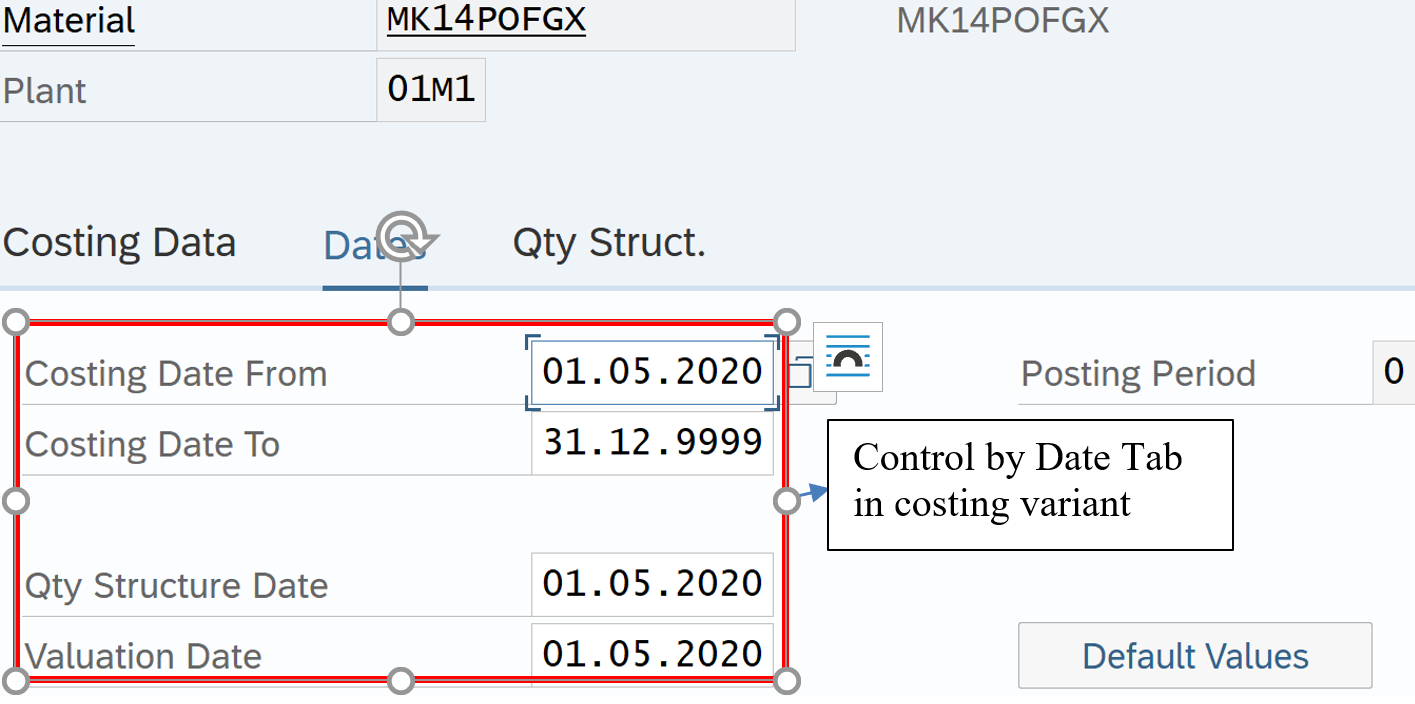

Tcode: CK11N

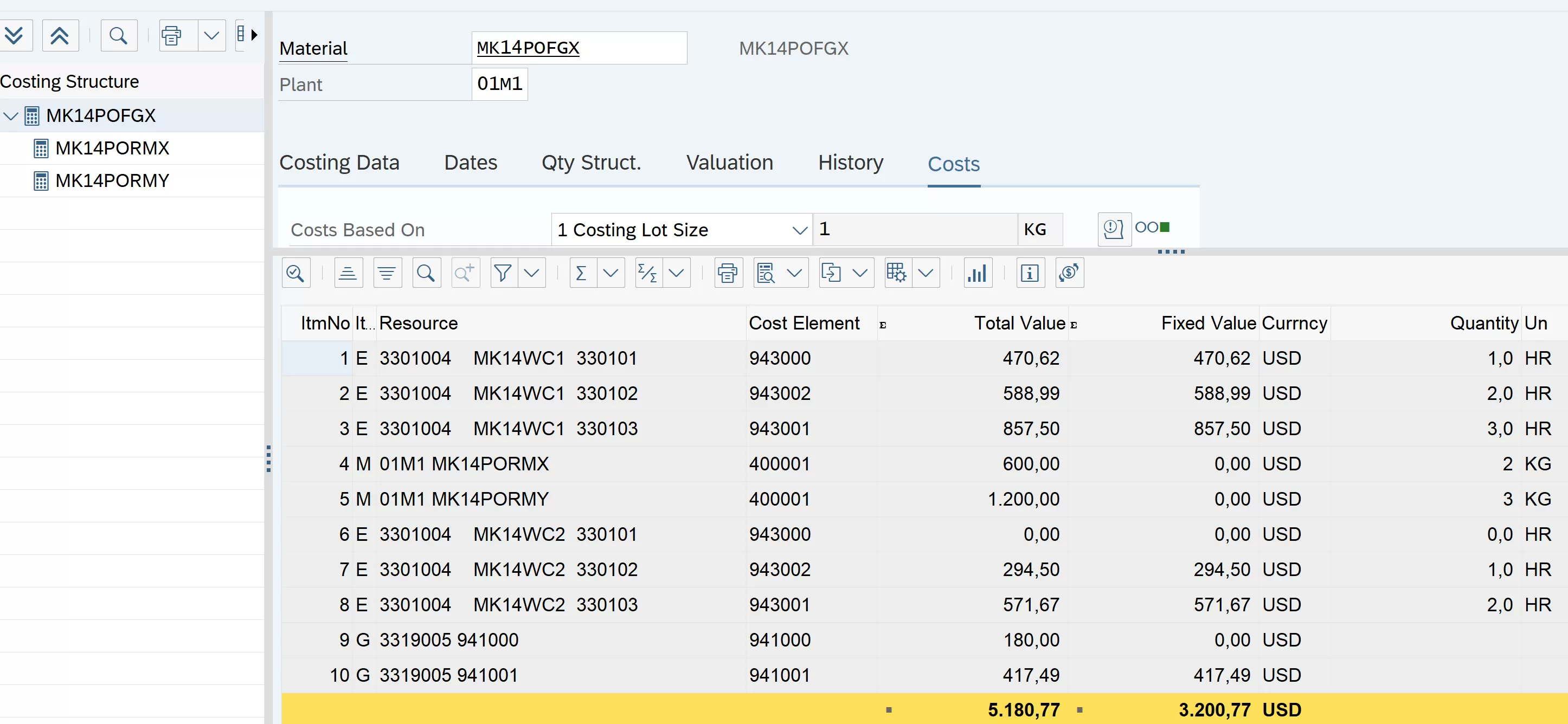

Select for detailed itemized view

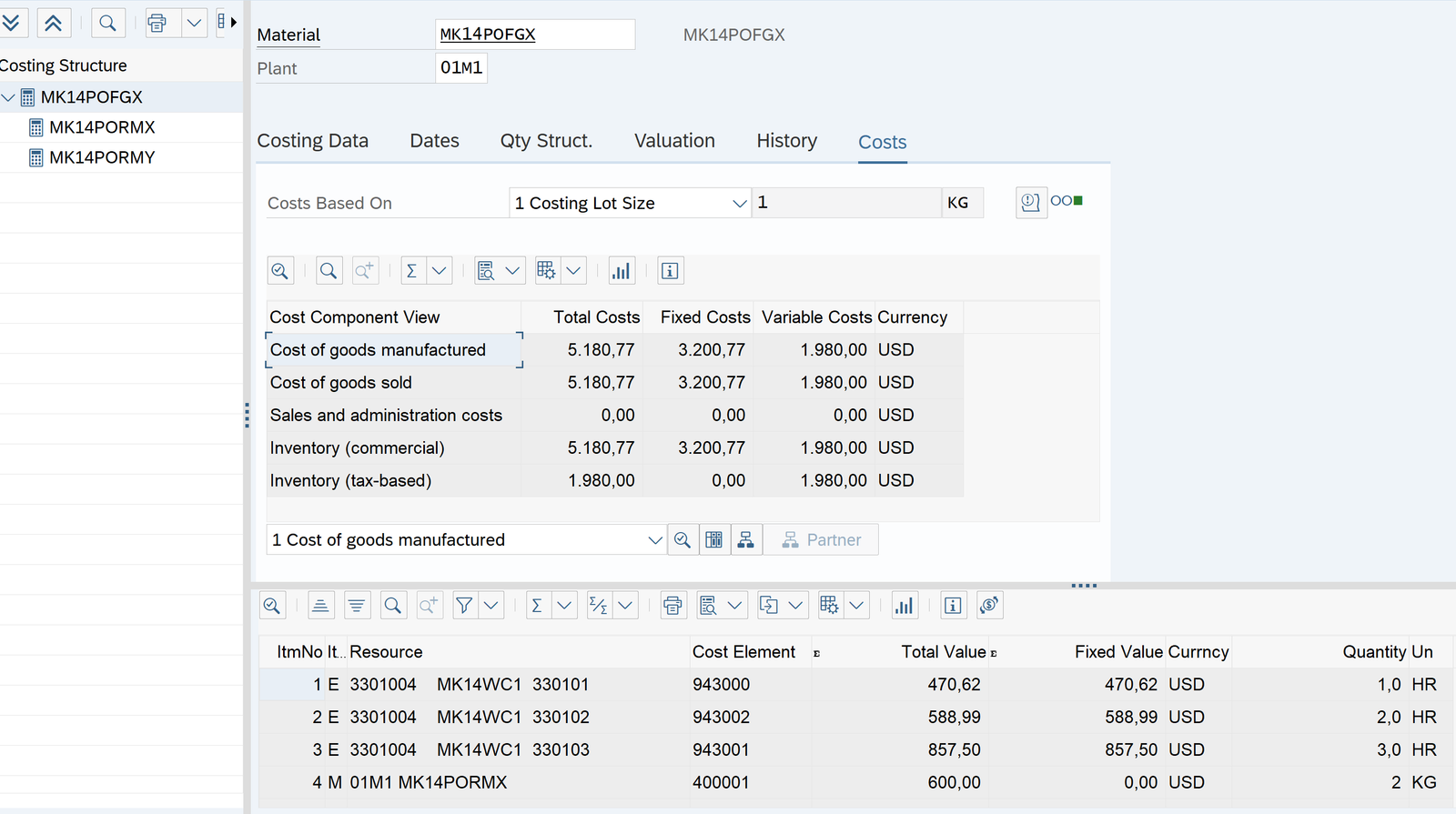

Itemized Product Cost
Calculated Value in the excel
BOM : CS01 | ||||
FGX | Kg | |||
RMX | 2 | |||
RMY | 3 | |||
Routing: CA01 | Setup Activity | M/C Activity | Labor Activity | Work Center |
Operation 10 | 1 | 2 | 3 | WC 1 |
Operation 20 | 1 | 2 | WC 2 | |
Std Cost Estimation | ||||
Raw Material | Kg | Avg Price | Total | |
RMX | 2 | 300 | 600 | |
RMY | 3 | 400 | 1200 | |
Total Price RMX +RMY | 1800 | |||
Operation 10 (Price from KSBT) | Hours | Rate/Hr/EUR | Total | |
Setup | 1 | 470 | 470 | |
Machine | 2 | 294 | 588 | |
Labor | 3 | 285 | 855 | |
Total Price OP 10 | 1913 | |||
Operation 20 | ||||
Setup | – | |||
Machine | 1 | 294 | 294 | |
Labor | 2 | 285 | 570 | |
Total Price OP 20 | 864 | |||
OH (Valuation variant : OKKN) | ||||
MOH | 10% | 1800 | 180 | |
AOH | 15% | 2777 | 417 | |
Total OH Price / Kg | 597 | |||
Standard Cost Estimation for 1 Kg | 5174 |

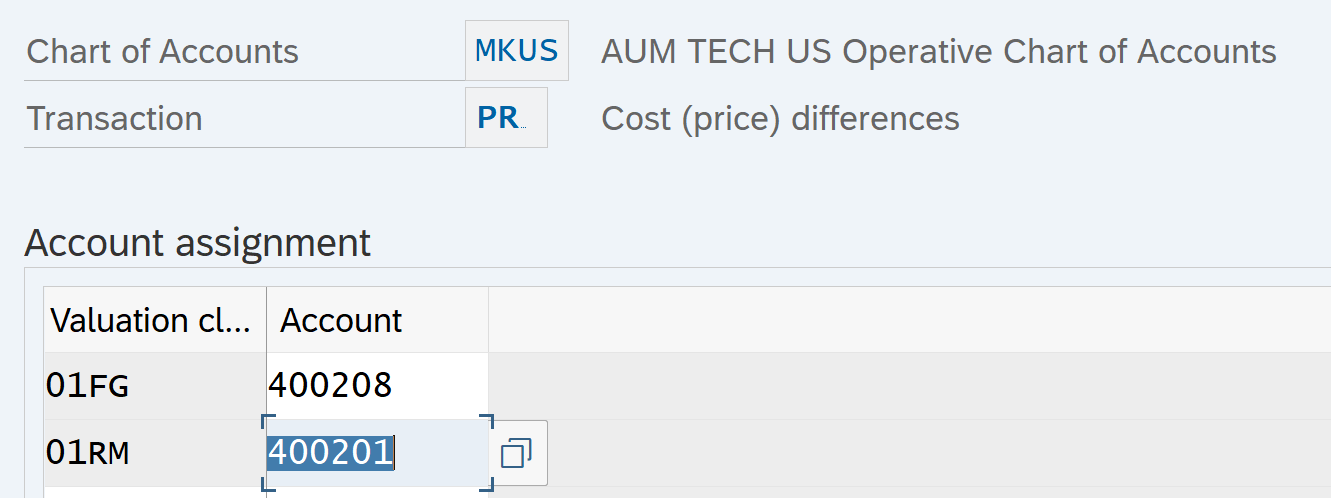

If error add below entries in OBYC – GBB
KSBT
Per Unit price match

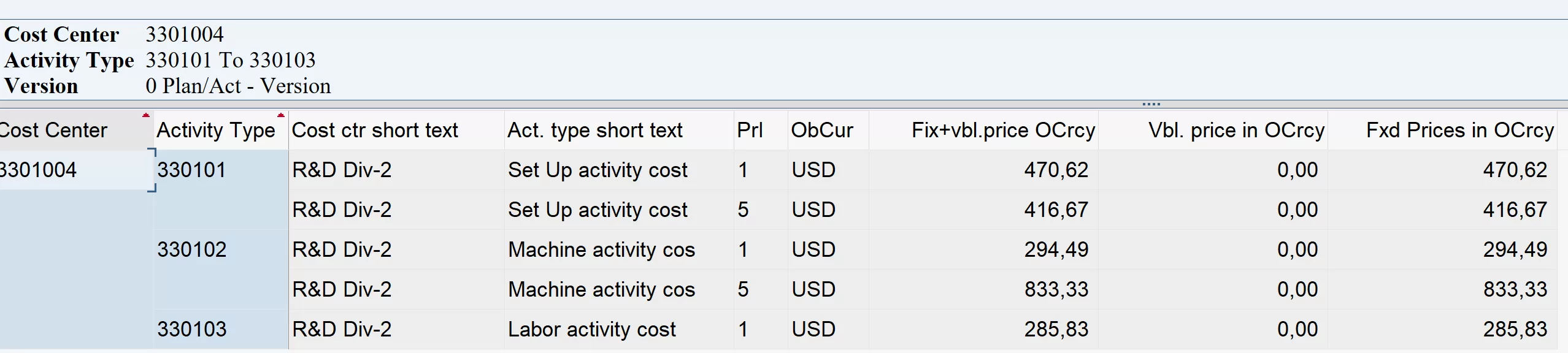

330101 | Set Up activity cost | 470 |
330102 | Machine activity cost | 294 |
330103 | Labor activity cost | 285 |
Prl: 1 : Planned Price
Prl 5: Actual Price

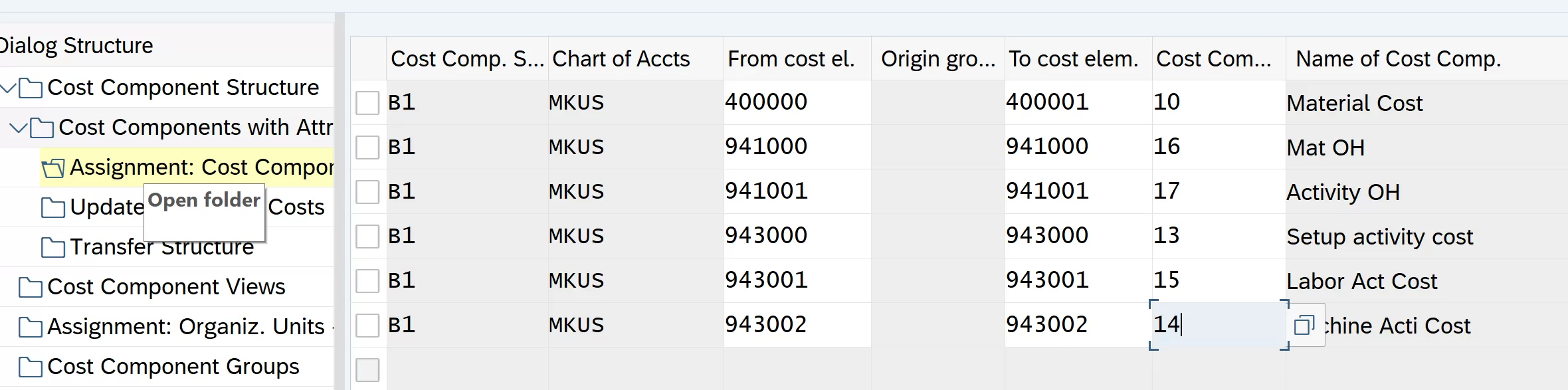

OKTZ ( Cost Component Structure to check errors)
If error in log don’t save. Material can be re costed. It cannot be re costed after saving

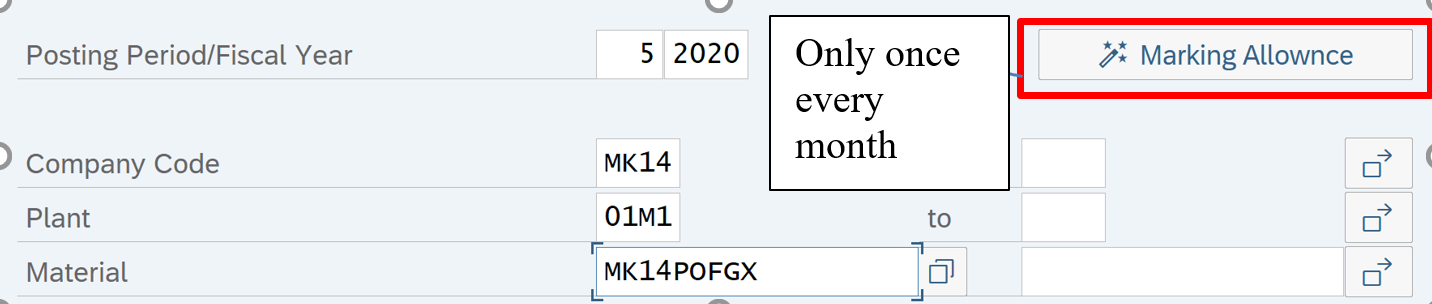

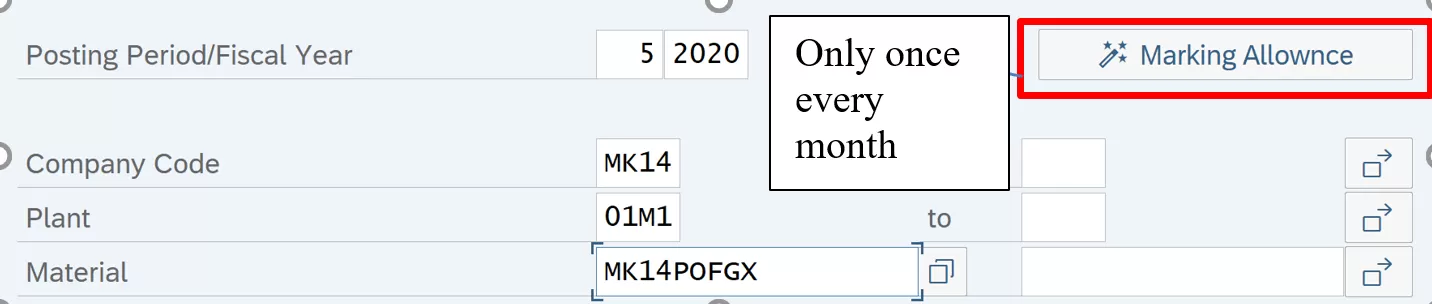

Mark and Release Standard Cost Estimation

Transaction code: CK24

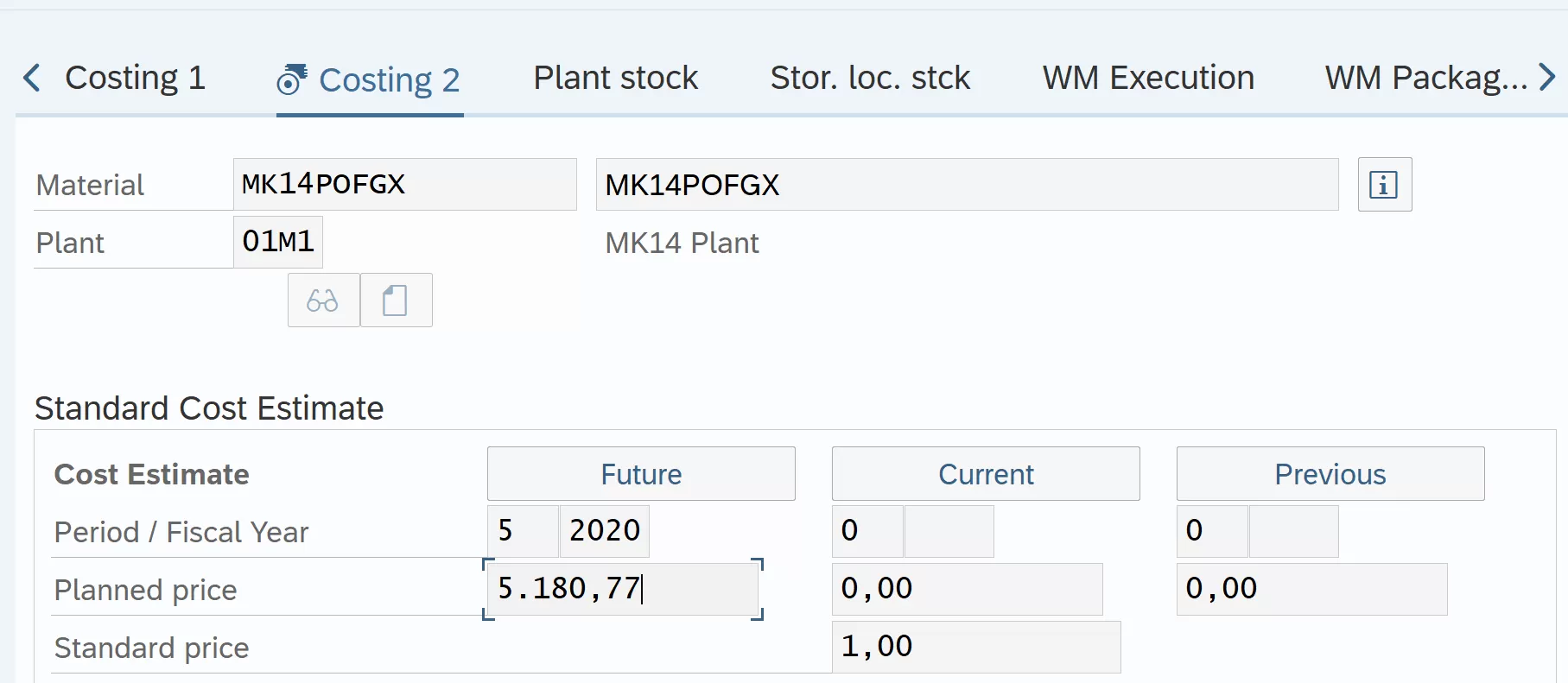

Mark | Standard cost updated as future price in costing tab 2 |
Release | Future price now becomes current price in costing tab 2 |
Standard cost updated as standard cost in accounting tab 1 in MM02 |
May have to close MM period in MMPV
Display Standard cost with cost component structure

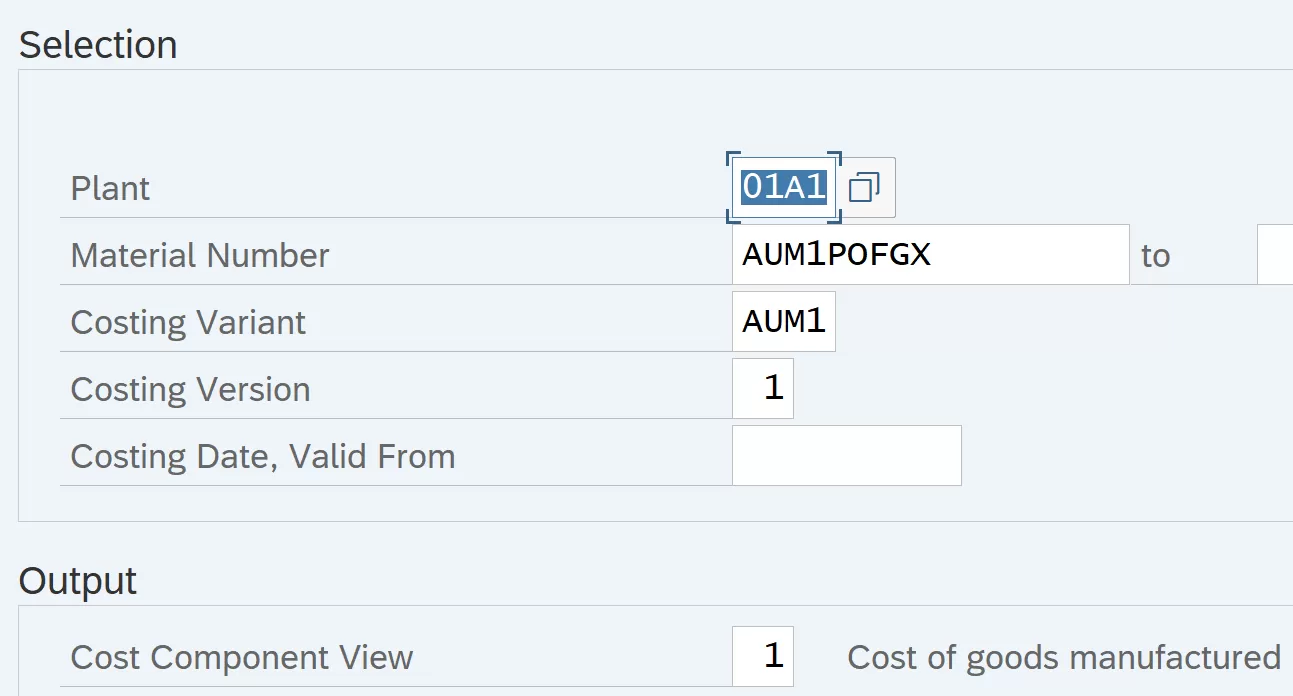

Transaction Code: CK13N
Standard Cost Report: S_P99_41000111
Standard Cost Report: S_P99_41000111
Product Costing Tables
s.no. | Tables | Description |
1 | KEKO | Product Costing – Header Data |
2 | CKIS | Items Unit Costing/Itemization Product Costing |
Product Costing – Actual Cost
We have calculated standard / estimated cost of FG. Now we will create a Production Order and calculate actual cost of FG. Difference between actual cost and Standard / estimated cost will be the variance

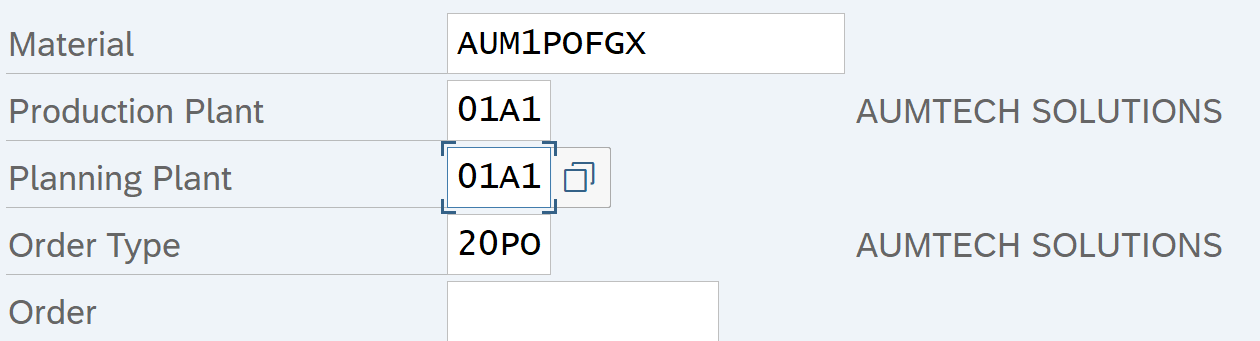

Create Production Order: CO01

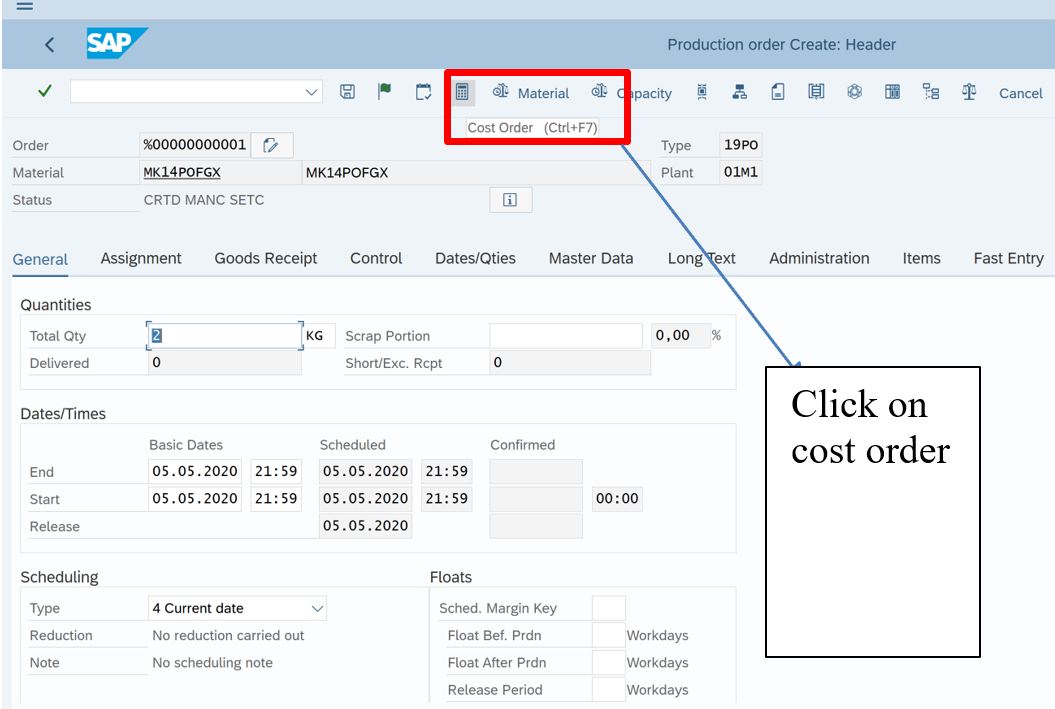

Now click Cost Order button. This will calculate the Planned cost of the Production Order. Standard cost is always for 1 unit. Planned cost is for the total production order unit (3 kg in this case). Thus, FC per unit differ between standard cost and planned cost

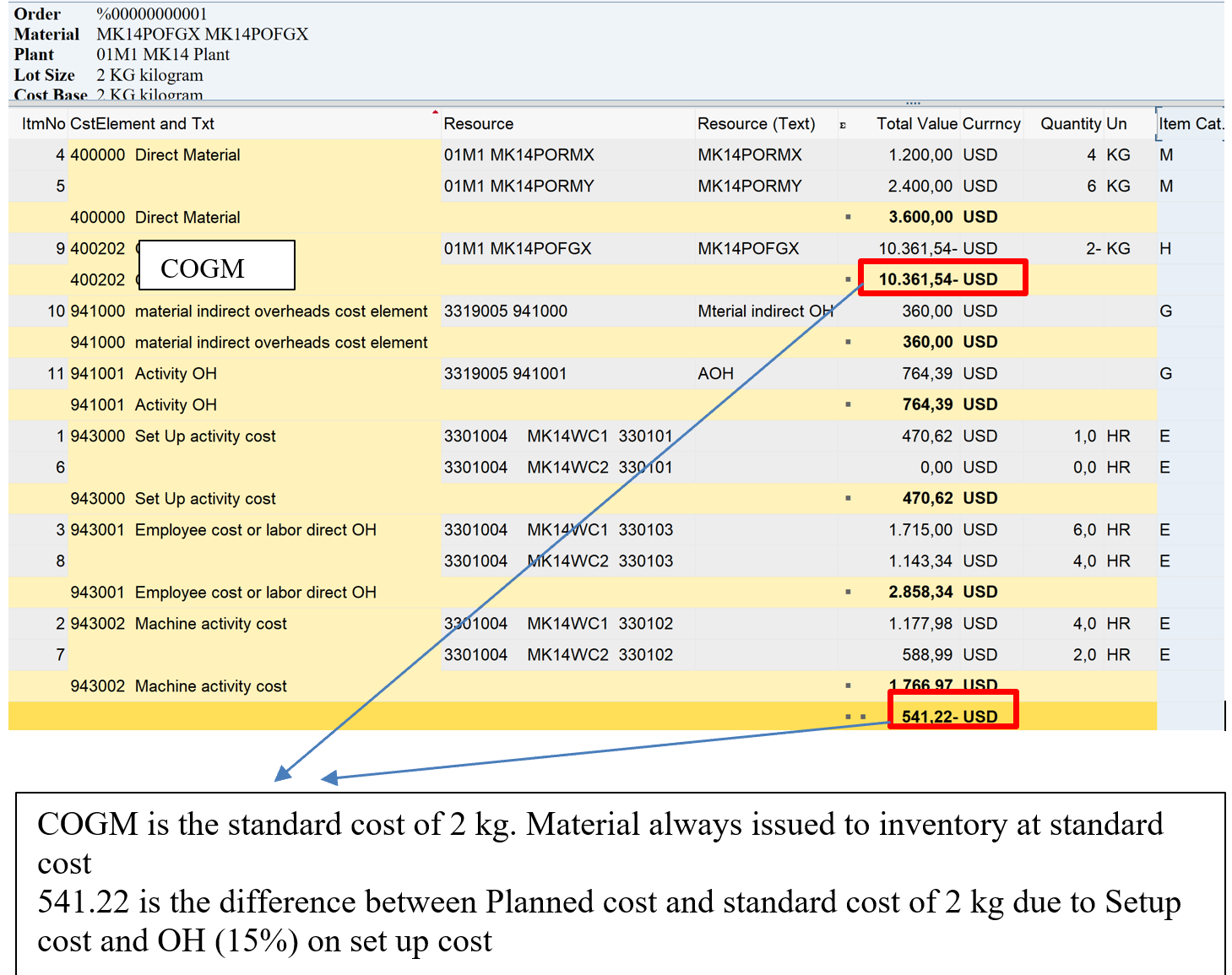

Click Goto – Cost – Itemization to view the planned cost
Planned cost Material = 2 Kg (BOM) * 3 Kg (Prod Order) = 1800
Planned cost Material OH = 10% OF 1800 (Costing Sheet) = 180

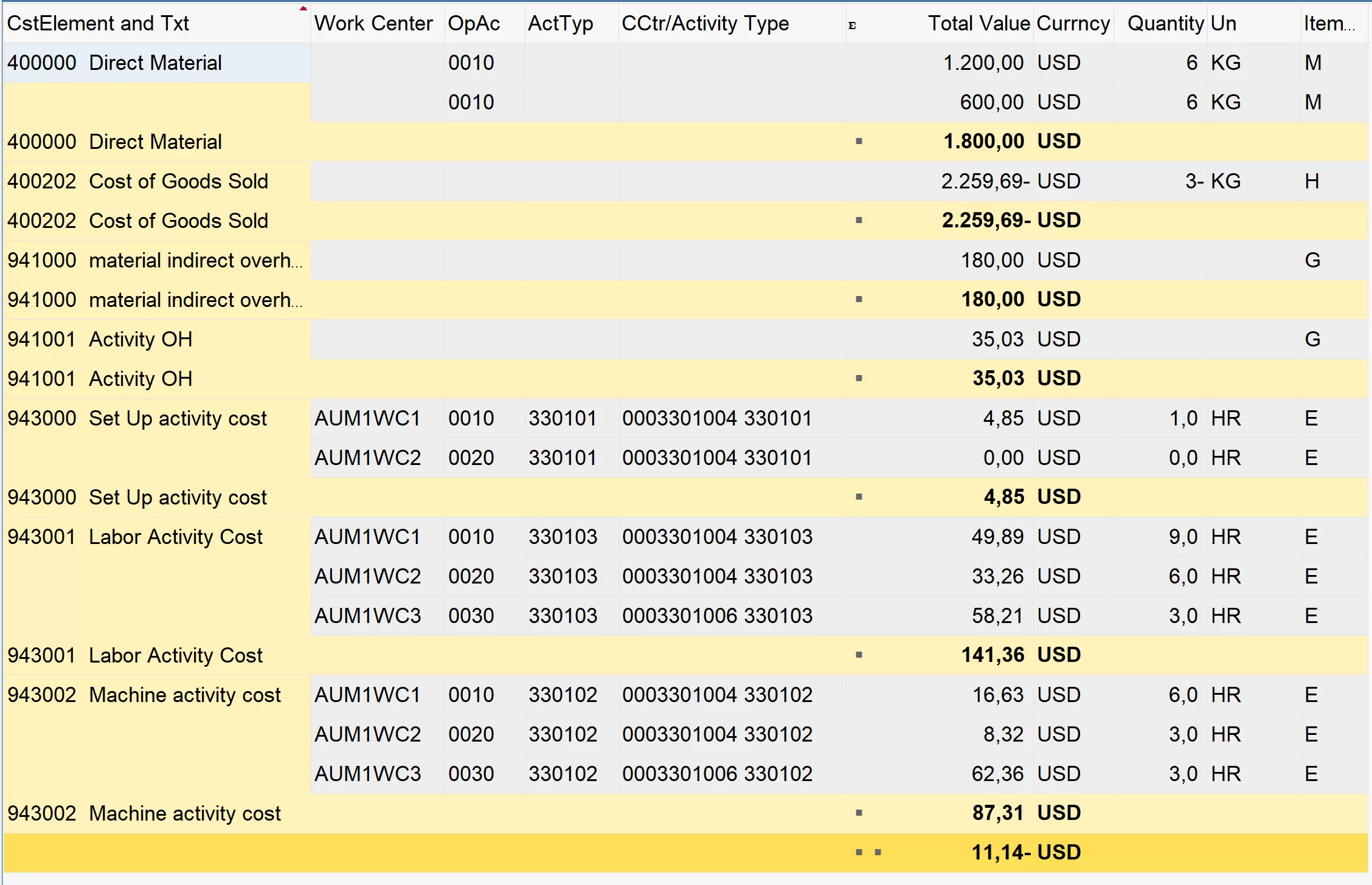

Planned cost activity OH = 15% of total activity cost (268) = 35

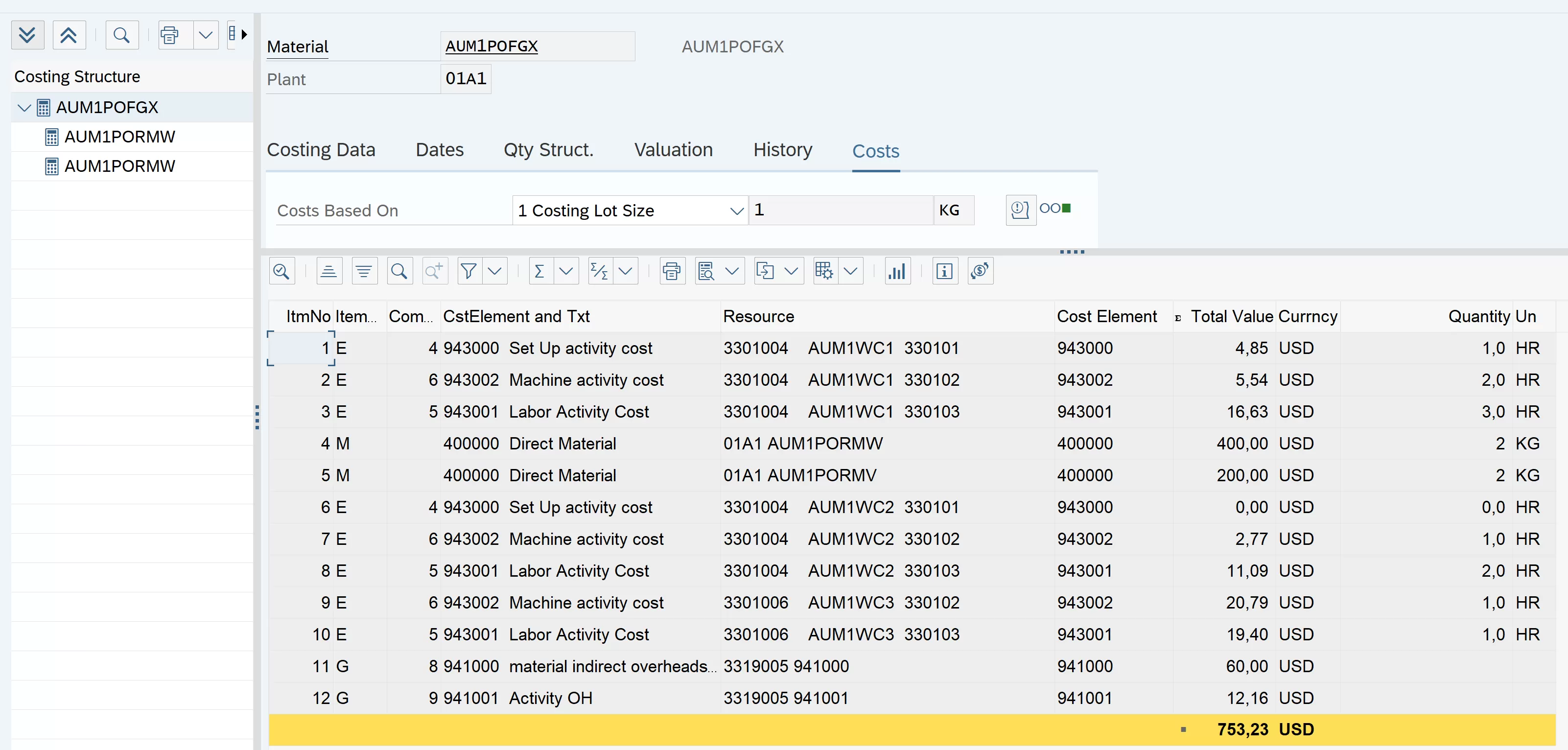

COGM / COGS = 3 (Prod Order Qty) * Standard Cost (753.23) = 2259
Create Purchase Order for Raw Material: ME21N
Standard PO (SAP) created under the number 4500043447

Raw Material Receipt from Vendor: MIGO
MIGO – Display

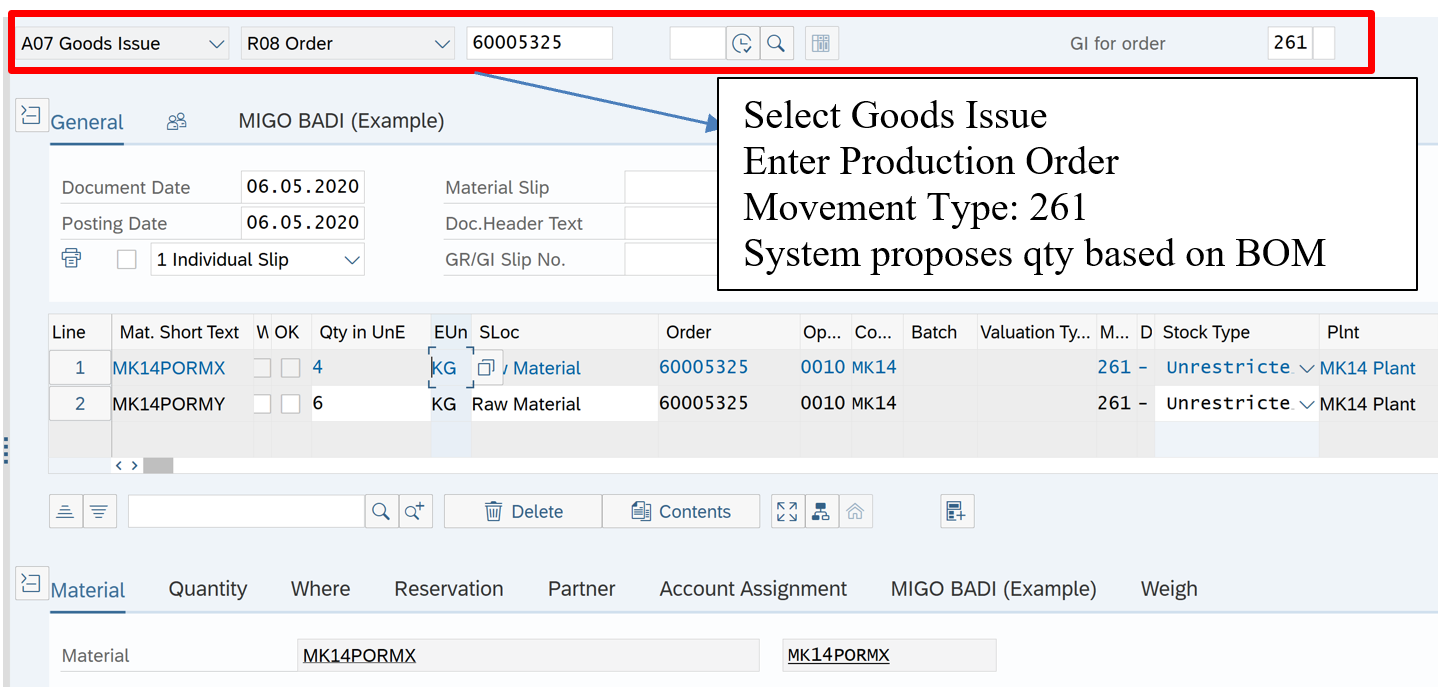

Issue Raw Material to Production Order: MIGO

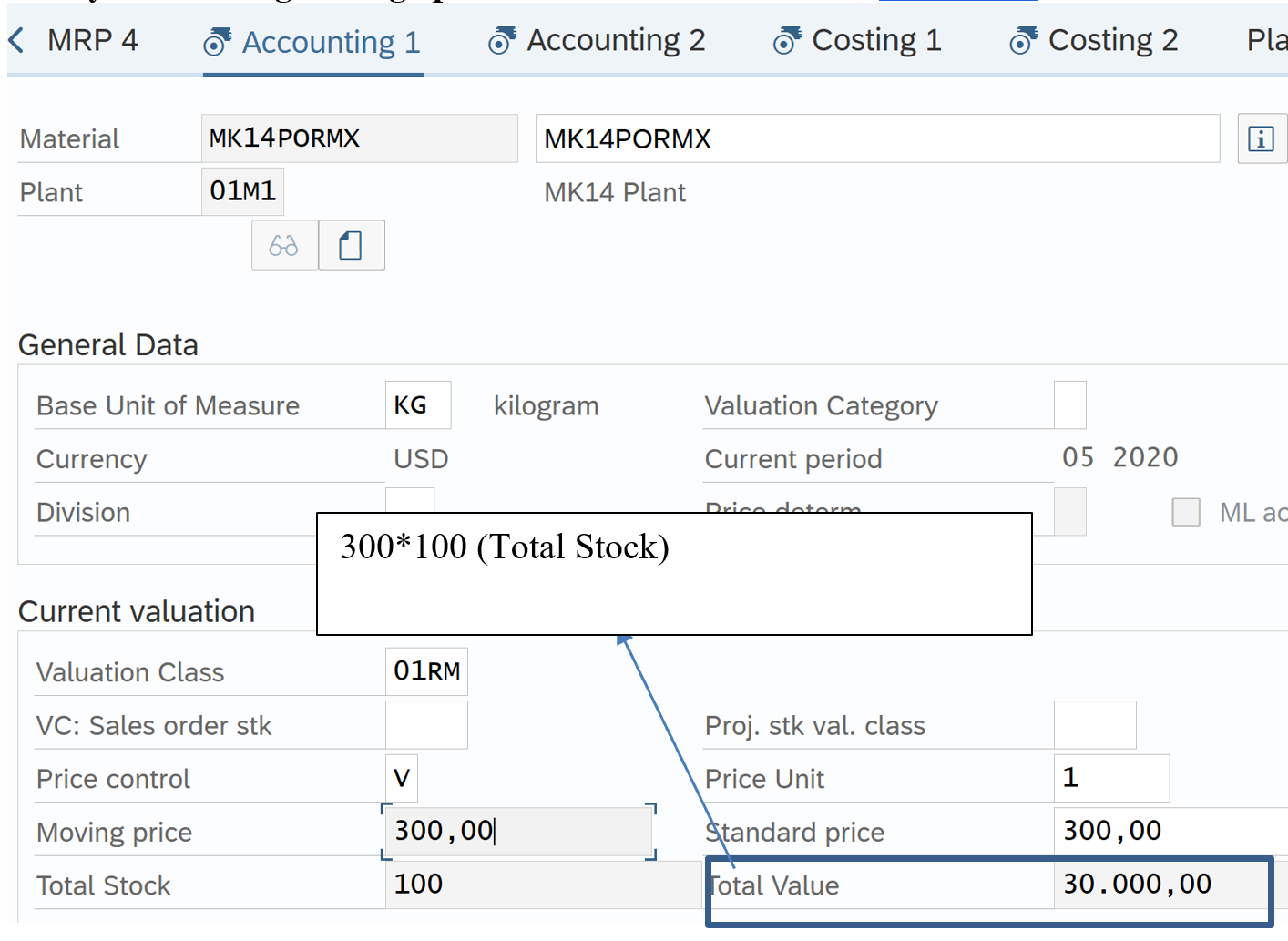

Raw Material Issued to Production at Moving average price. Check in MM03
Moving average Price MM03
Go to Operations and confirm actual hours spent on converting Raw Material to FG: CO11N
- Display Standard cost estimate: CK13N
- We have calculated Standard cost / Estimated cost of the finished product. Now we will manufacture finished good and calculate its actual cost. Then find variances between standard cost and actual cost
Steps to manufacture finished goods, find actual cost and month end product costing activities

- Create Production Order to manufacture FG: CO01
- When Production is saved Planned cost of FG is calculated in the production order. Now standard cost is always for 1 kg of material. Planned cost is for the total Production order material which can be 2 kg or more. There is difference between Standard cost and Planned cost due to fixed cost being same in both
- Create Purchase Order for the Raw Material: ME21N

- Raw Material Receipt from vendor: MIGO

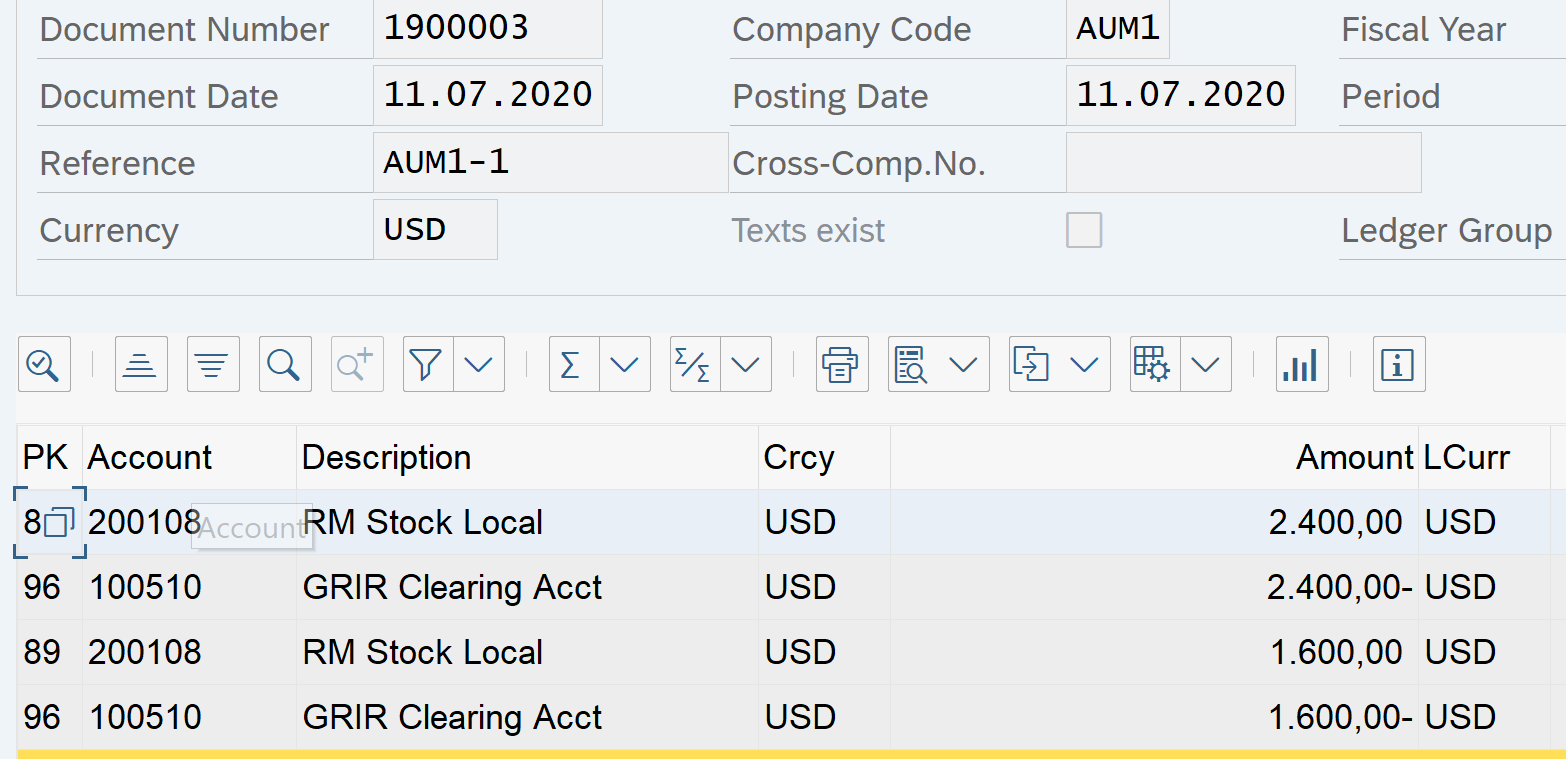

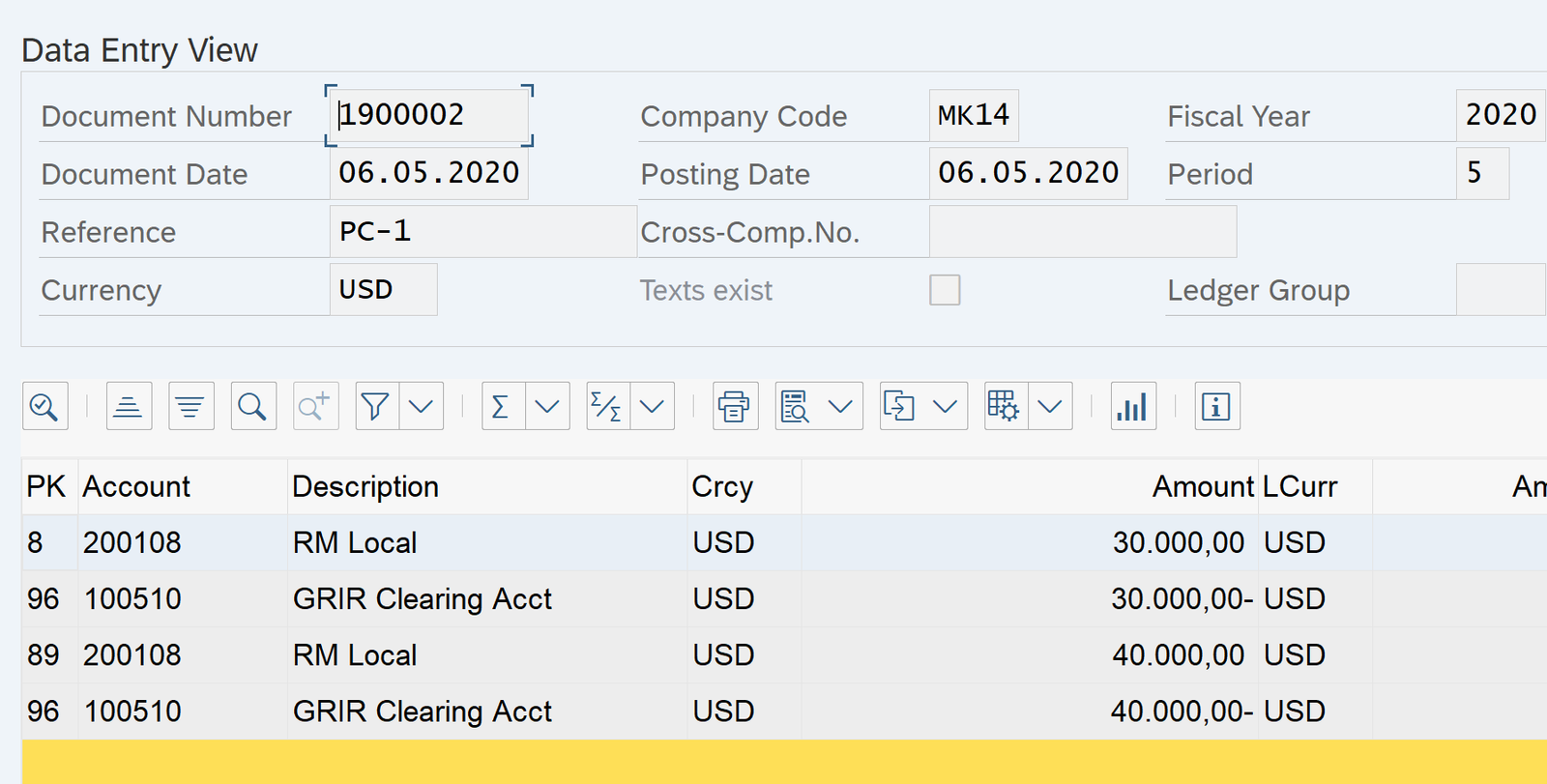

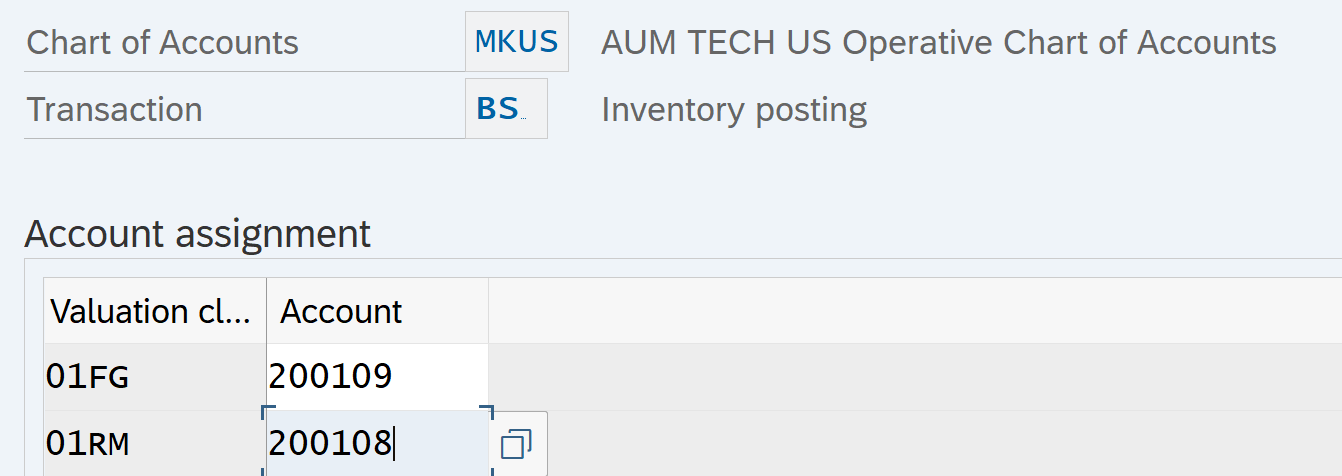

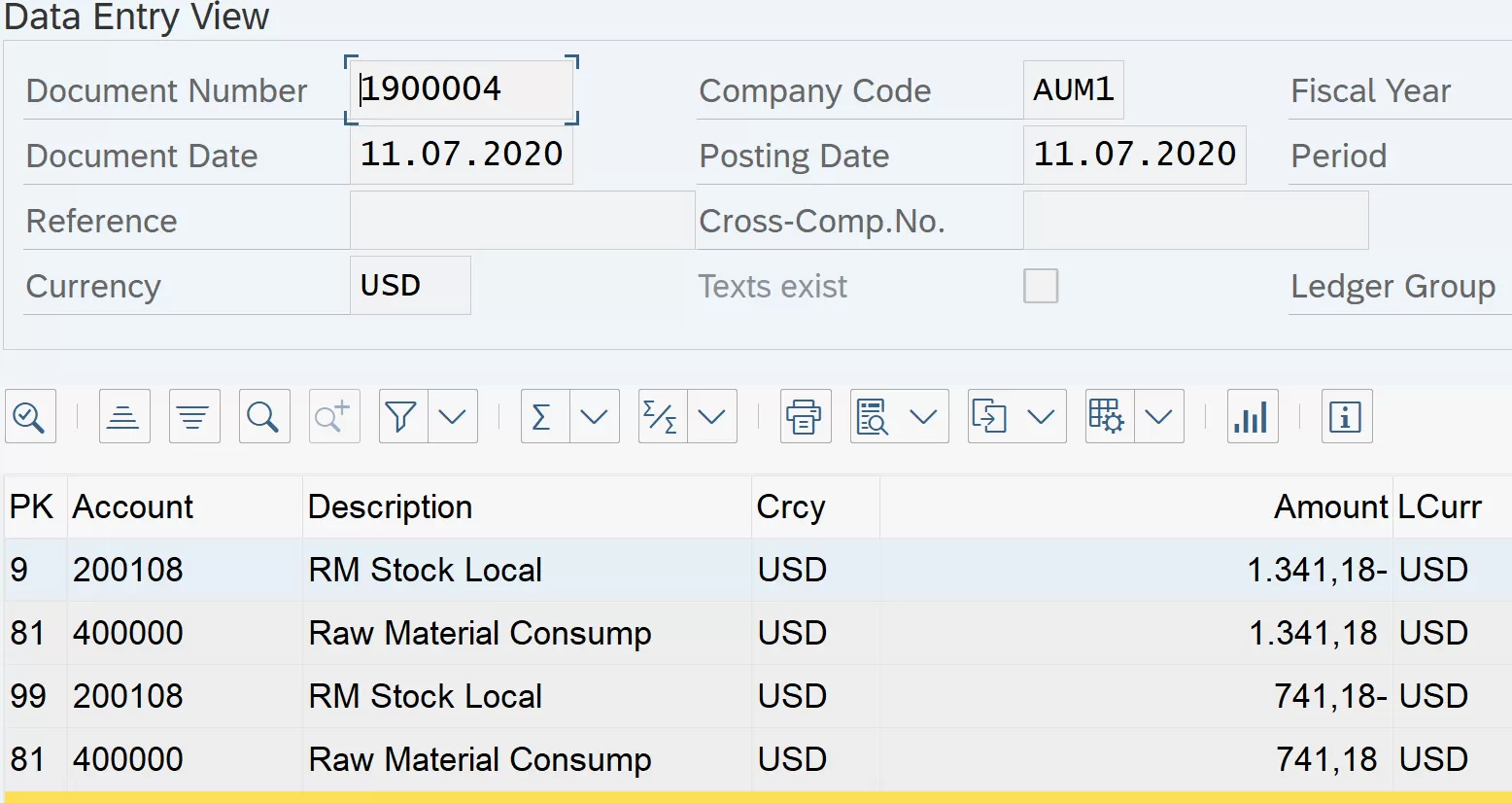

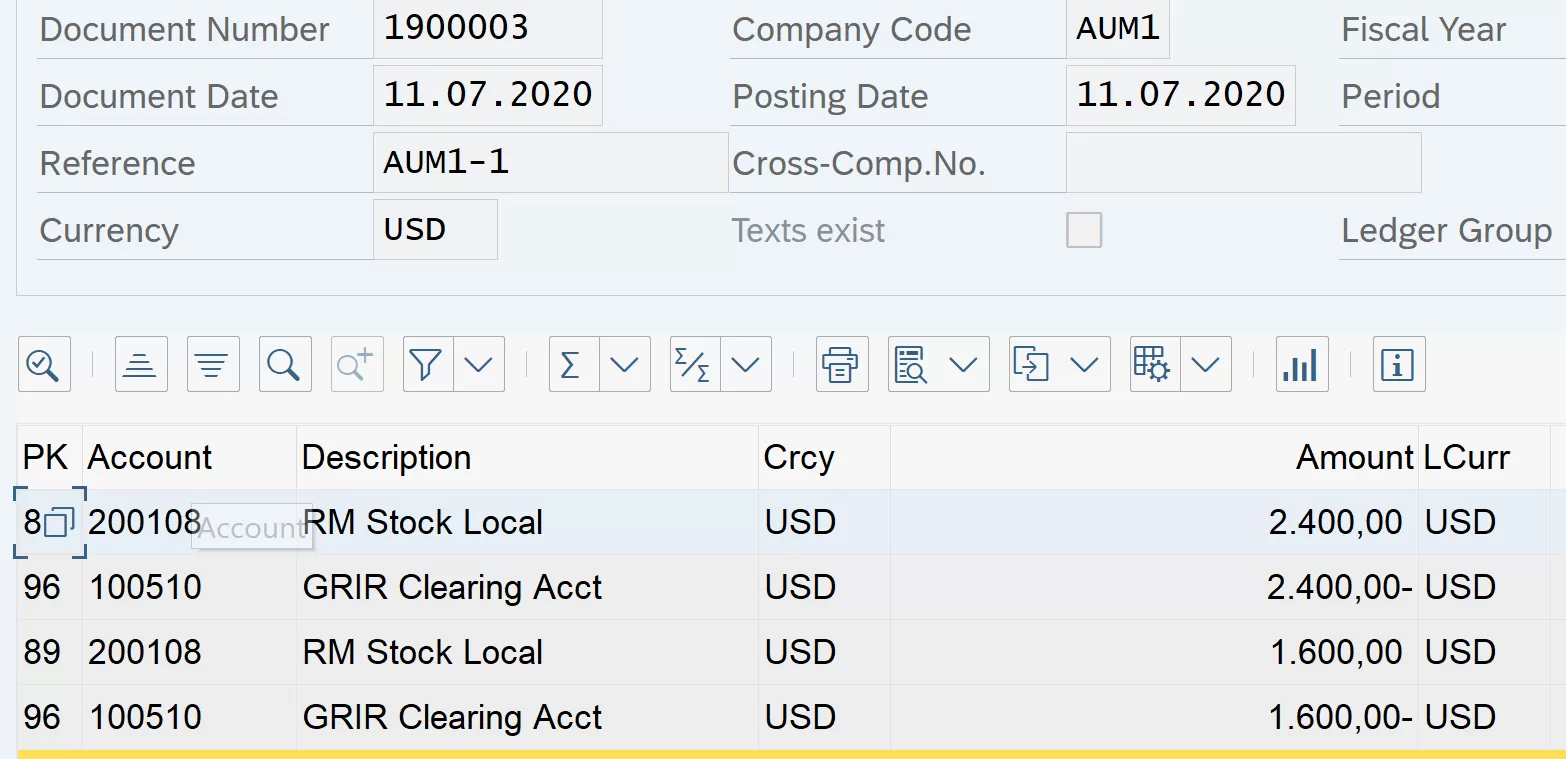

- Inventory GRN Posting: OBYC-BSX: 200108 (RM) DR to GRIR 100510 CR

- Issue Raw Material to Production Order: MIGO
- Go to Operations / Work Enter. Enter and confirm the actual hours spent production FG in each work center: CO11N
- Display Production Order: CO03 – Go to Cost Analysis – Actual cost will now be updated with actual operations hours
- As the Raw Material is converted to Finished goods in the Production Order. Issue Finished goods to inventory from Production Order: MIGO
- Accounting Entry:

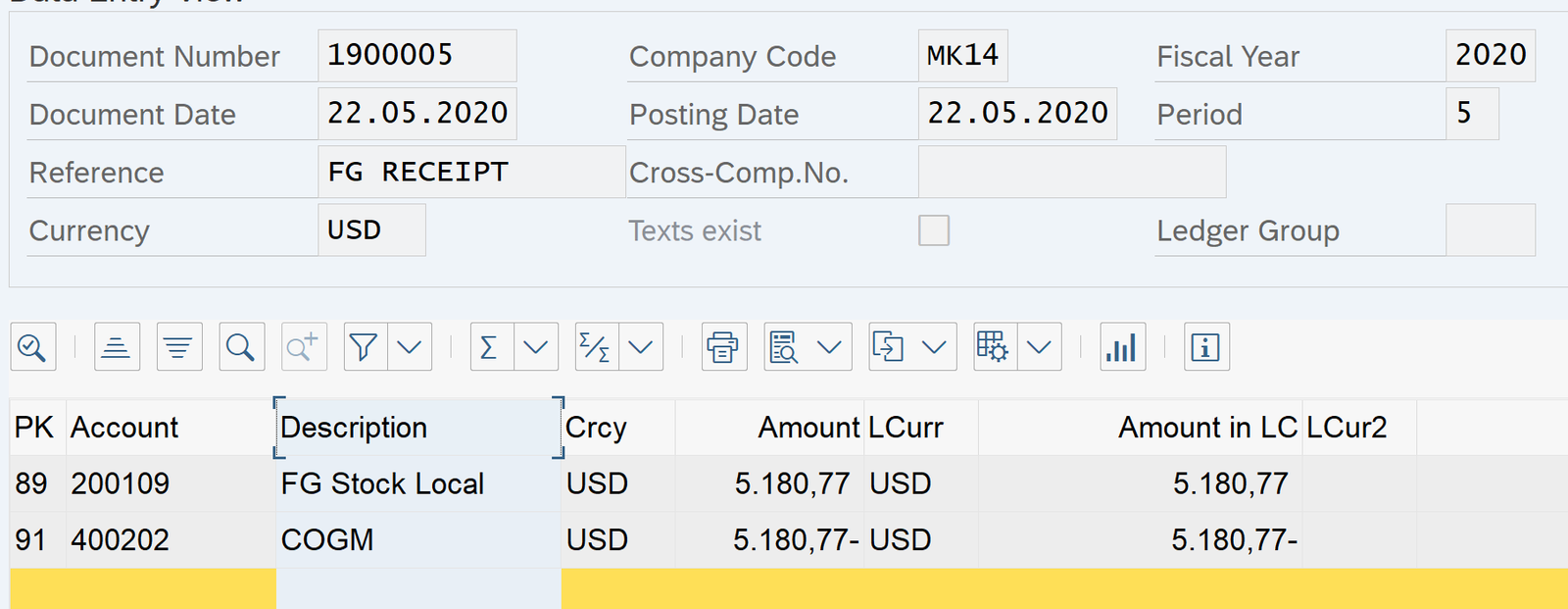

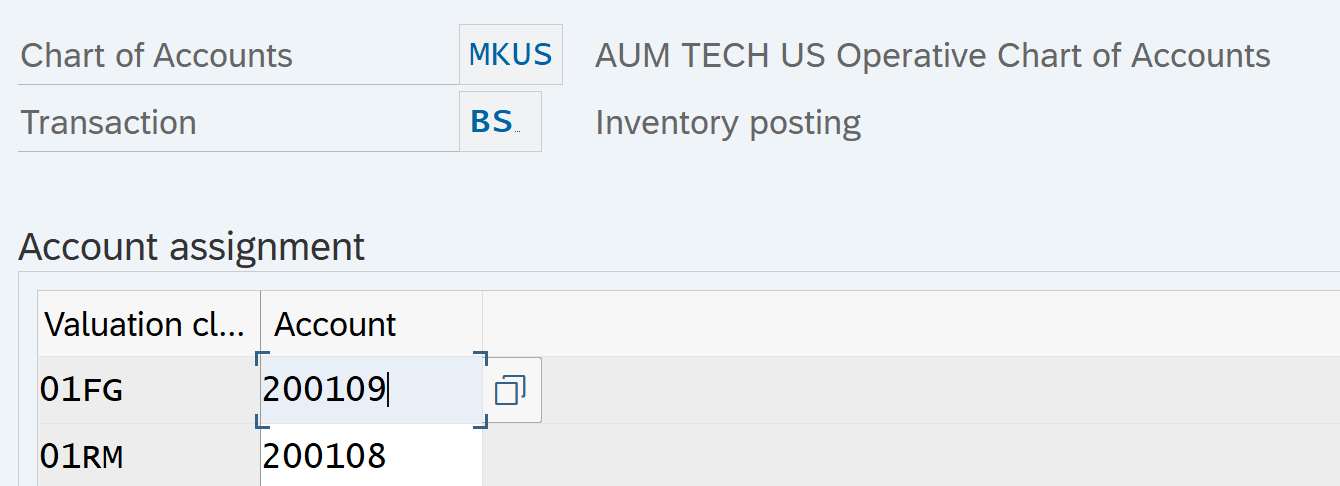

- OBYC- BSX: FG Stock (200109) DR
- OBYC – GBB- (Gen Modi: AUF, Valuation Class: 01FG) : 400202 CR

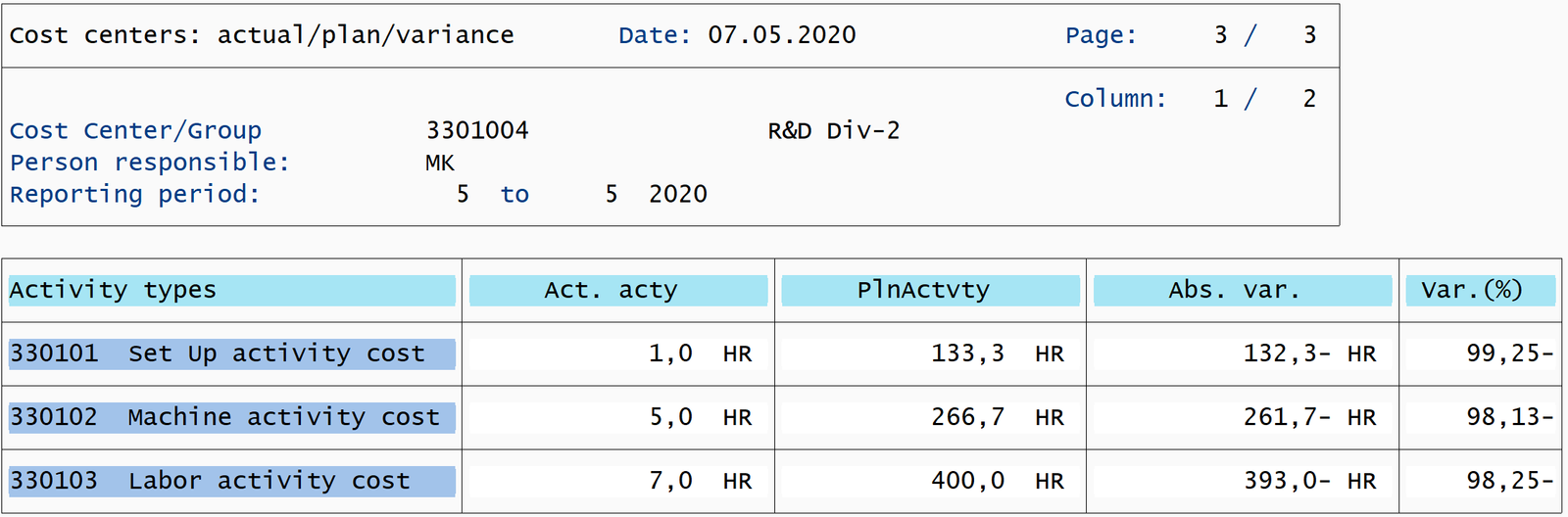

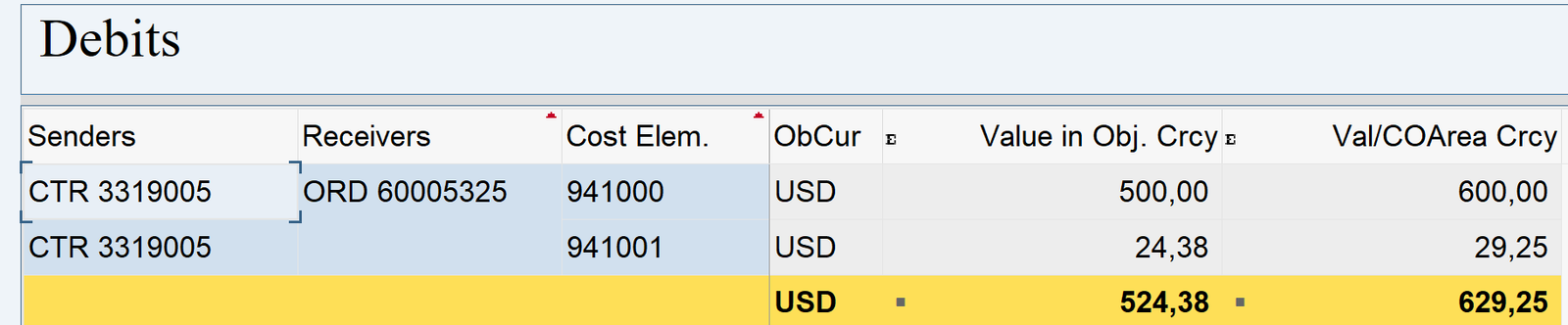

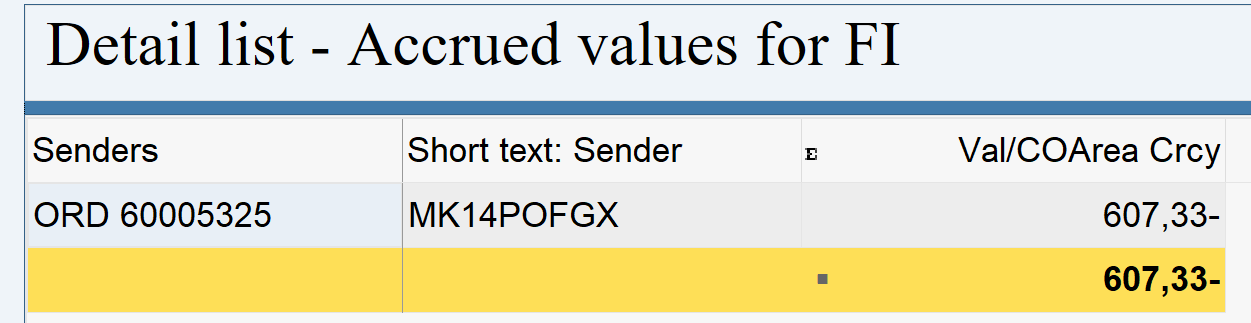

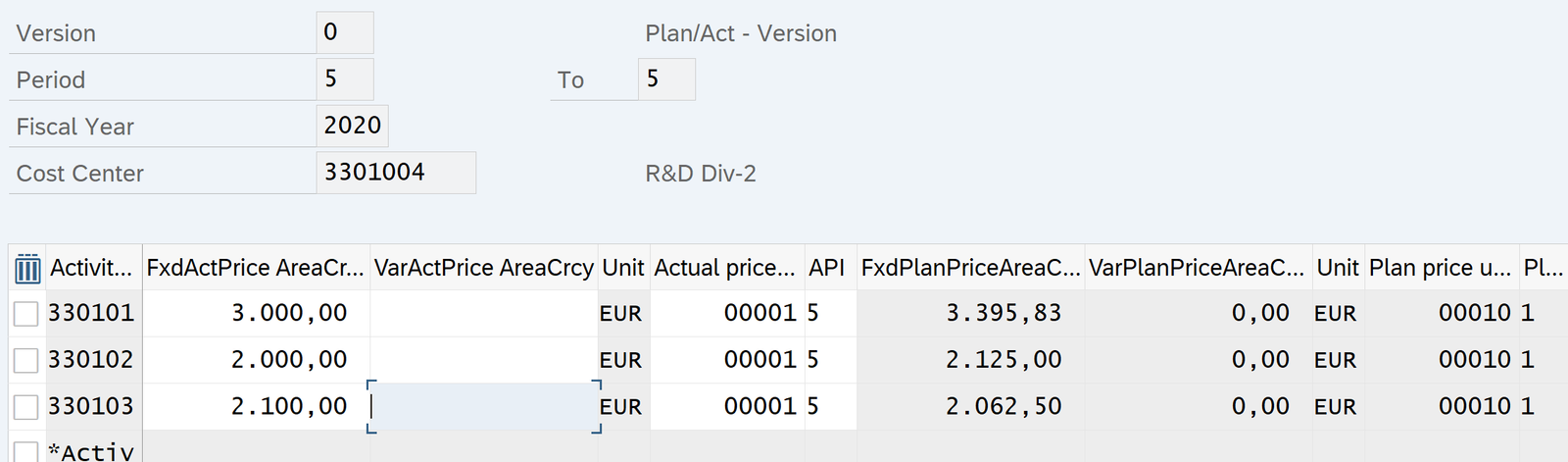

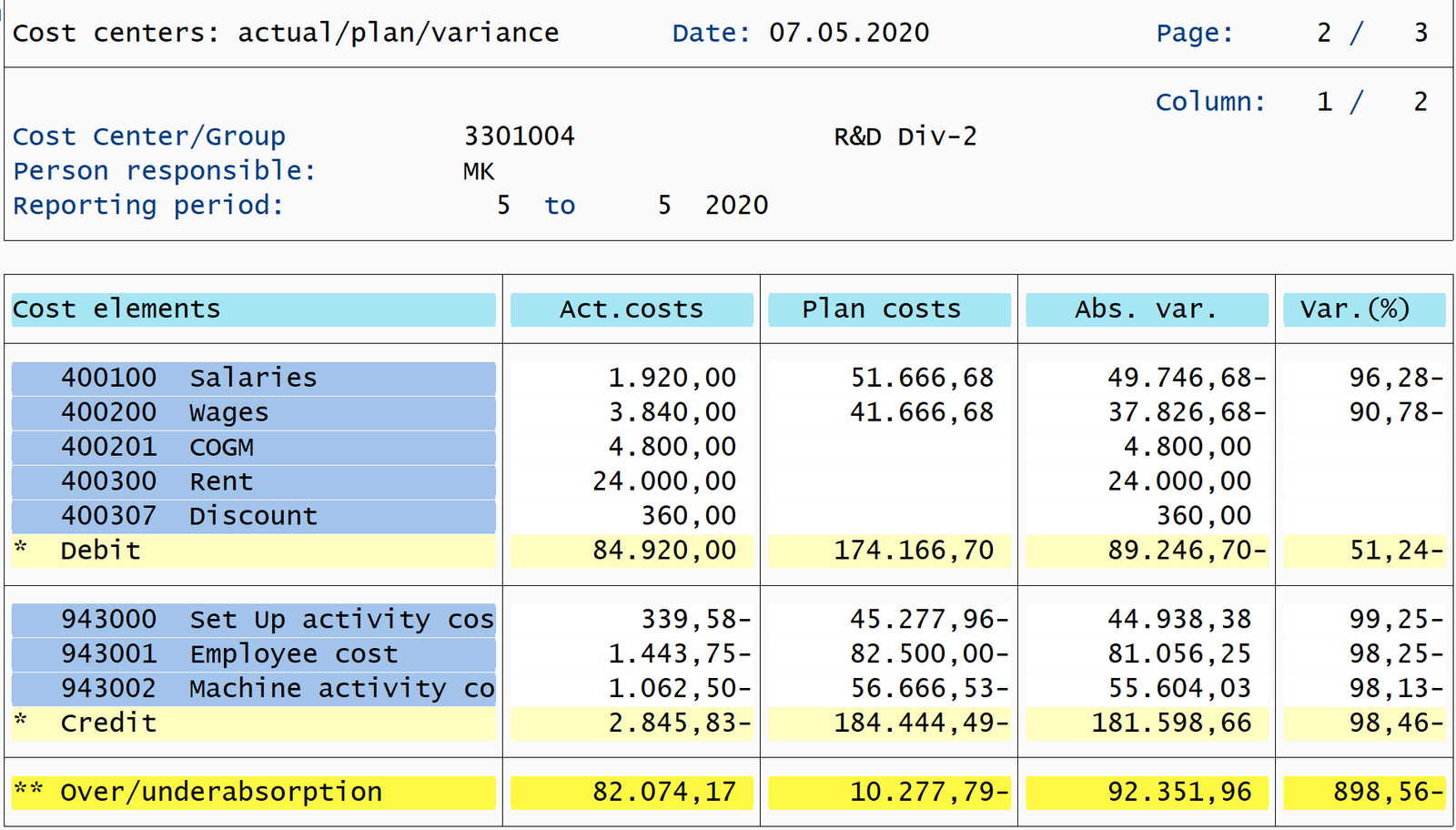

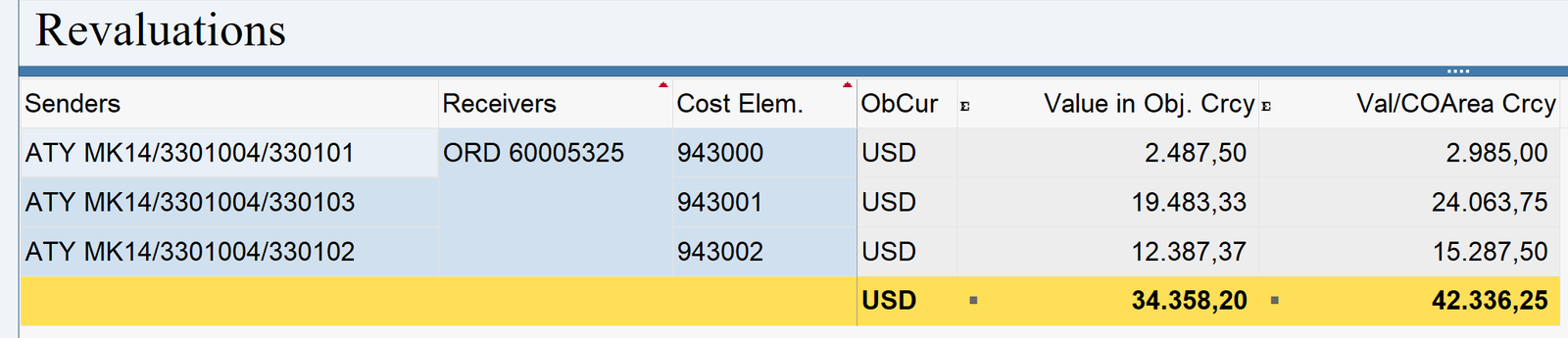

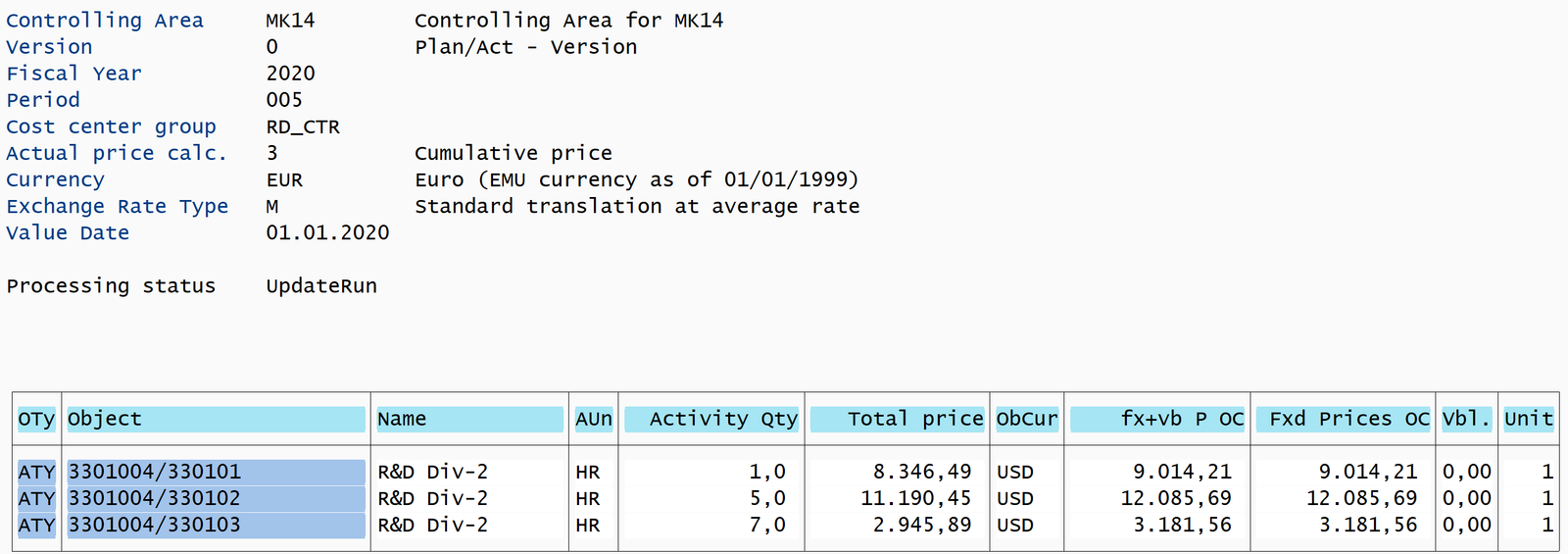

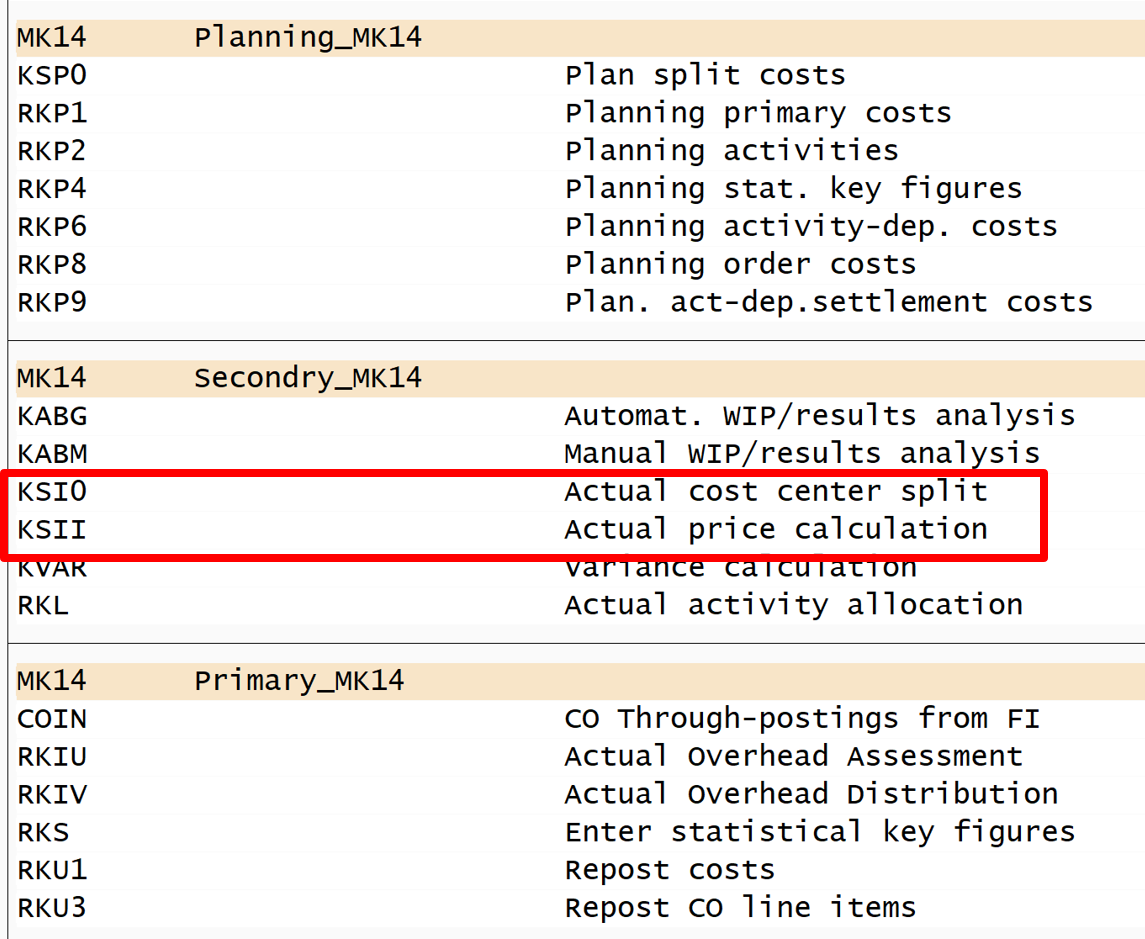

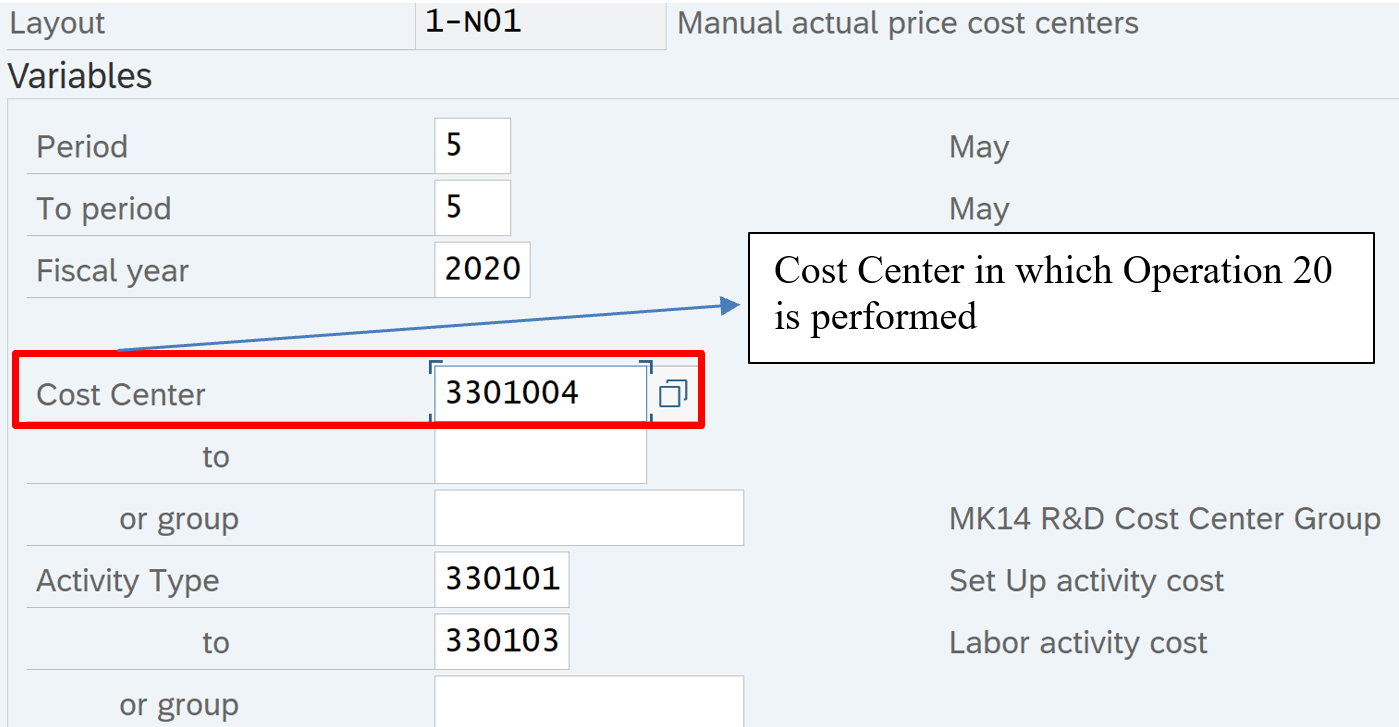

- Calculate Actual Activity Price:
- Manually: KBK6
- OKES, OKEW, KSS2, KSII

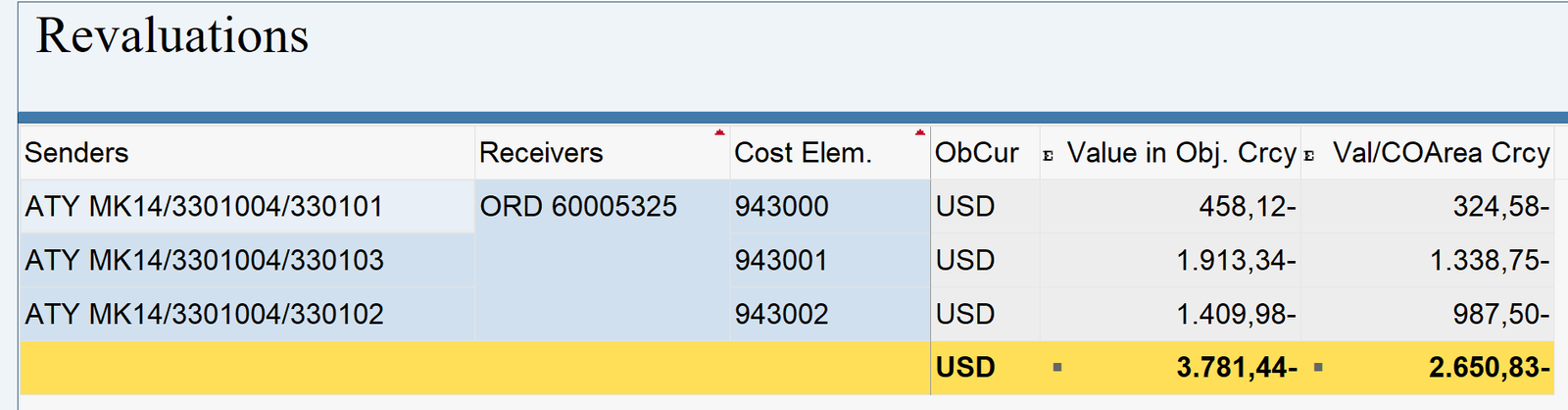

- Revaluate Operations activities at actual price: MFN1

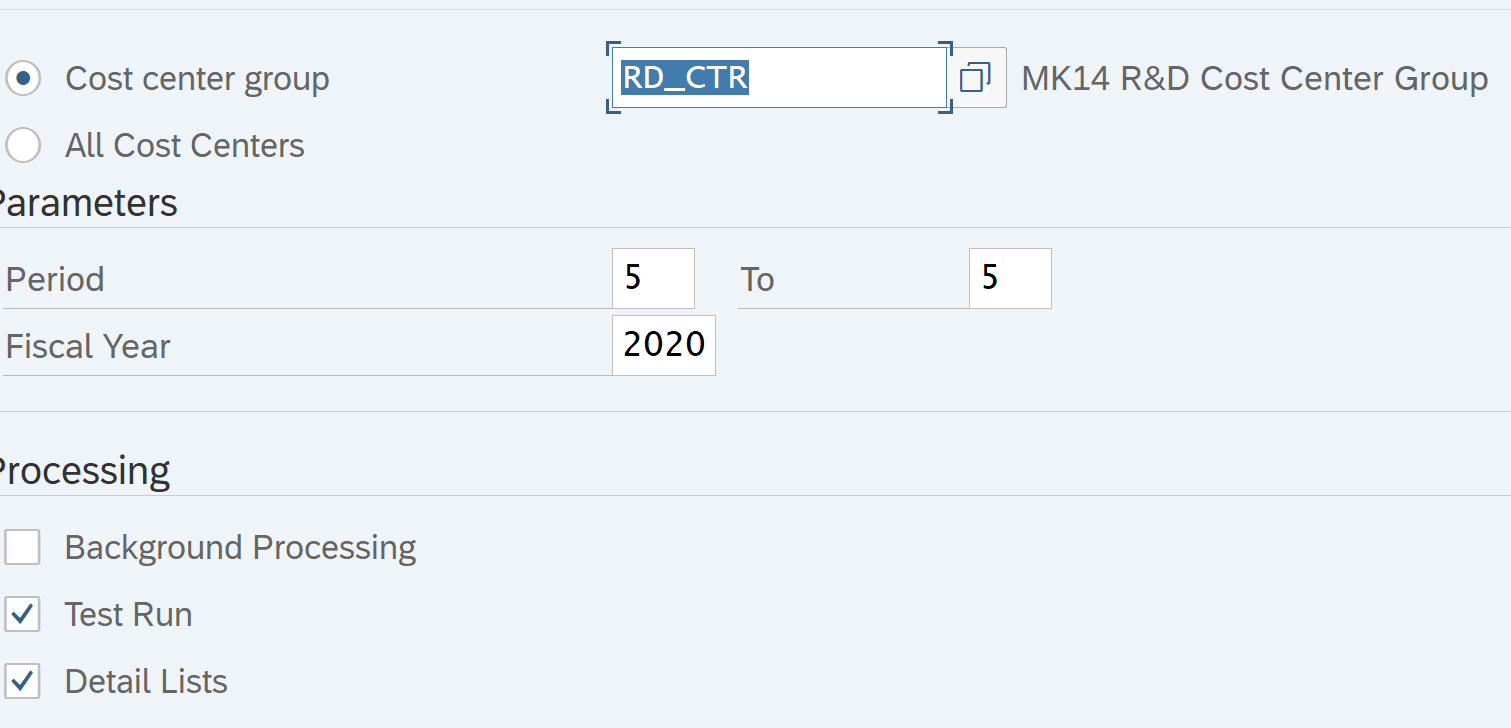

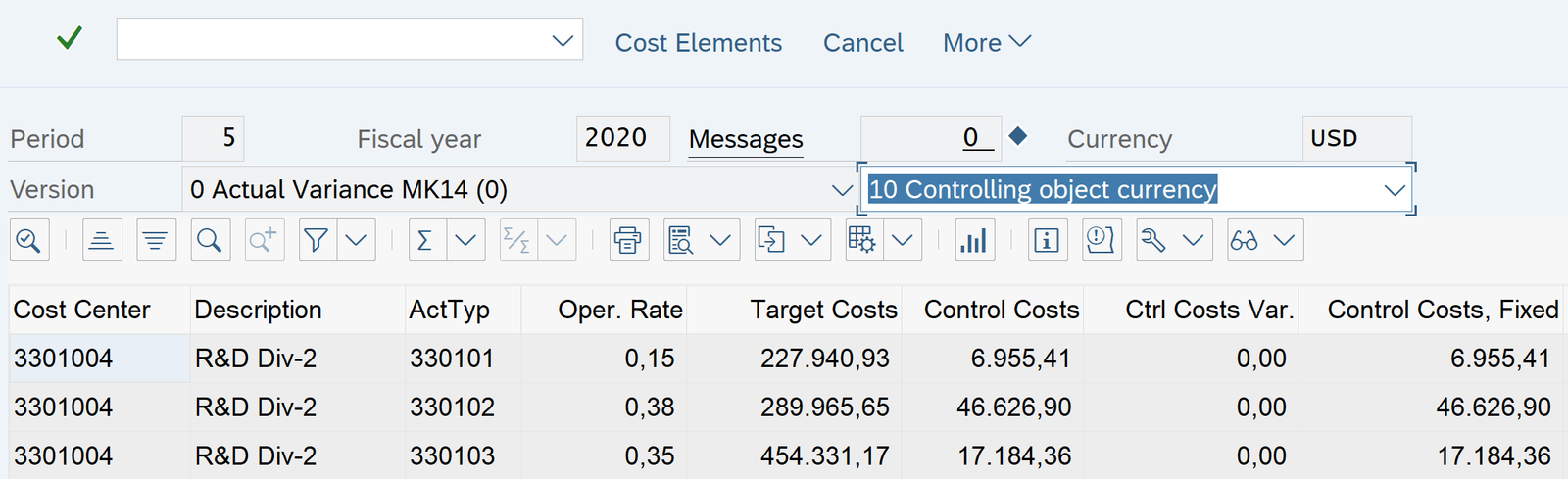

- Calculate actual OH: KGI2

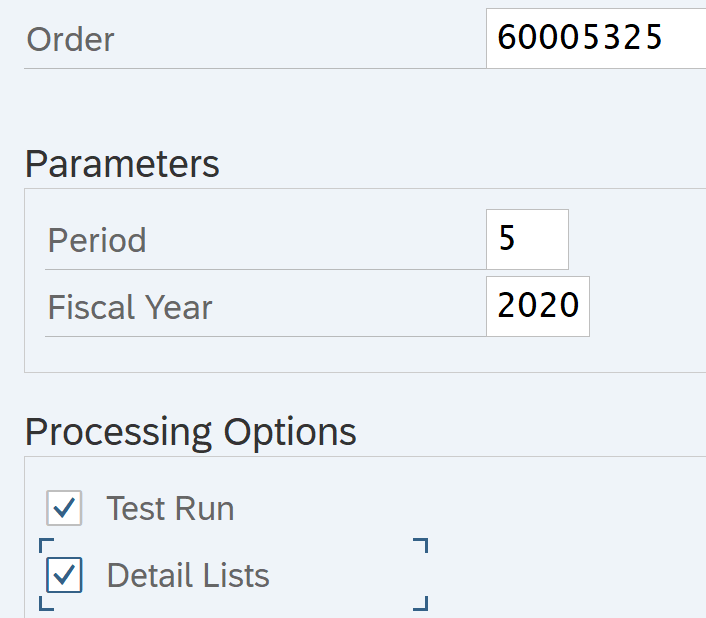

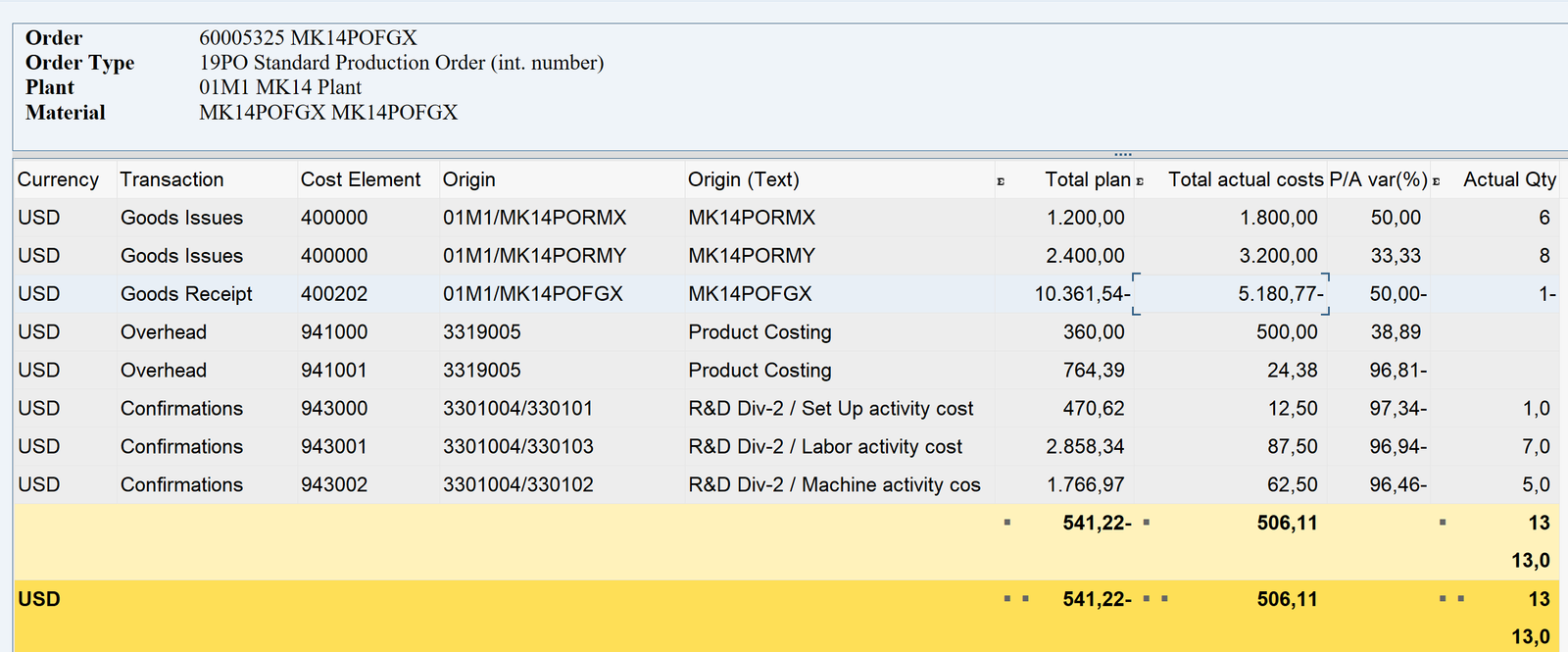

- Verify the actual OH cost in Production Order: CO03

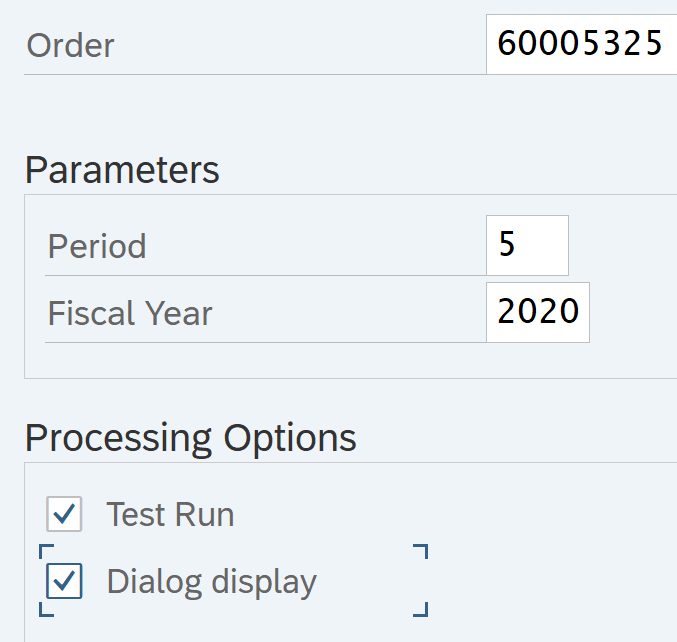

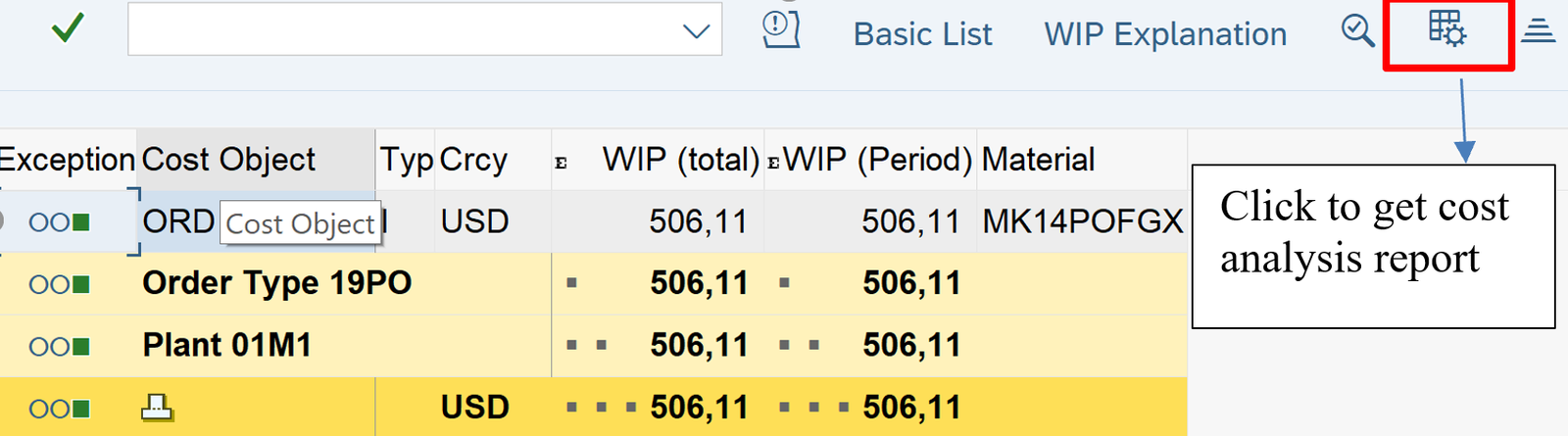

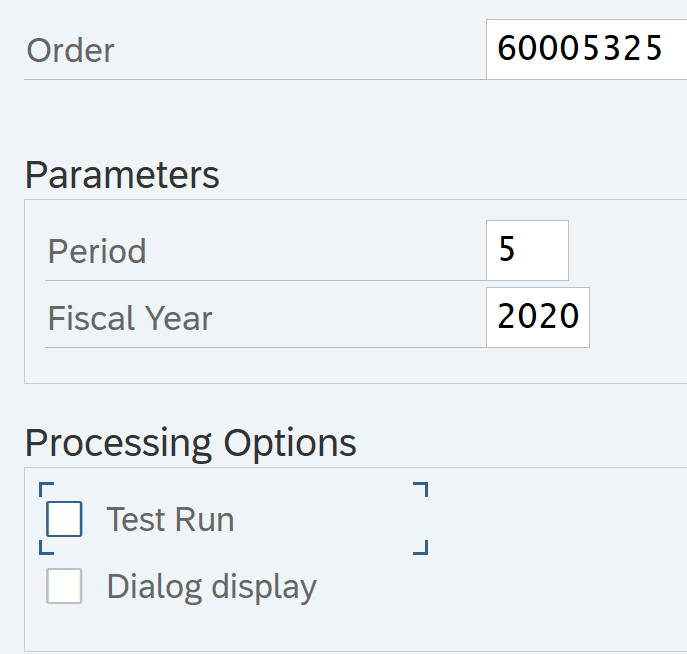

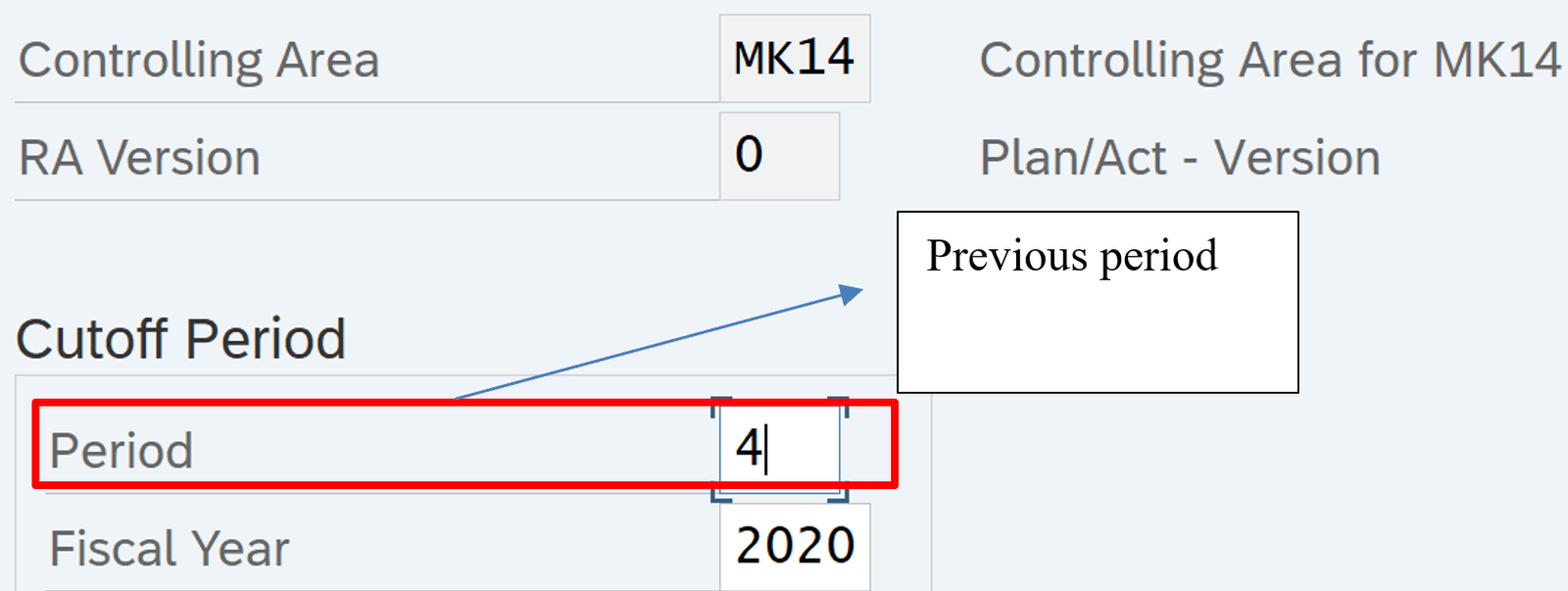

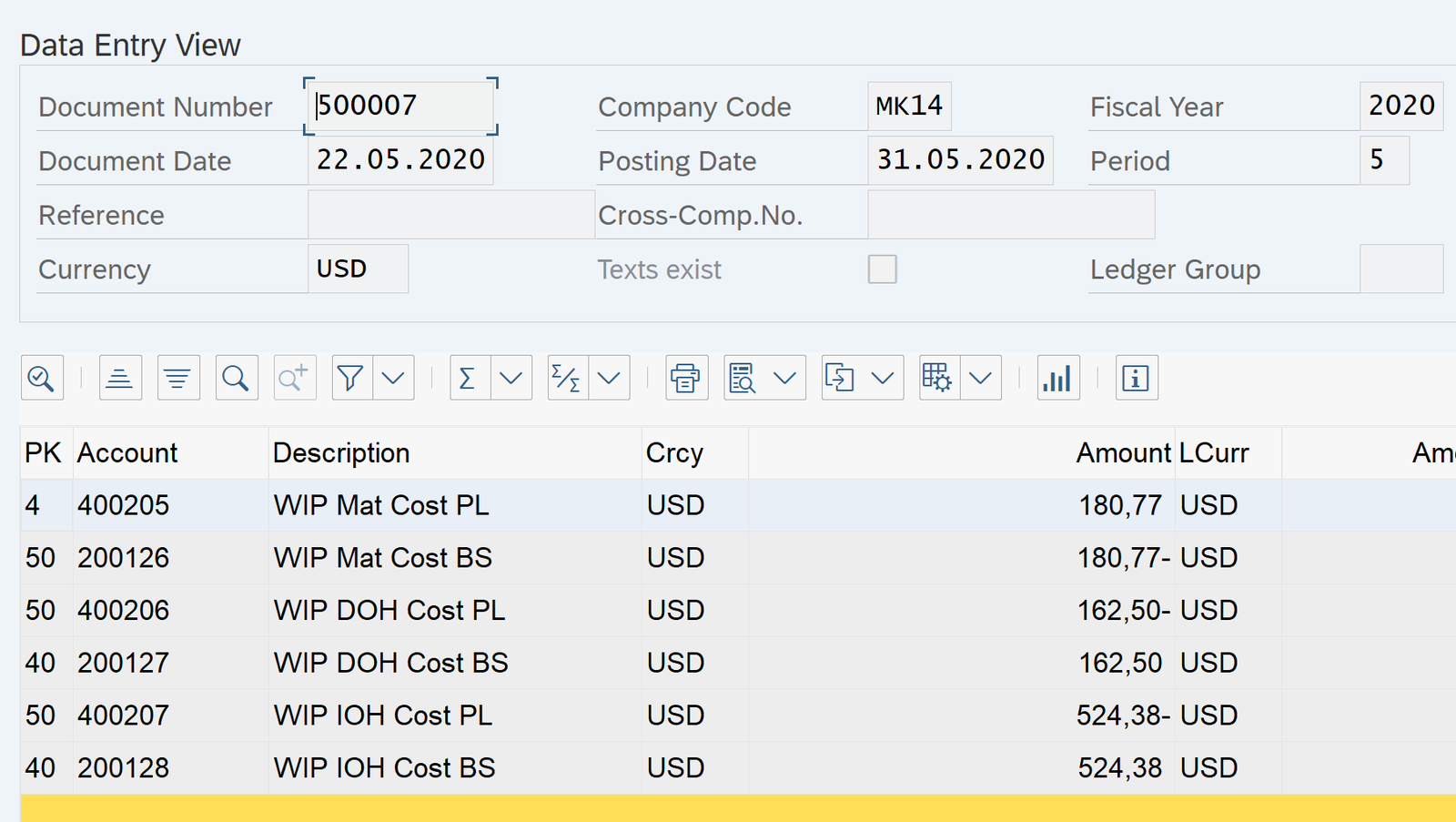

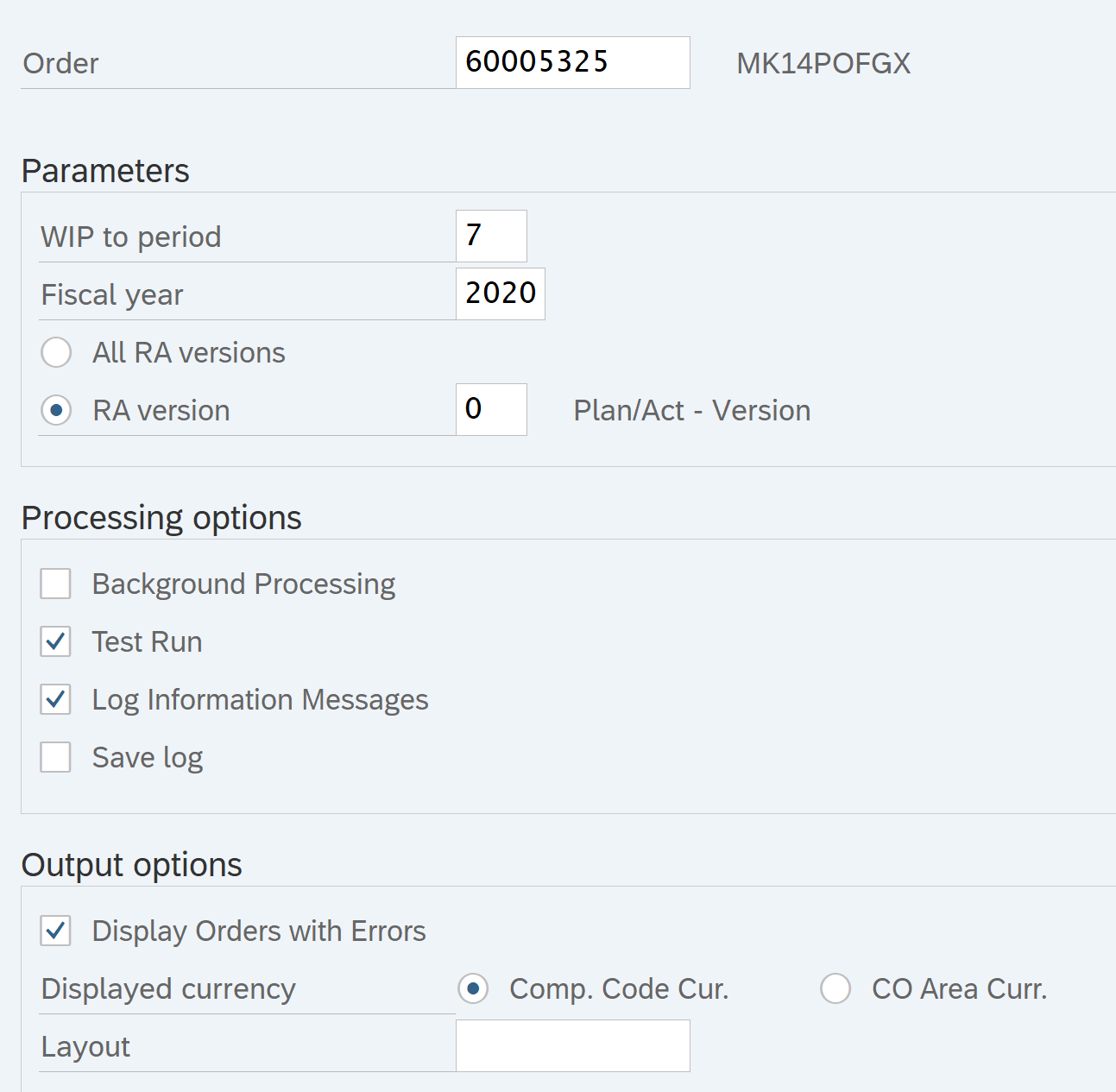

- Perform Month End cut off / period change for WIP: KKA0
- Perform WIP Calculation: KKAX

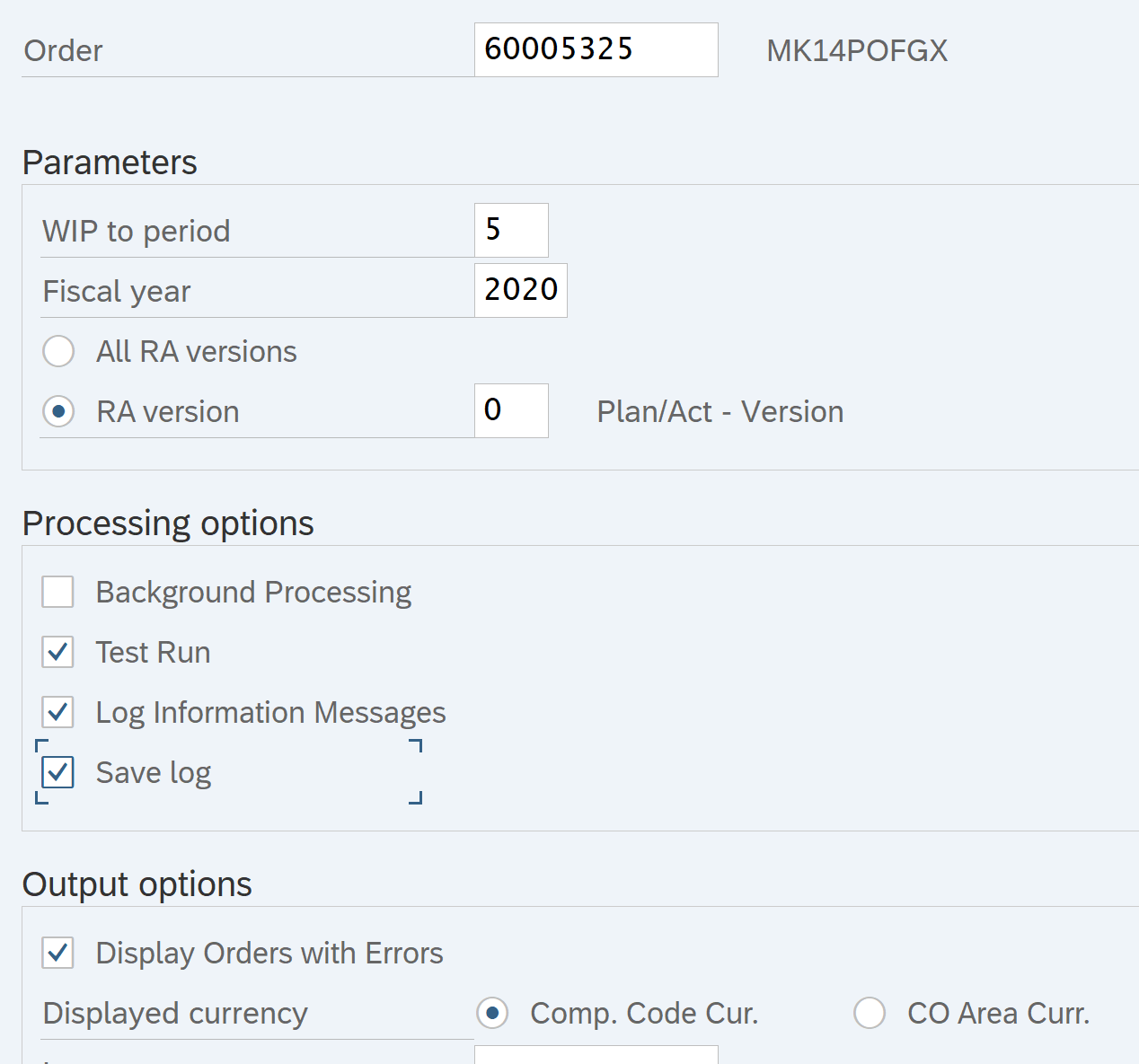

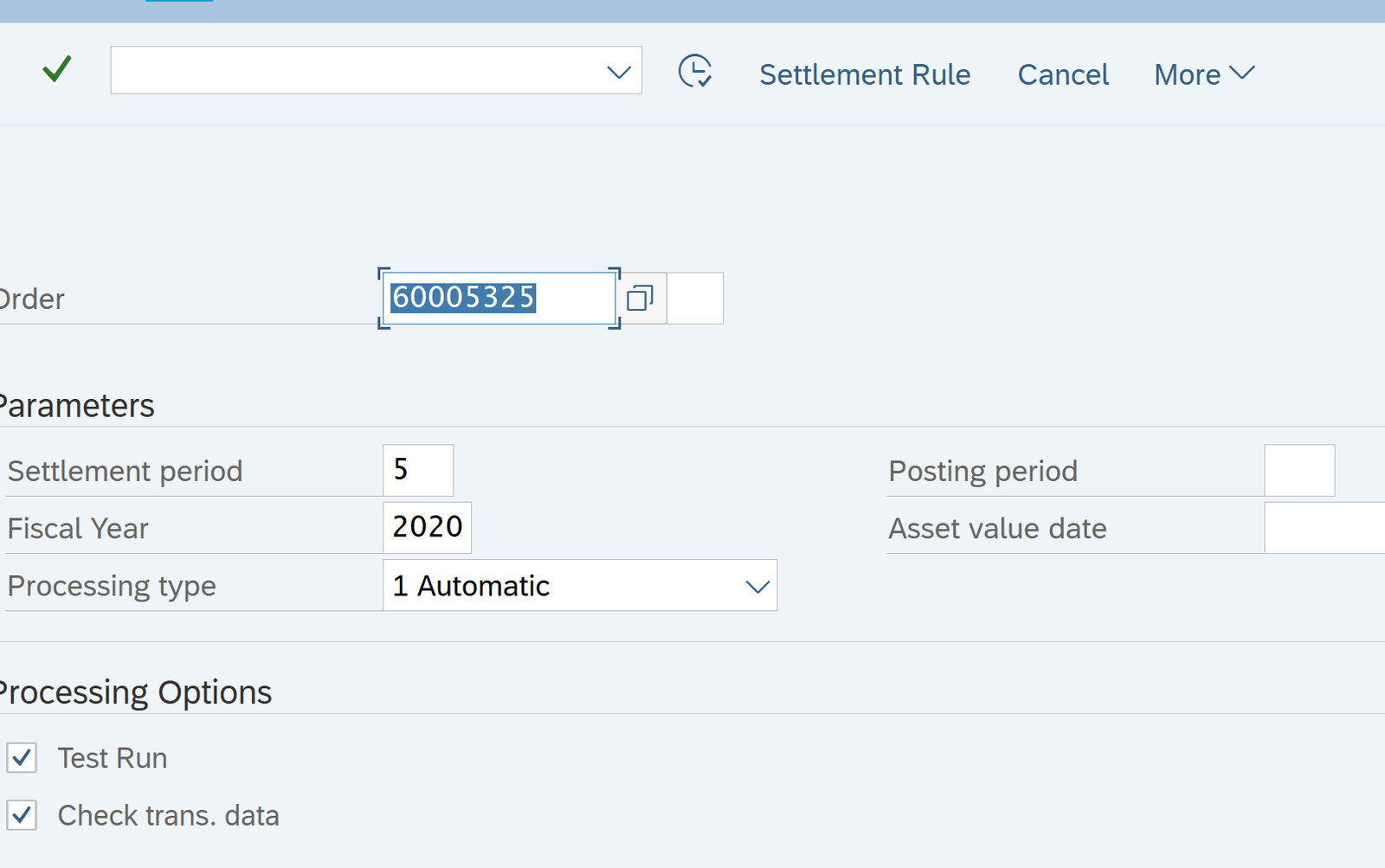

- Before Variance Calculation Production order should be settle. Settle Production Order: KO88

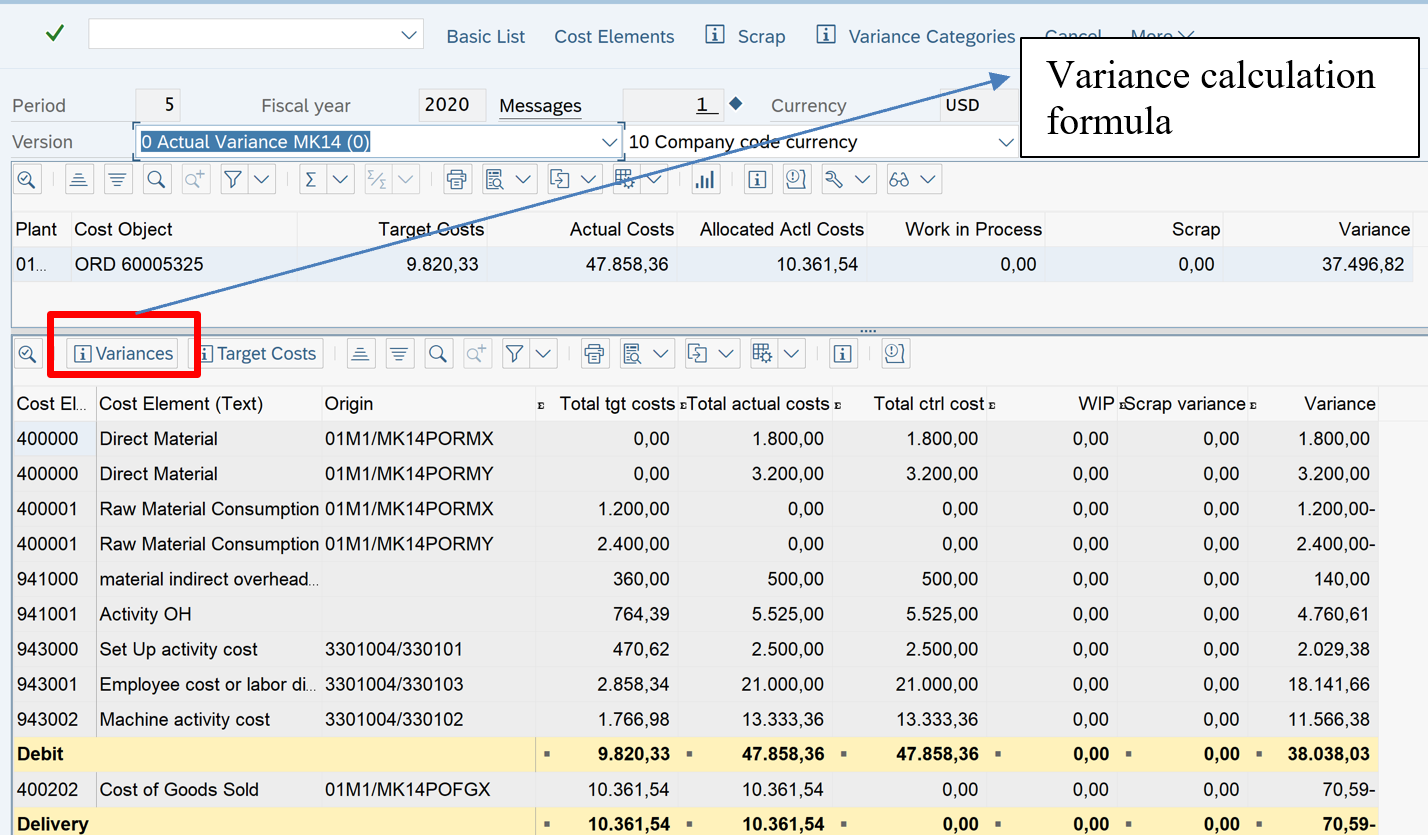

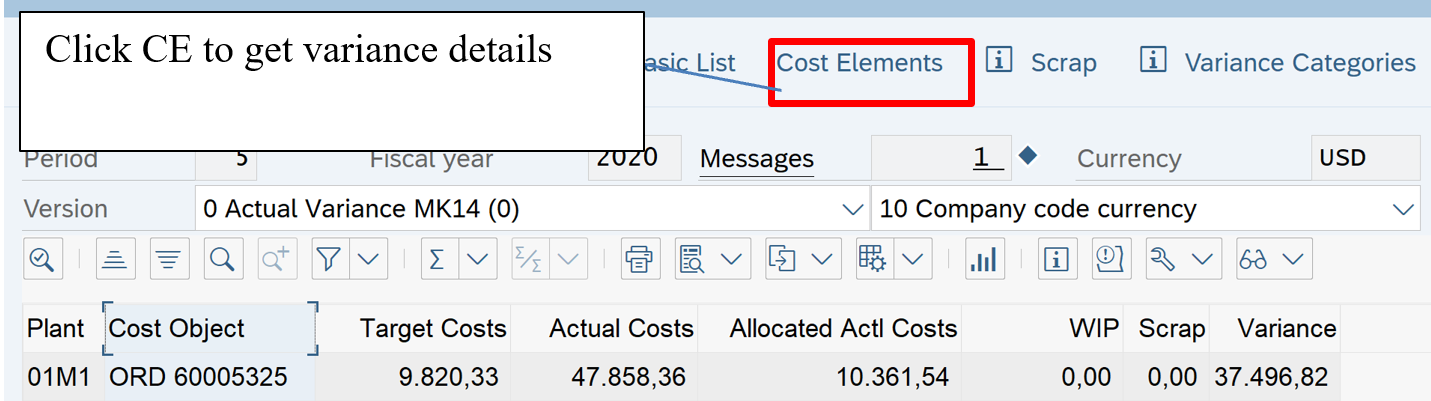

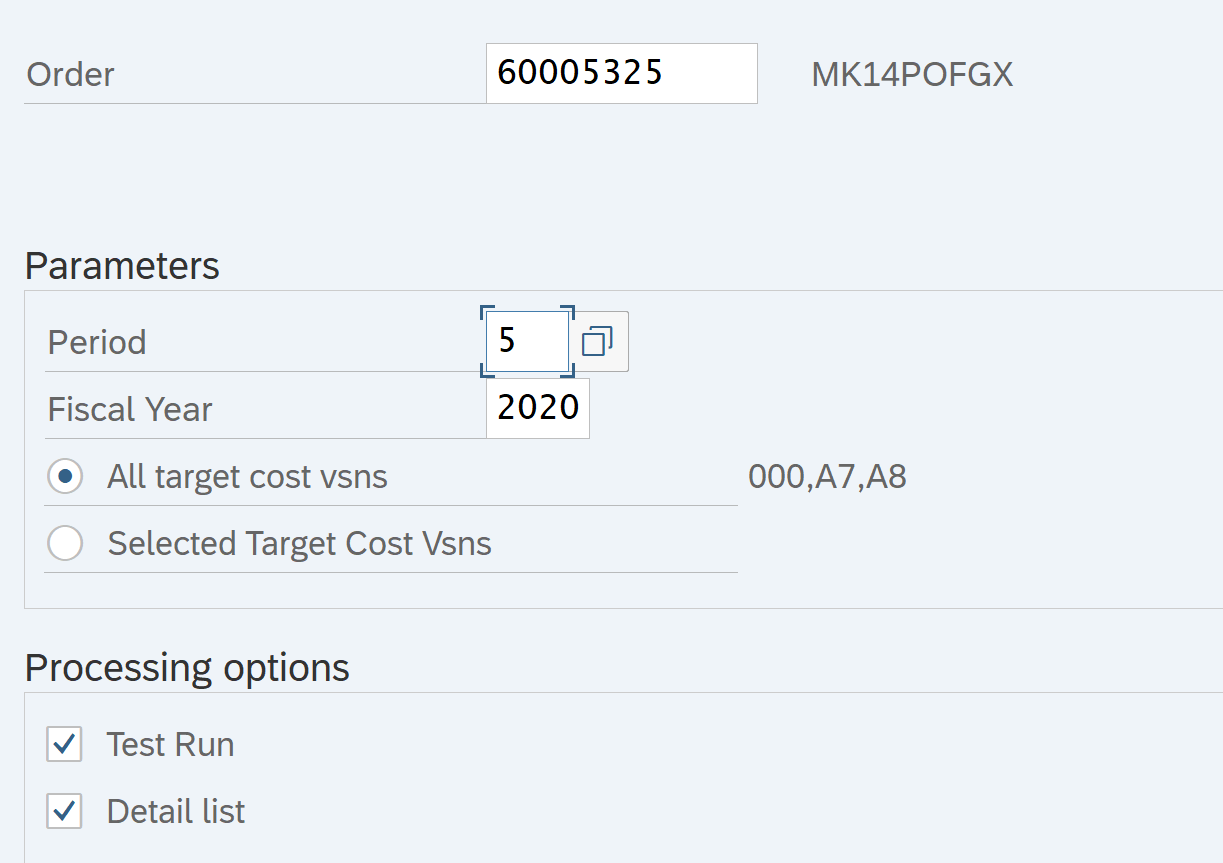

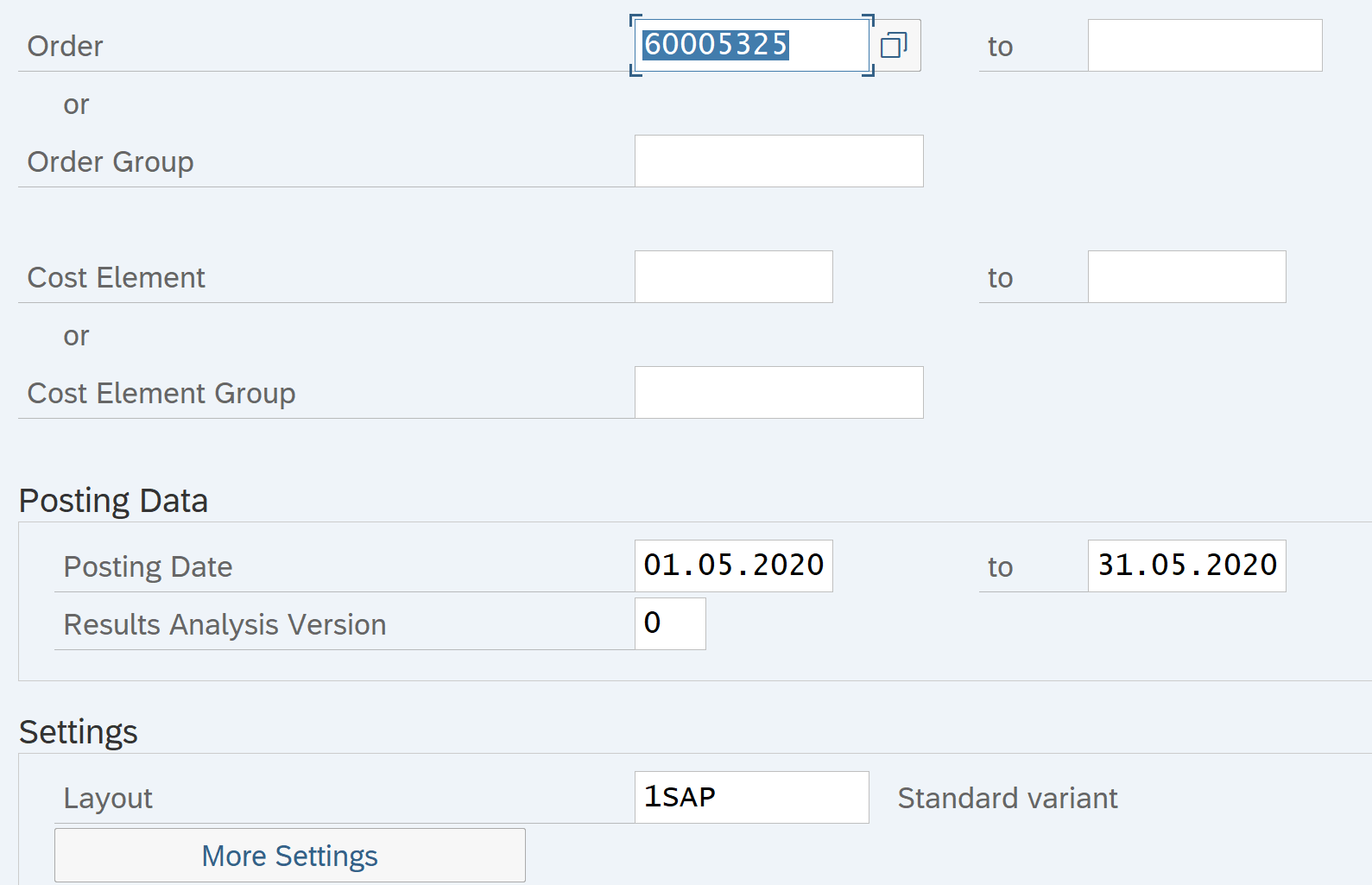

- Calculate Variance: KKS2

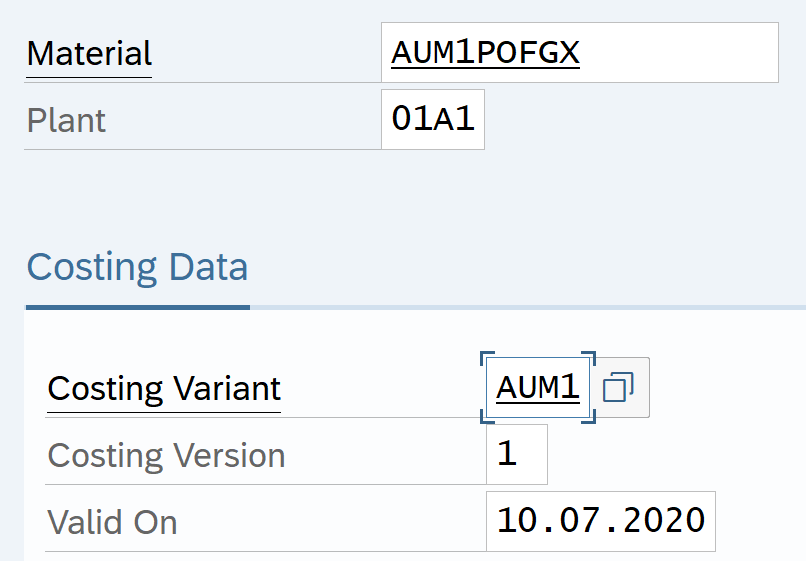

- Define Goods received valuation for order delivery
Path: SPRO – Controlling – Product Cost Controlling – Cost Object Controlling – Product Cost by Order – Define GR value for Order Delivery

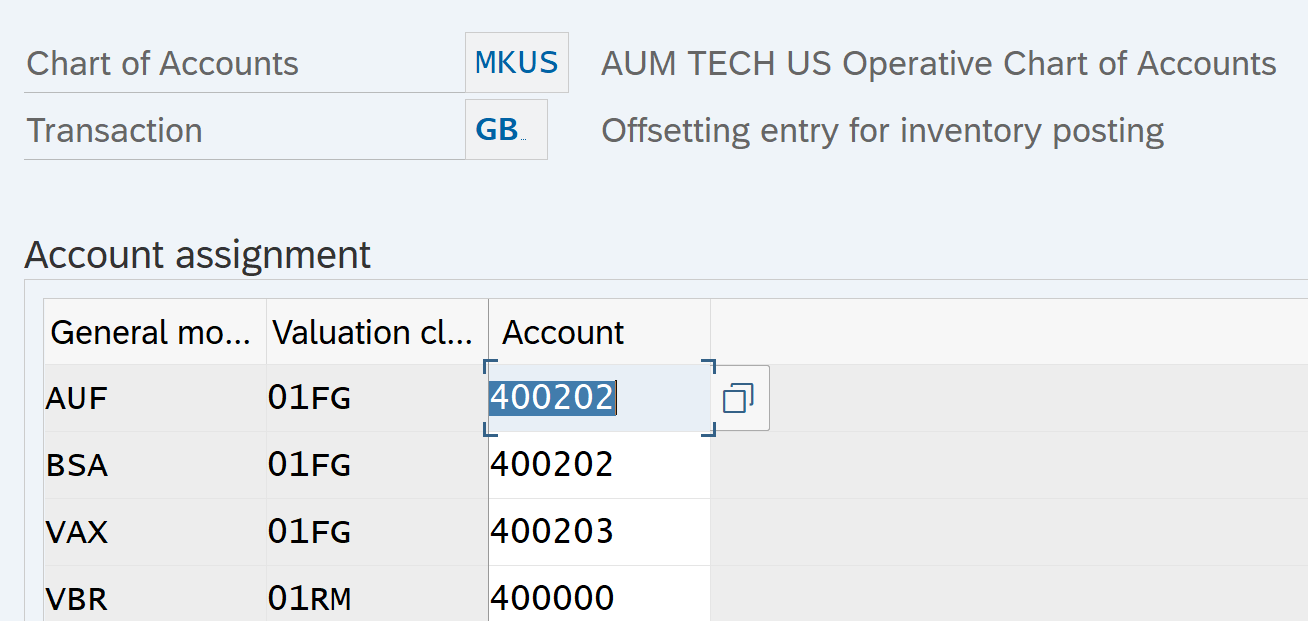

- Account Assignment in OBYC
Tcode: OBYC
GL Account
400202- COGM
400203- COGS
400000 – Raw Material
Accounting entry when goods received from production order
Stock Acct DR
To COGM Account

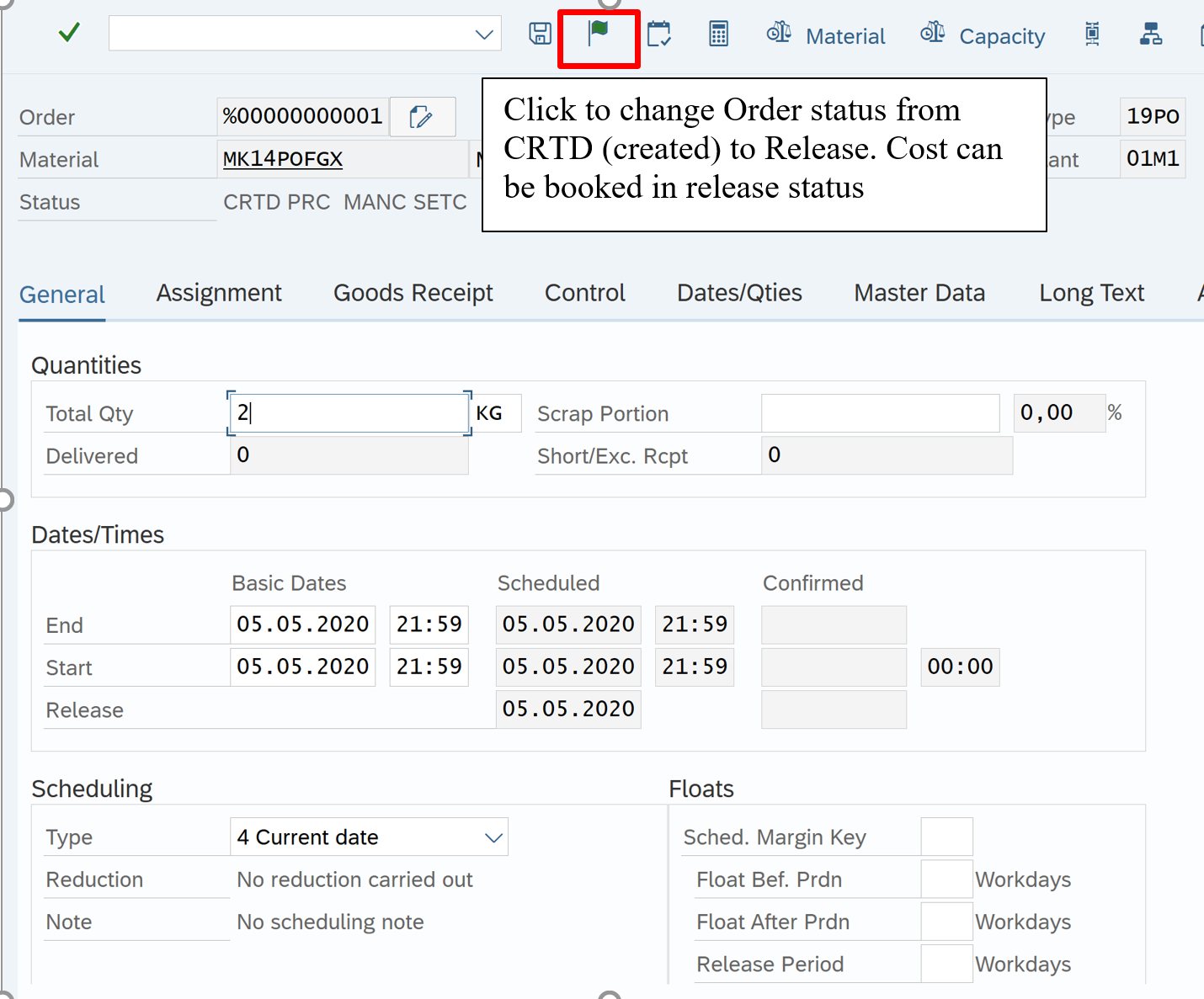

- Create Production Order

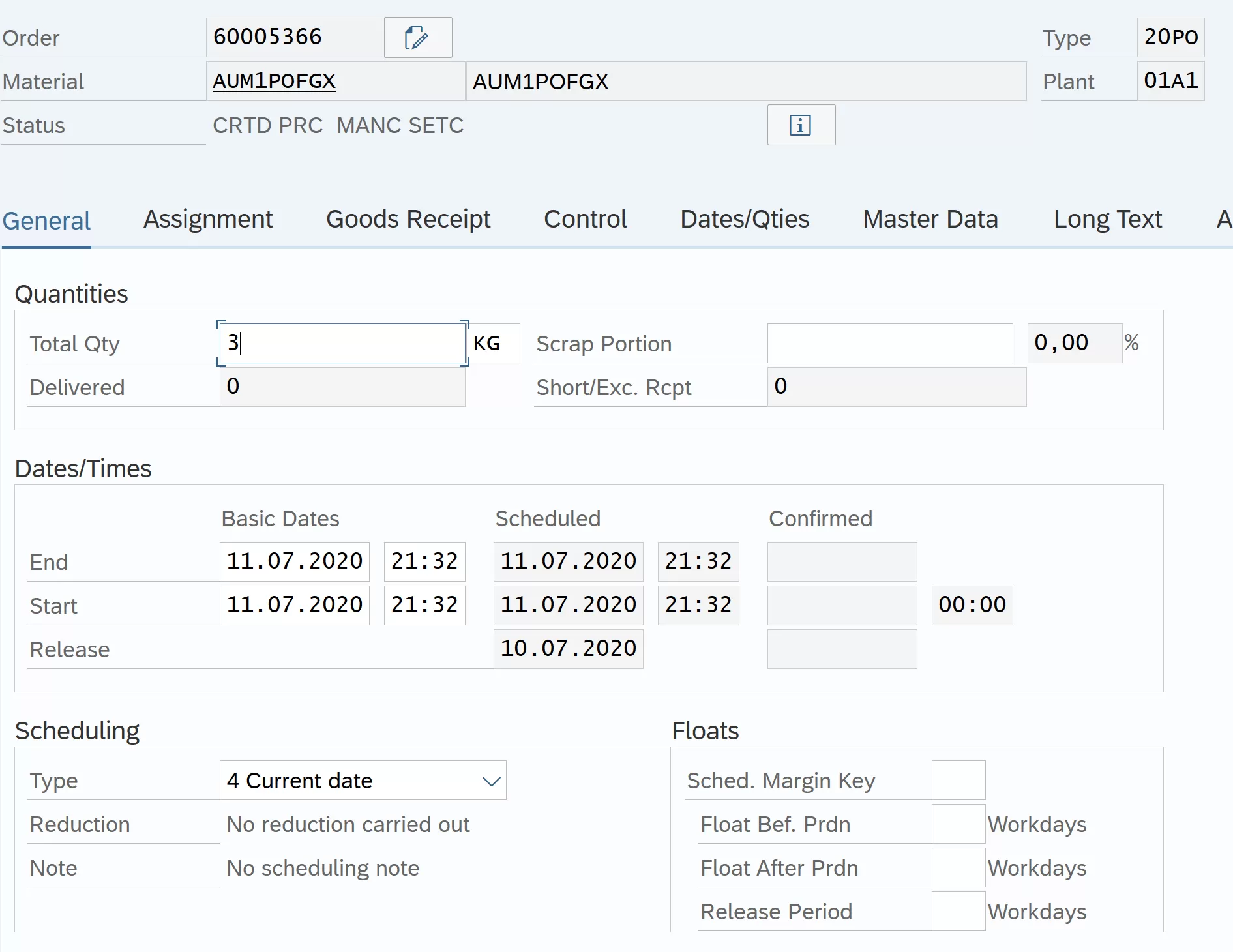

Transaction Code: CO01
Standard cost is always for 1 Kg
Planned cost is for production 0rder quantity. There is difference in these two cost due to fixed cost like setup cost which is same for 1 kg and 2 kg
Click on cost order to determine the Planned cost of production order
Click GOTO – Cost – Itemization to view planned cost
Click Save

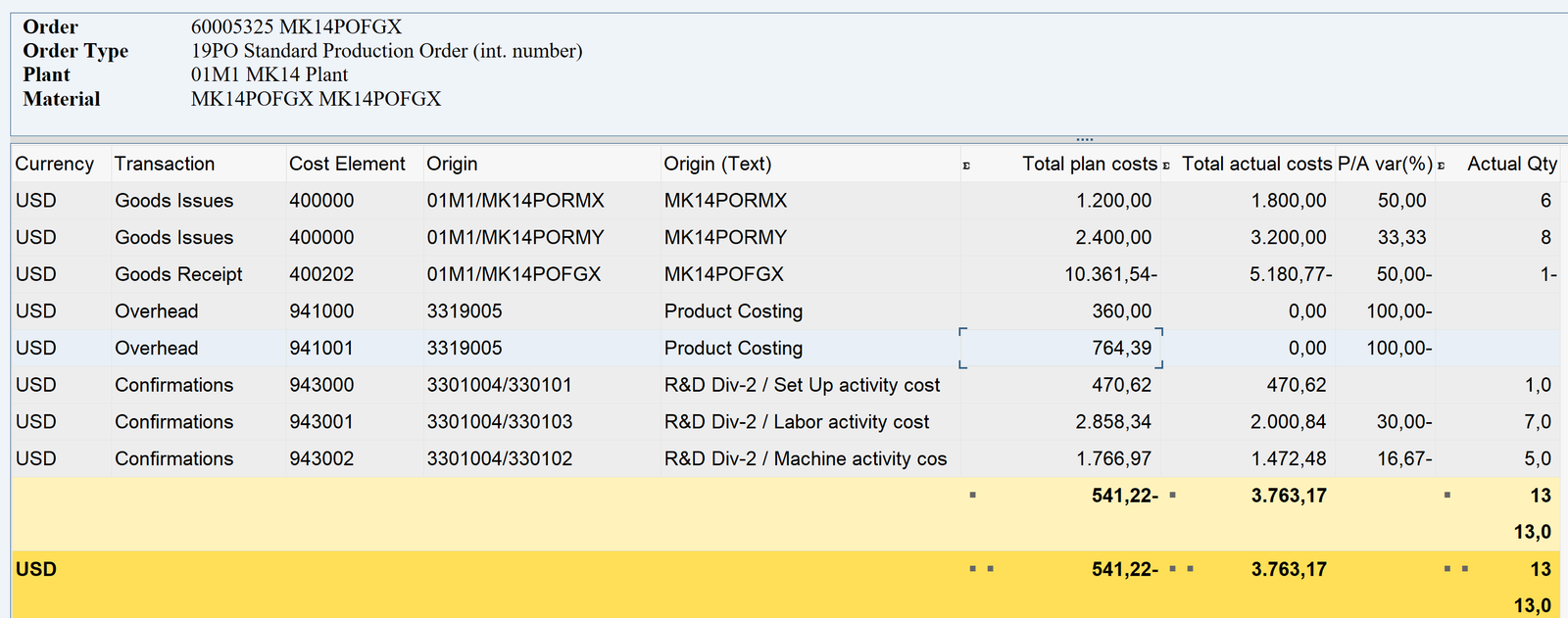

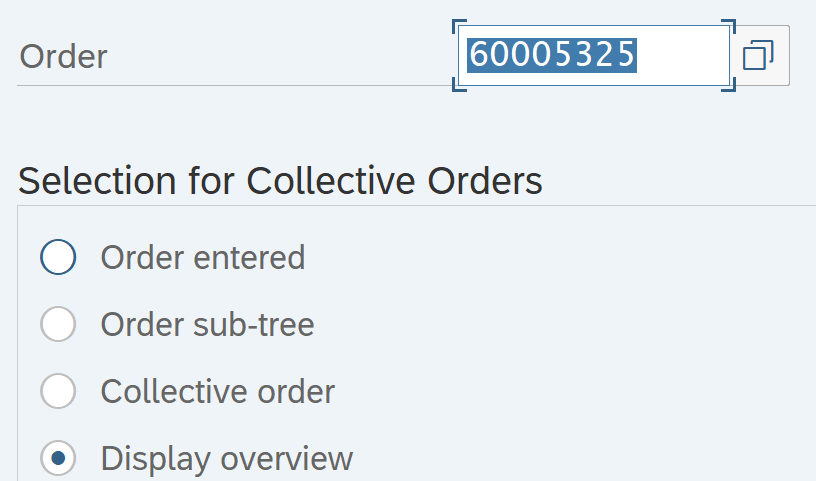

Production Order number 60005325 saved
Tcode: ME21N

Standard PO (SAP) created under the number 4500042902
Release Purchase Order: ME28

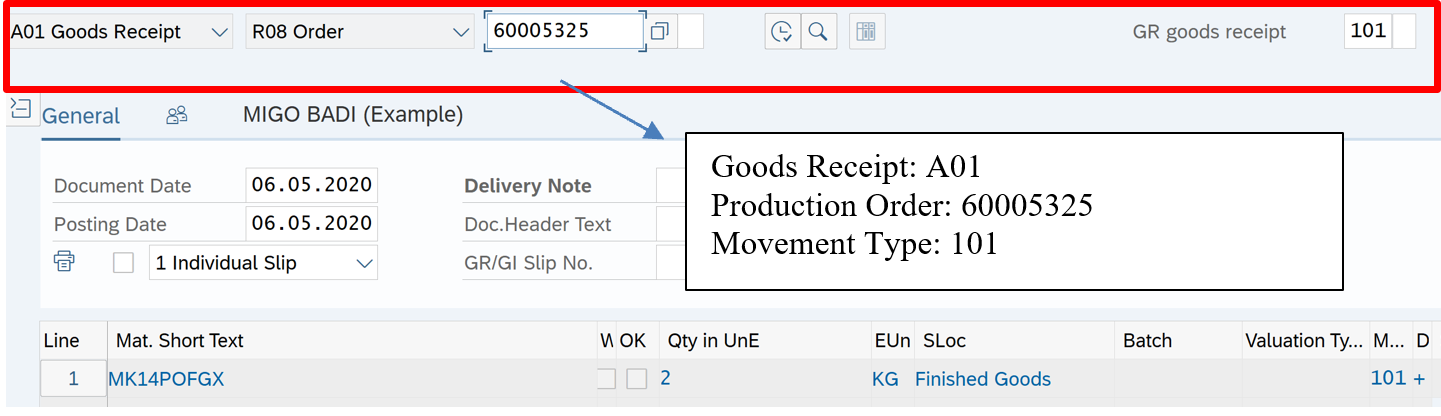

- Post Raw Material Goods Receipt

Tcode : MIGO

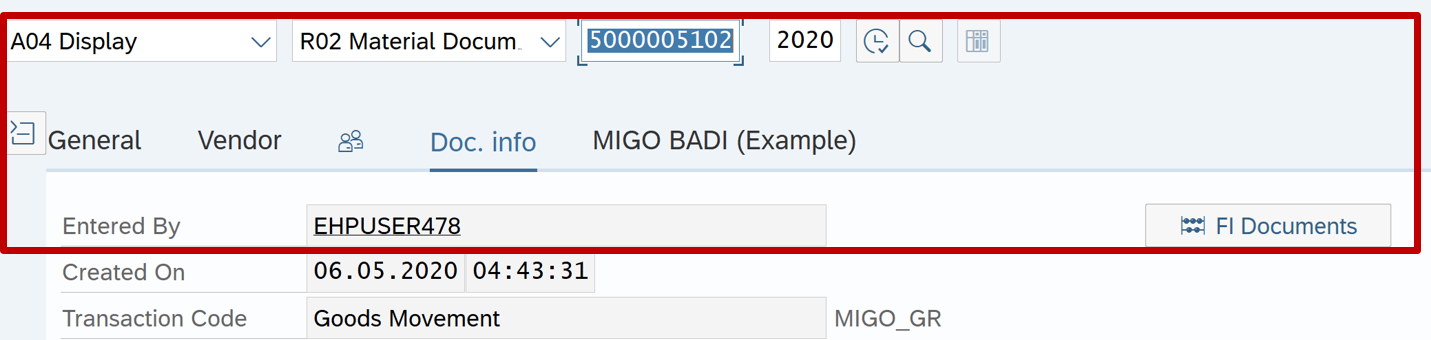

Material document 5000005102 posted

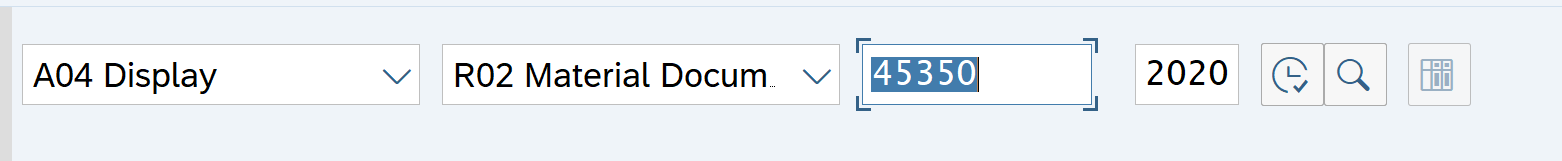

Display GRN material document: MIGO
Inventory / GRN posting Config : OBYC – BSX
Verify the Moving average price of Raw material MK14PORMX : MM02

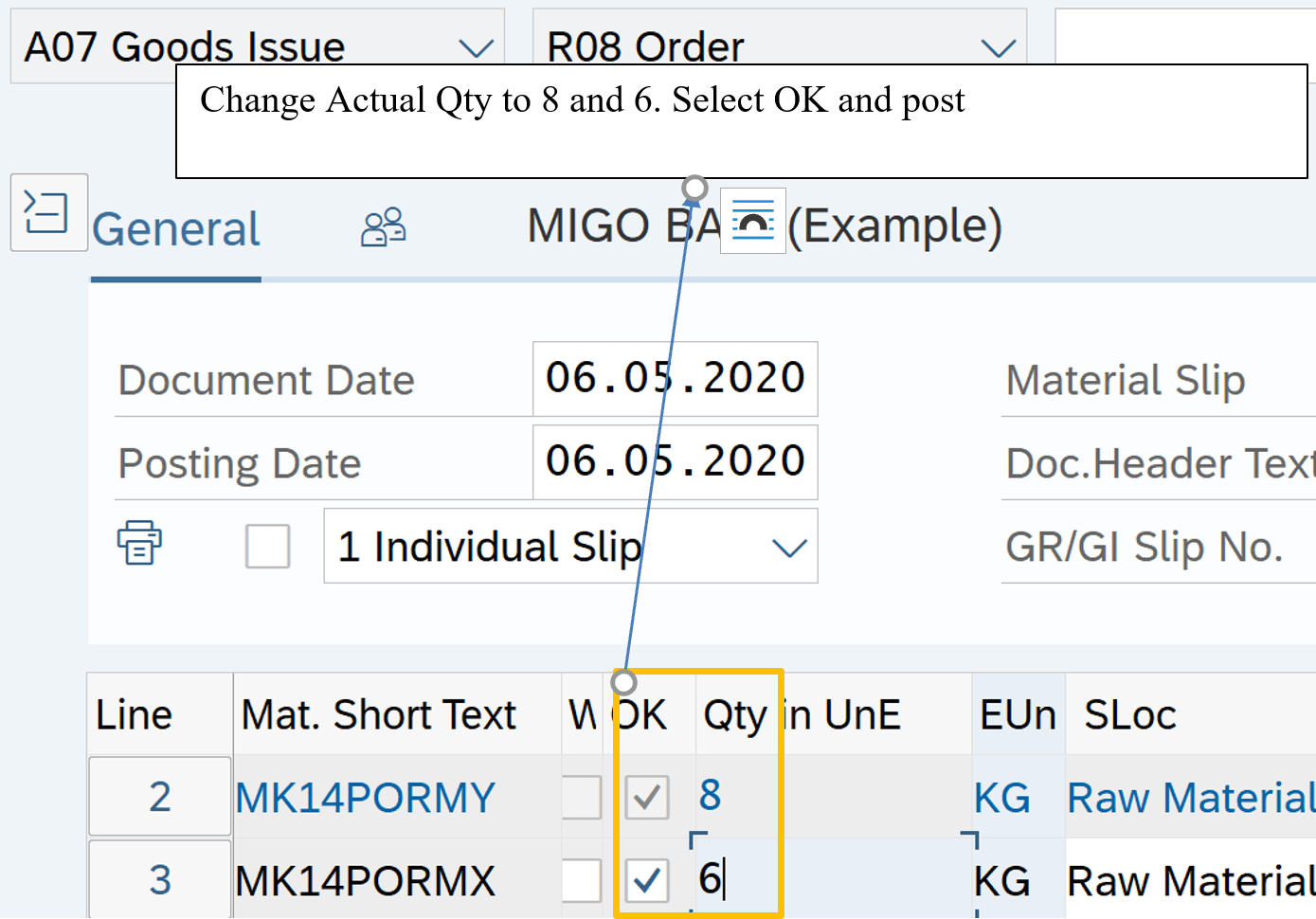

- Raw Material Issued to Production
Tcode: MIGO
Material document 4900008071 posted
Verify the actual raw material cost updated in production order 60005325: CO03
- Confirmation of Activities for Operation
- Assign CO Business Transaction RKL
- Confirmation of Activities for Operation

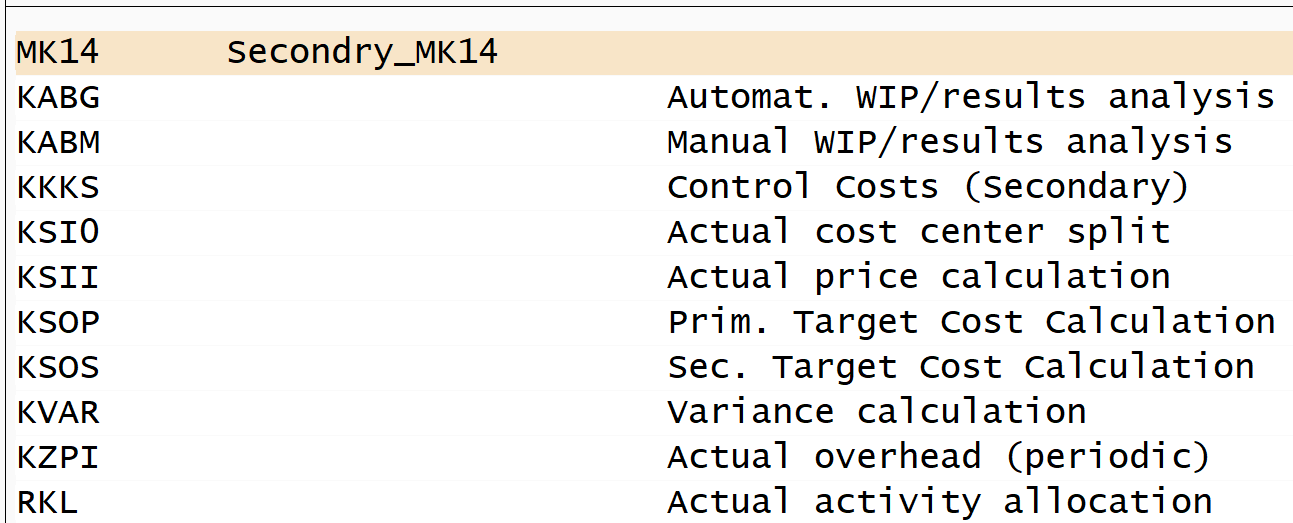

Tcode: KANK
Assign to secondary postings number range group
- Confirmation of activities for Operation 10

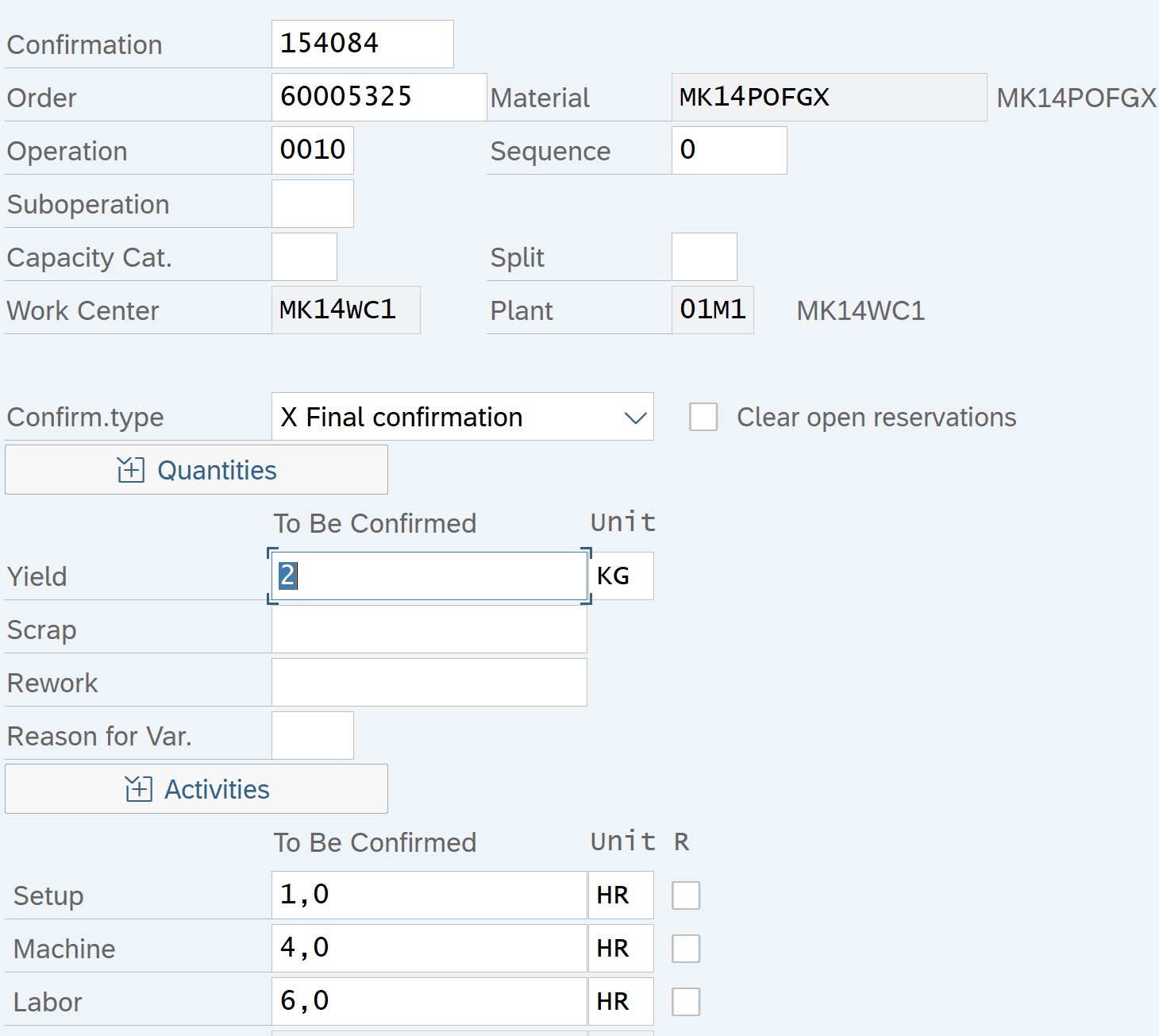

Tcode: CO11N

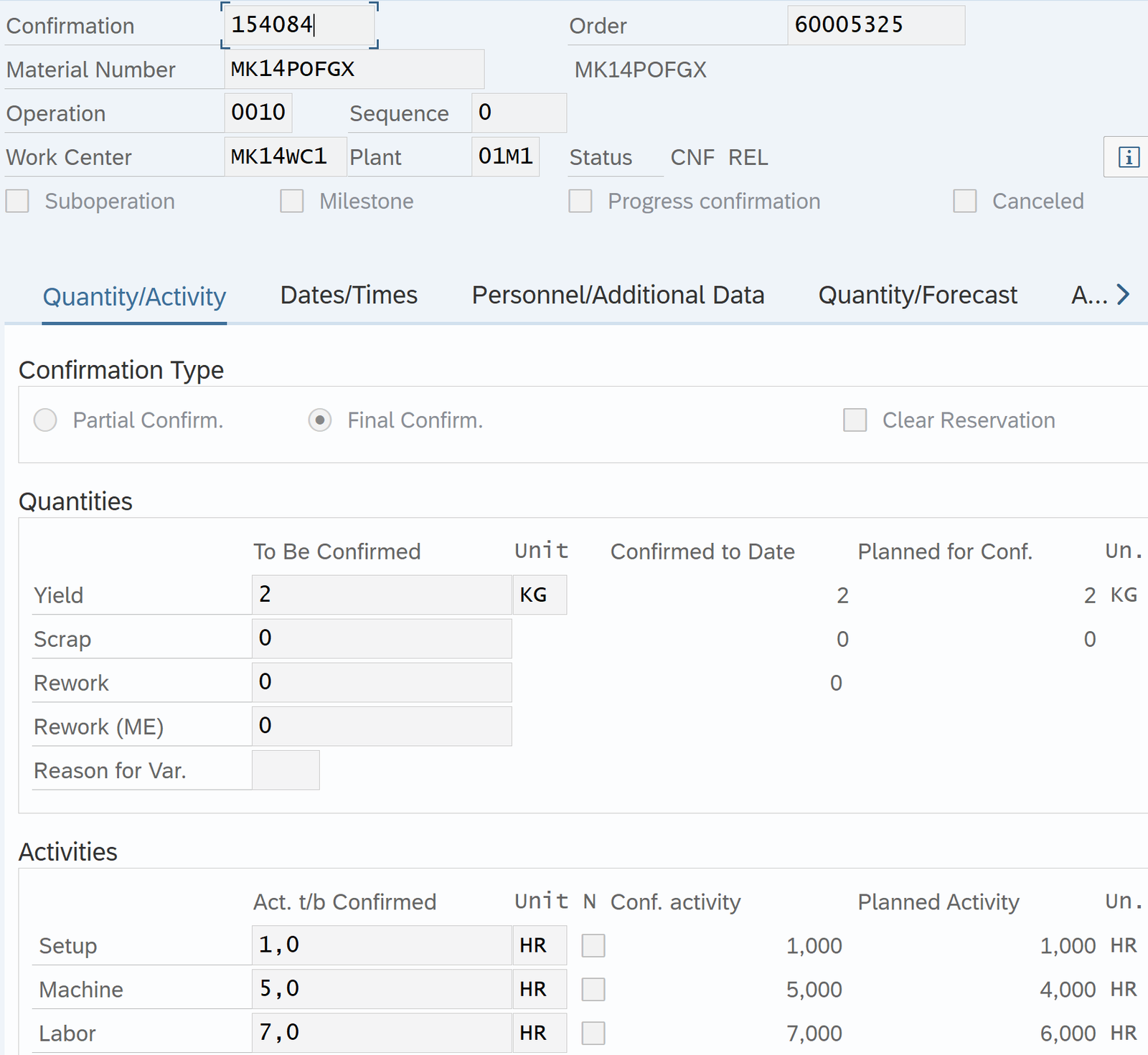

Enter Production Order and Operation 10 for actual activity hours hrs. updated

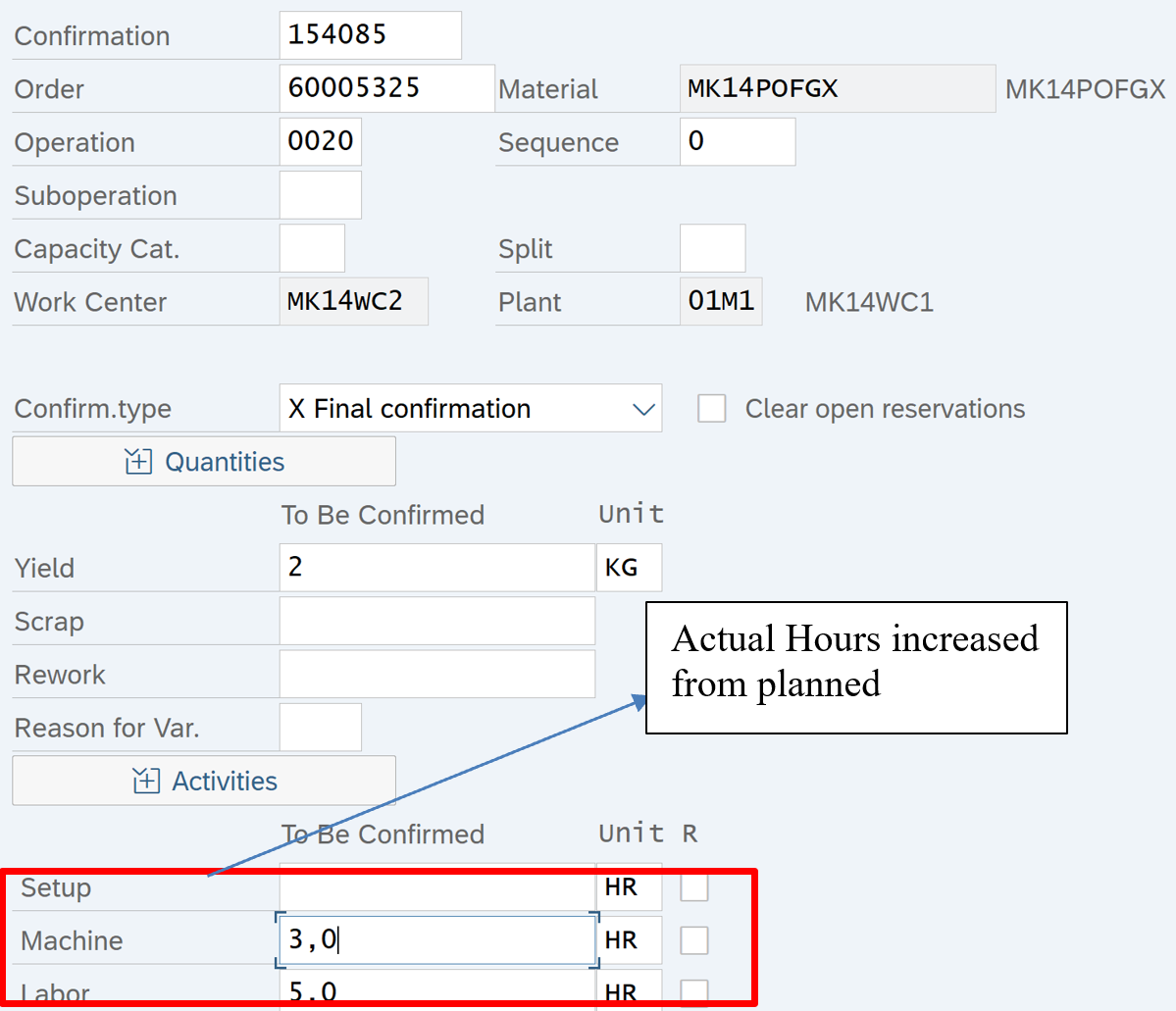

Change M/C and Labor activity to 5 and 7. Actual hrs. differ from Plan
Confirmation of order 60005325 saved- Actual activity hours confirmation

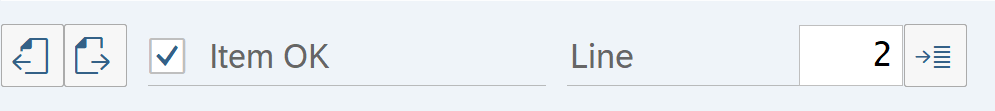

Click on Goto – display to see the activity confirmation for Operation 10
Actual hours for activity

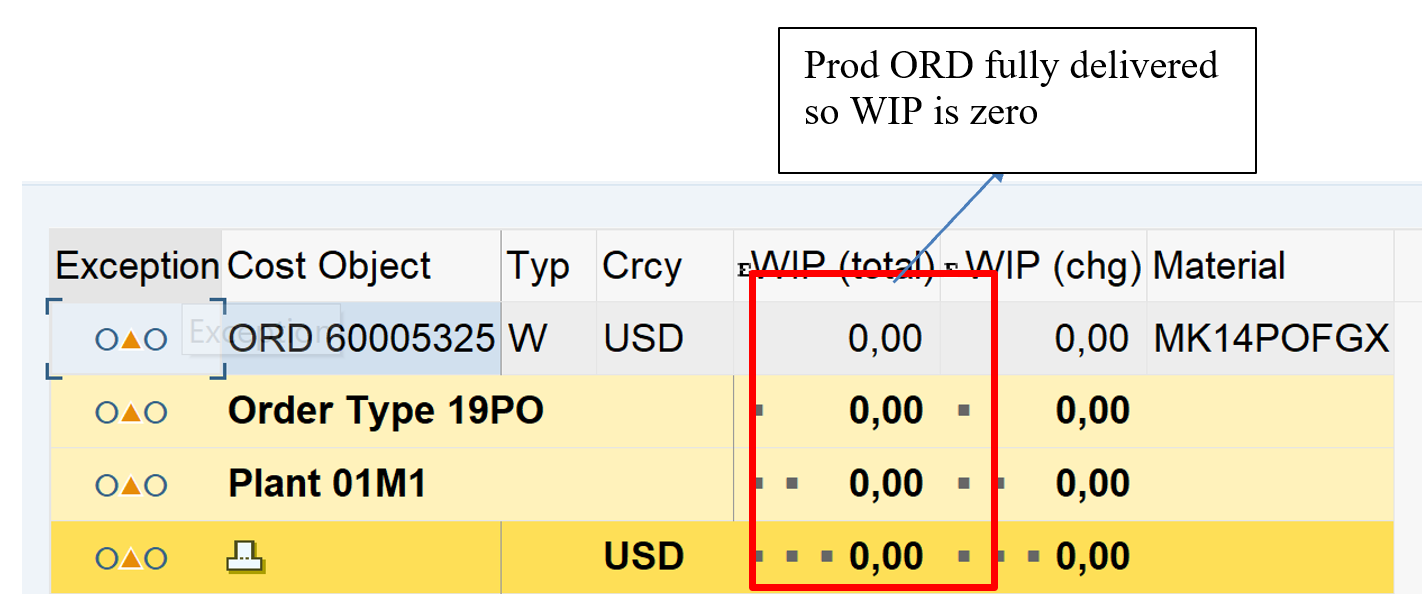

Display Production order: CO03

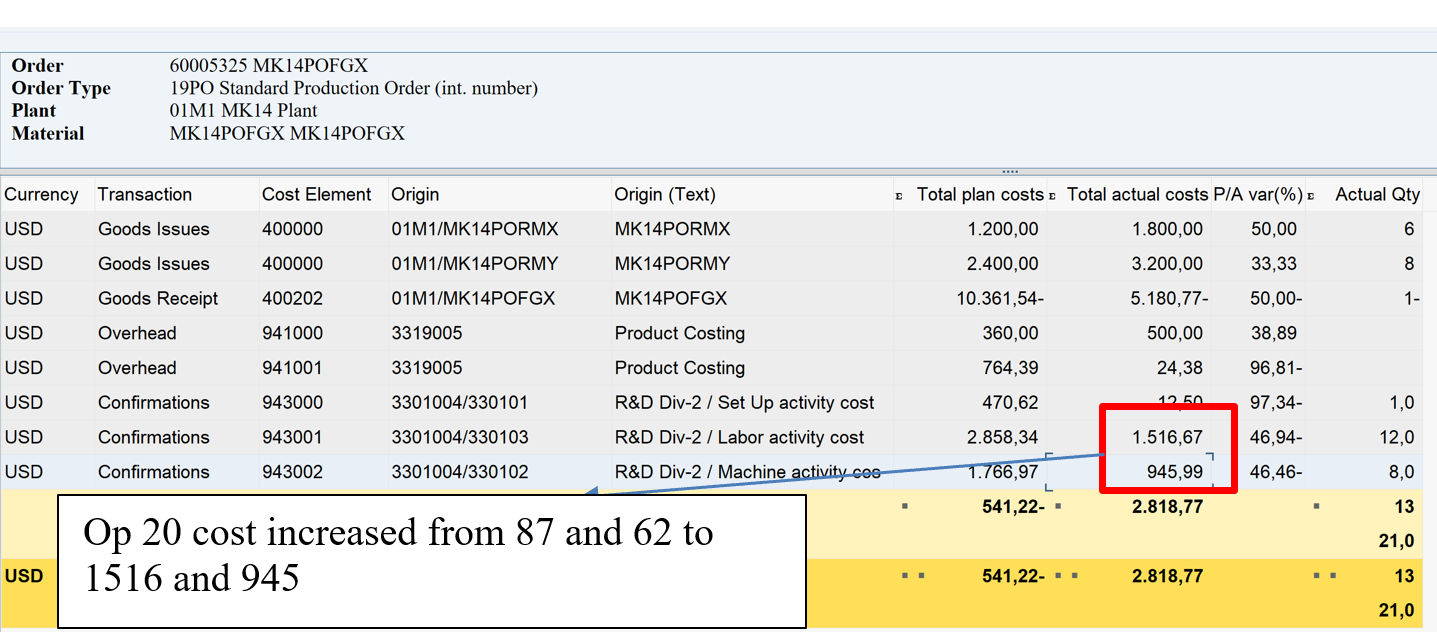

Click GOTO – Cost – Analysis – Actual cost updated with Operation 10
Actual Cost | |||||||
Raw Material | Kg | Avg Price | Actual Cost | ||||
RMX | 6 | 300 | 1800 | ||||
RMY | 8 | 400 | 3200 | ||||
Total Price RMX +RMY | 5000 | ||||||
OP 10 Confirmation | co11n | ||||||
Op10 Planned Cost | |||||||
Operation 10 (Price from KSBT) | Plan Act Hrs | Plant Rate | Plan Cost | Actual Activity Hrs | Plant Rate | Actual Cost | |
Setup | 1 | 470 | 470 | 1 | 470 | 470 | |
Machine | 4 | 294 | 1176 | 5 | 294 | 1470 | |
Labor | 6 | 285 | 1710 | 7 | 285 | 1995 | |
Total Planned cost OP 10 | 3356 | 3935 | |||||
Total | 8935 |
Tcode: FS00
GL Account: 200109
Balance sheet account, post automatically
Tcode: OBYC – BSX
Tcode: MIGO

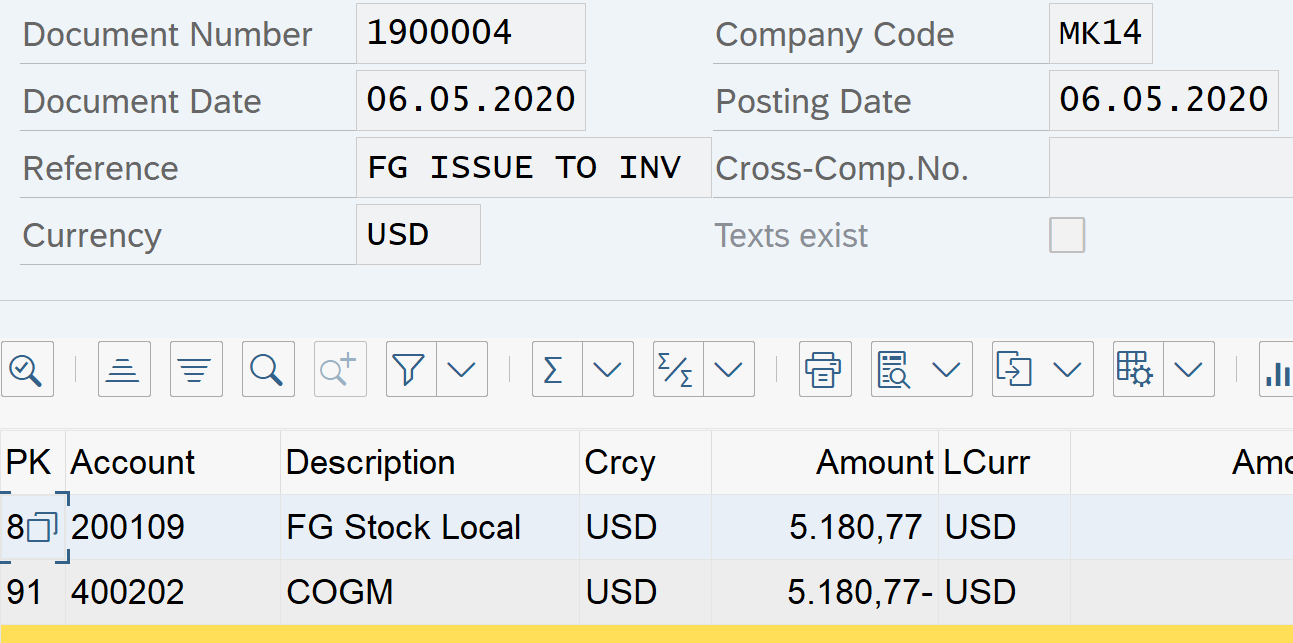

Received 1 KG of FG (Partial Completion of Production Order)
Material document 5000005113 posted

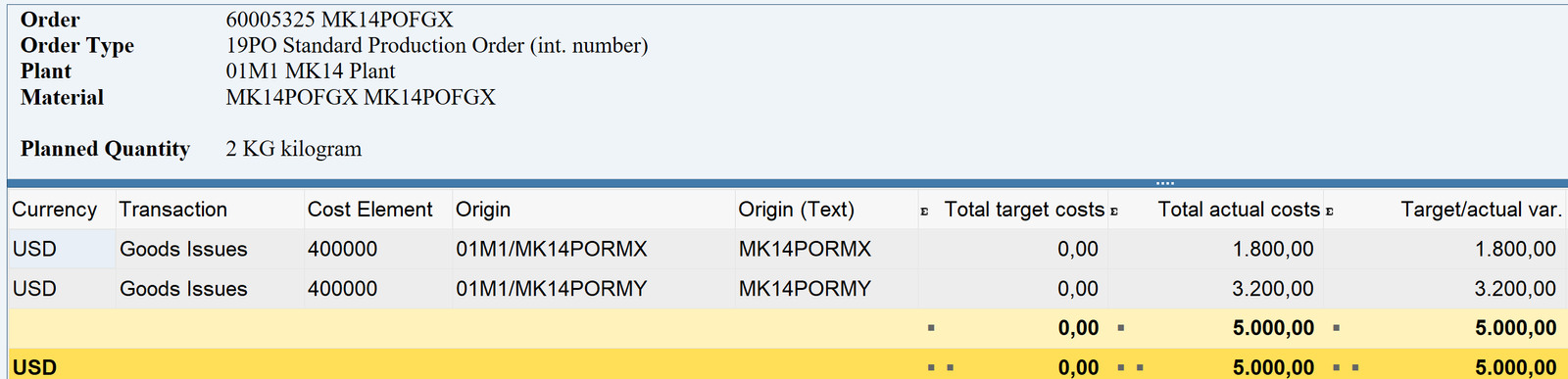

Verify actual order cost in CO03
GOTO – Cost – Analysis
Product Costing – 5 videos (Repeats explanation of cost splitting structure- Imp)
Assign CO business transaction KSIO and KSII to secondary postings Number range Tcode: KANK
Tcode: FB50
Verify Actual cost in Cost Center: S_ALR_87013611
Tcode: KSS2
Control cost is another name for actual cost
Tcode: KSII

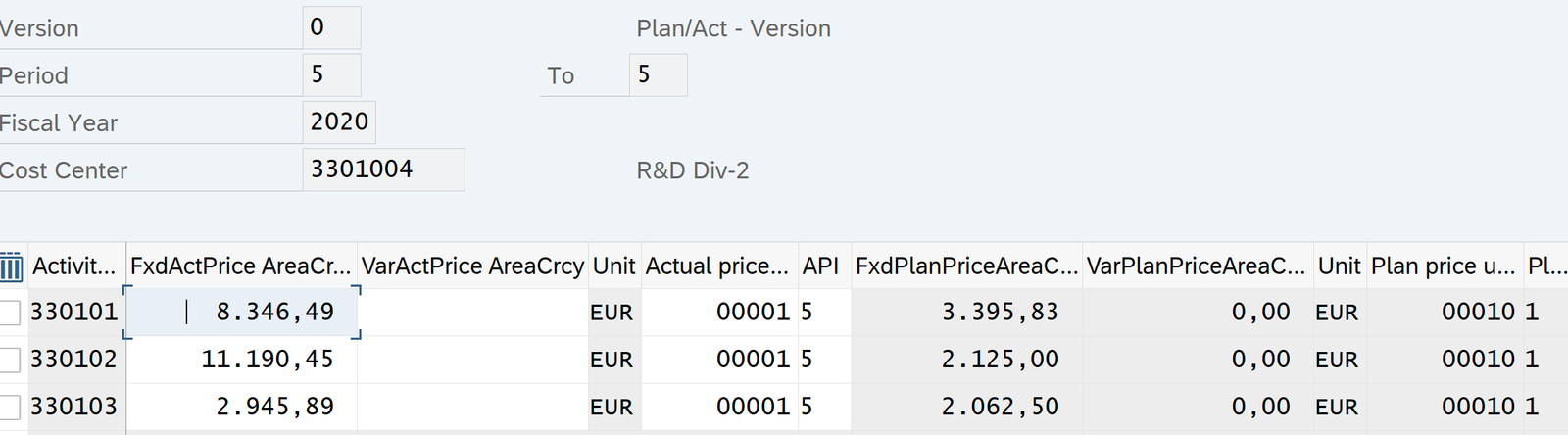

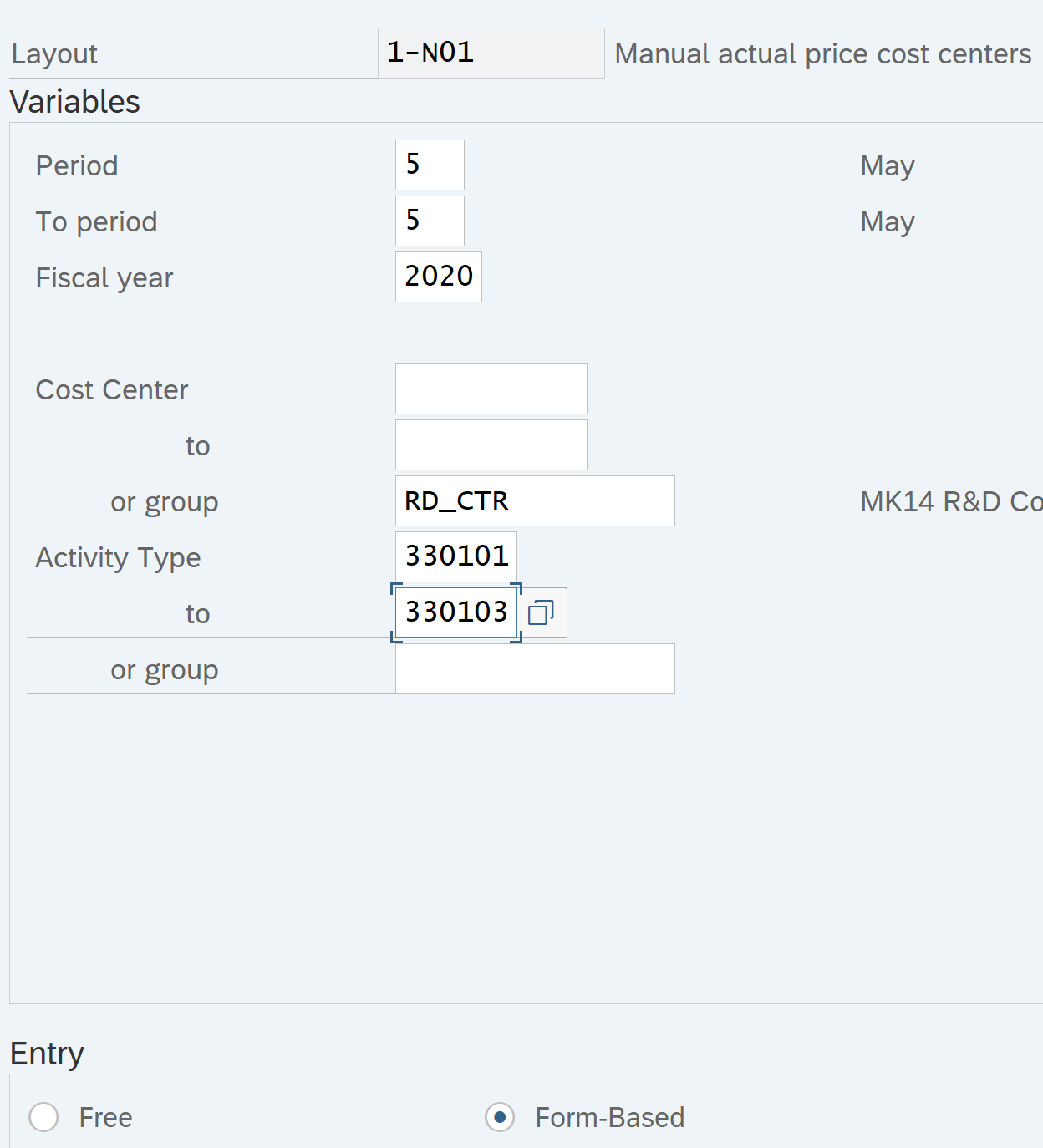

Check Activity Price per hour: KSBT
Tcode: KBK6
For the purpose of Product costing we will overwrite the system calculated actual price of activity per hour
Same as shown in KSII above. Changed to 15
Verify in Activity Price report: KSBT
Tcode: OKEQ
Specify the CCS B1 created earlier here
Tcode: MFN1 / CON2
Tcode: CO03
GOTO – Cost – Analysis
Tcode: KANK
Assign to secondary postings

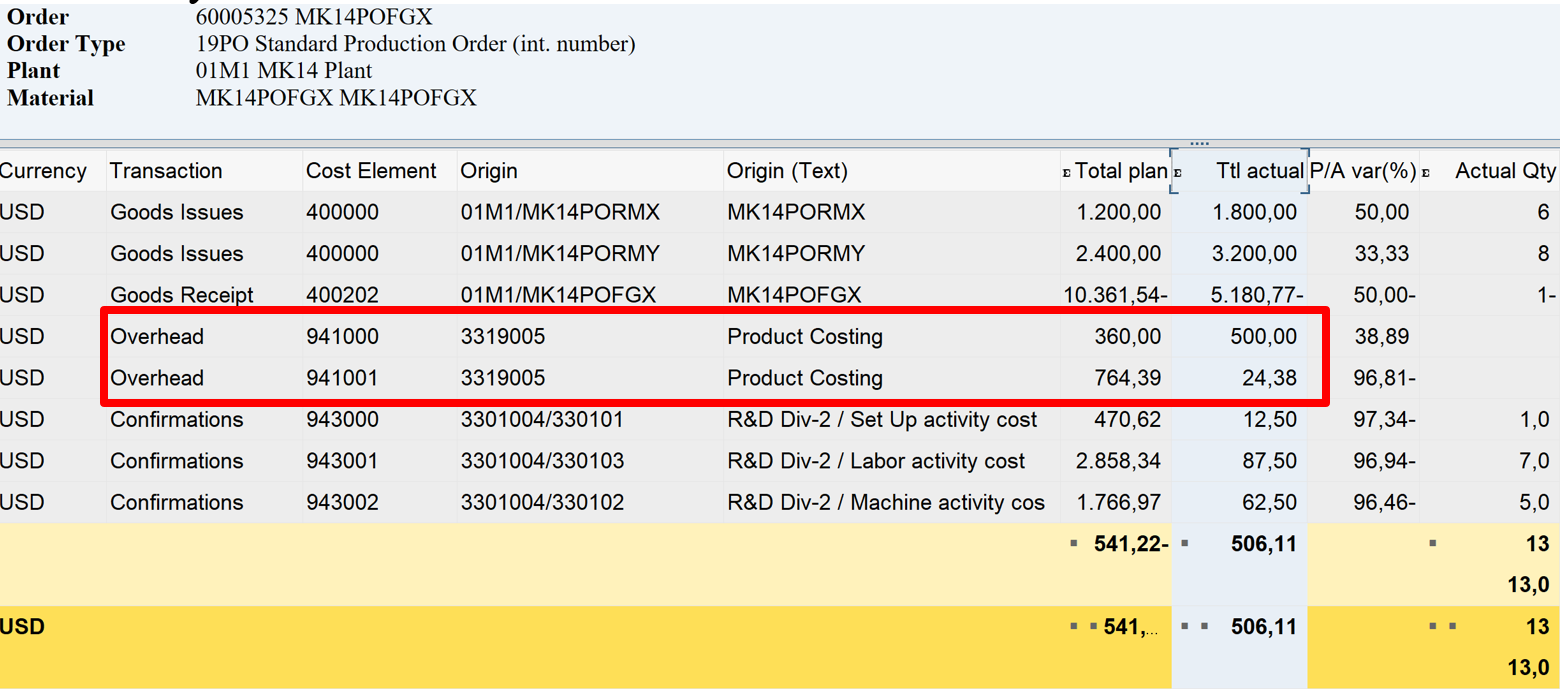

Tcode: KGI2

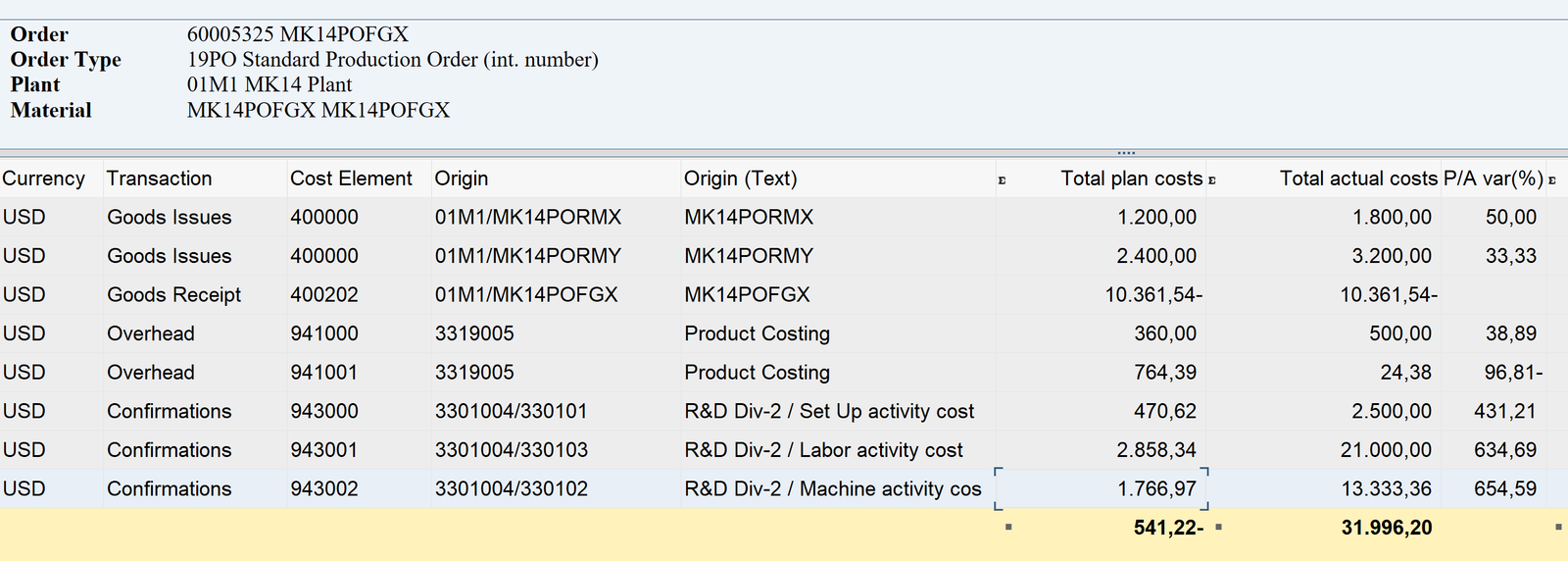

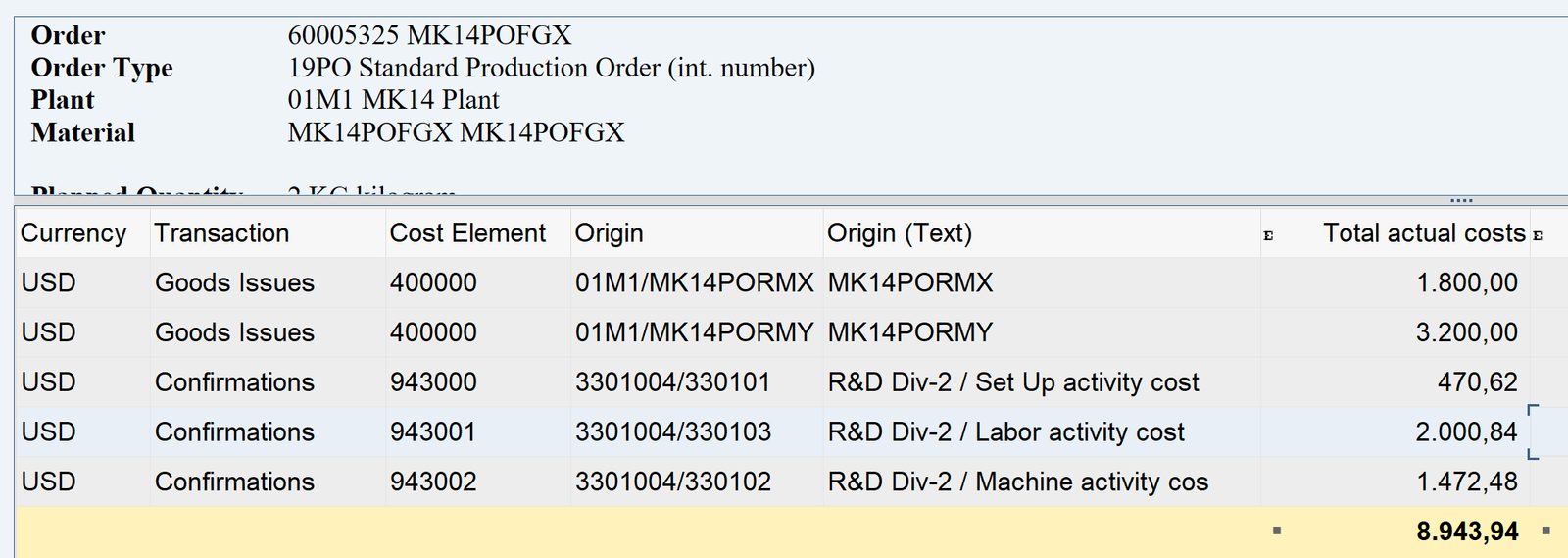

Now verify actual OH cost in Production Order: CO03
First step in calculating WIP is to cut off previous period
Tcode: KKA0

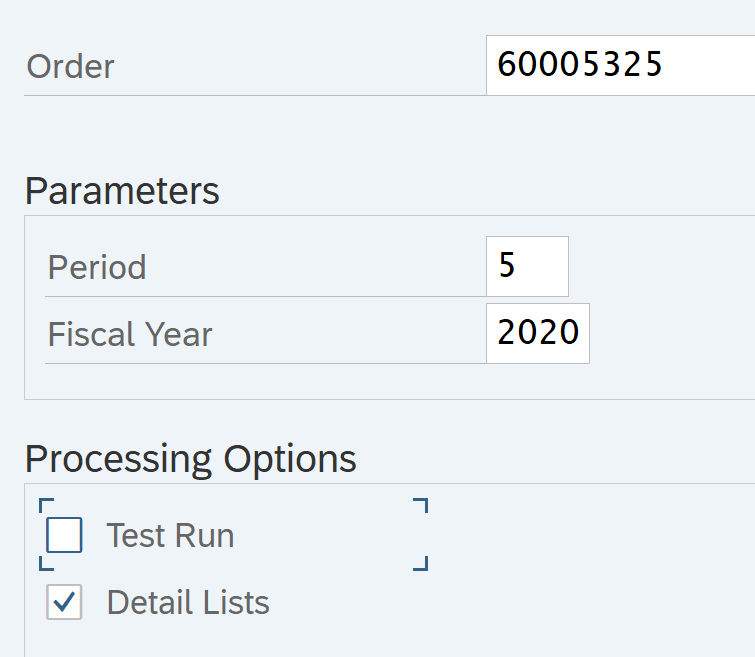

Tcode (Individual): KKAX
Collective: KKAO
Tcode: KOB8

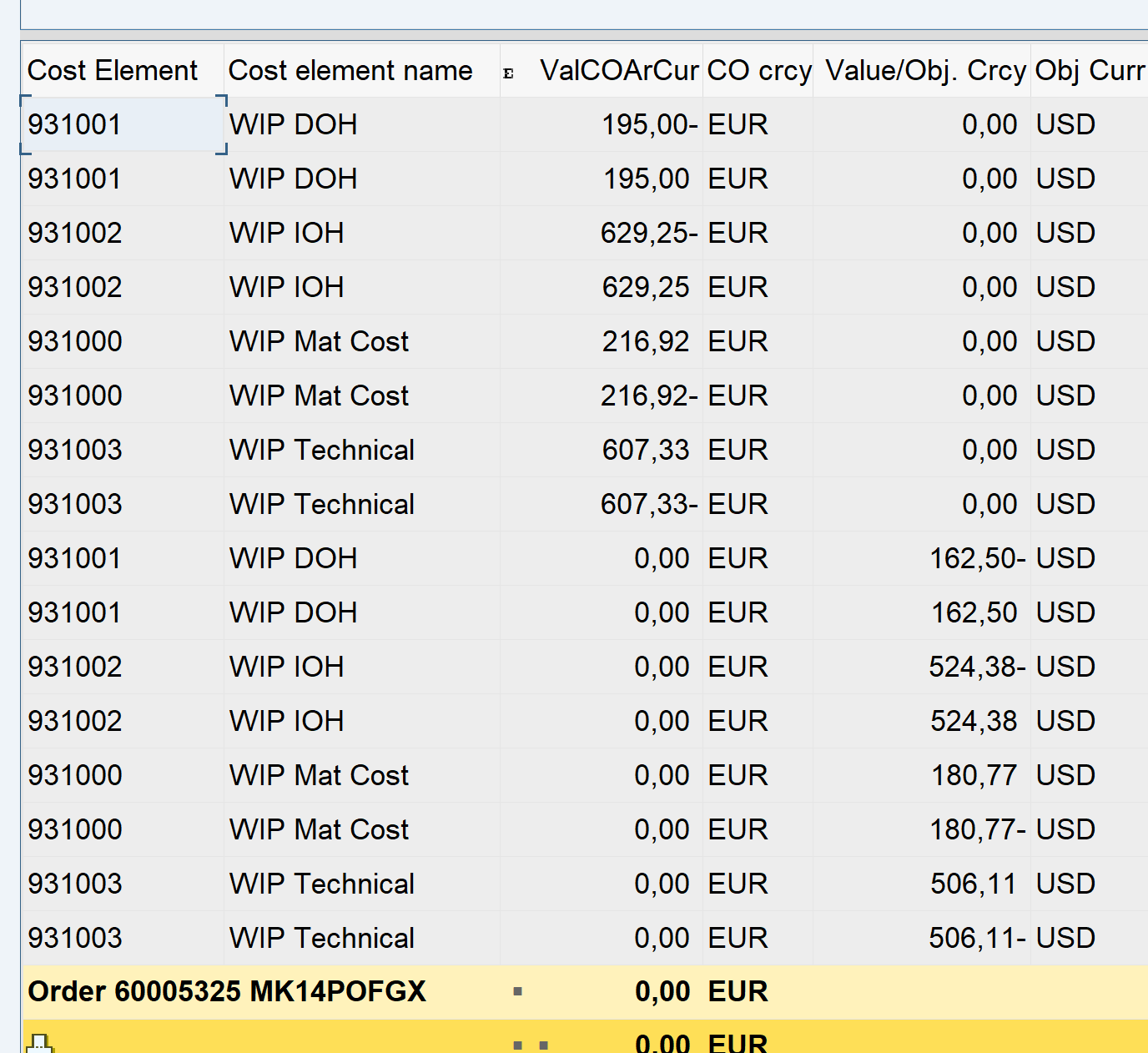

WIP Technical = WIP DOH + WIP IOH + WIP Mat Cost
It appears Month end posting made, so WIP is reversed
Note: Calculated when Order status is fully delivered or TECO
Tcode: FS00
GL: 400208
Tcode: OBYC
Transaction Key: PRD
Tcode: KANK
Business Transactions: KSOS, KSOP, KKKP, KKKS
Tcode: KKS2
Before Variance calculation Production Order settlement has to be carried out
Individual Production Order: KO88
Collective Production Order: CO88
Display Production Order Settlement Doc : KSB5
During settlement WIP values transferred from CO to FI
Tcode: CO11N
Enter and Save – Completes confirmation
Confirmation of order 60005325 saved
Production Order will have Actual Operation 20 cost posted to it

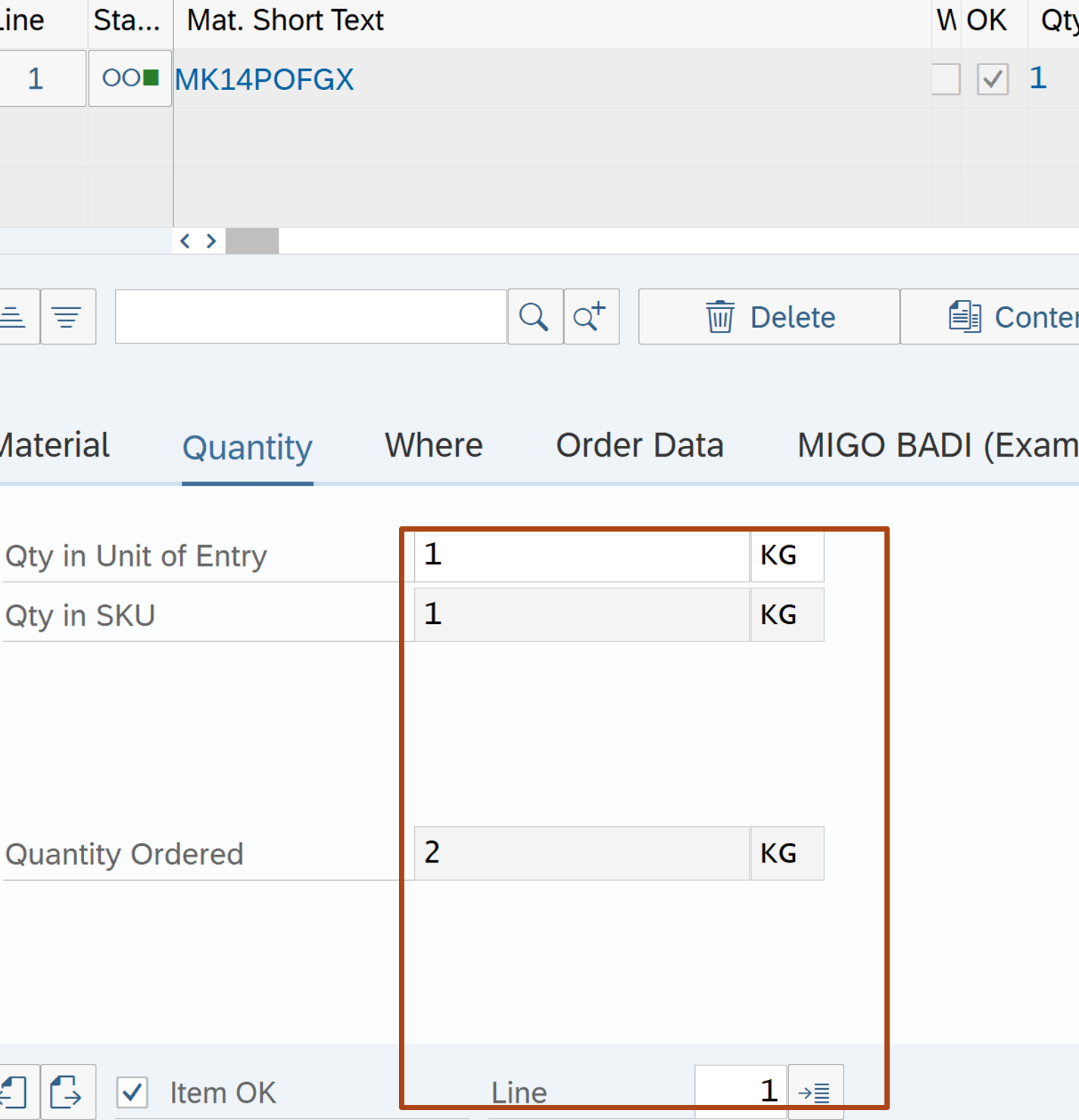

Tcode: MIGO
Prod Order: 60005325
Movement Type: 101
Receive Full Qty from the Production Order
Material document 45078 posted
Select Display in MIGO
Tcode: CO02

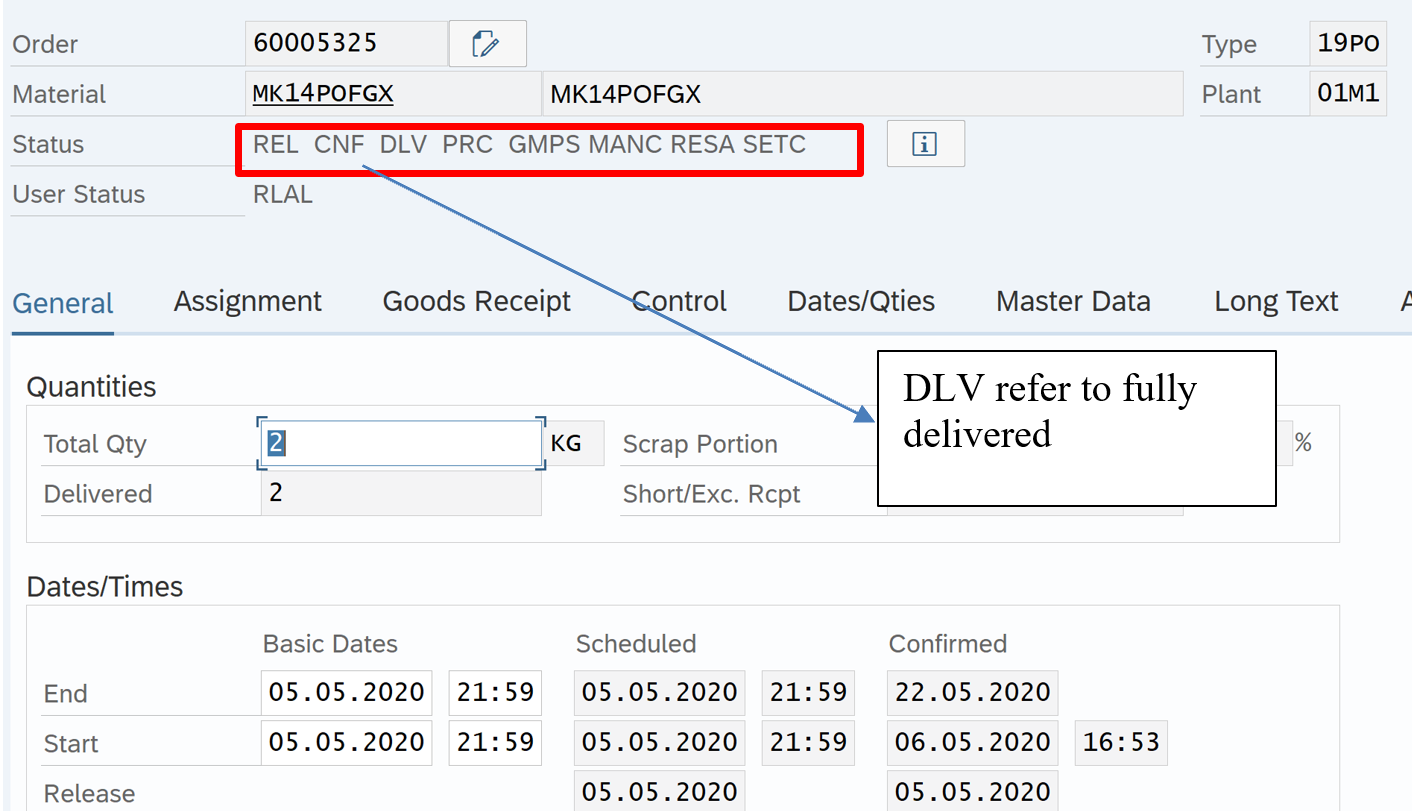

Once the Production Order qty is fully issued, status update to Fully delivered

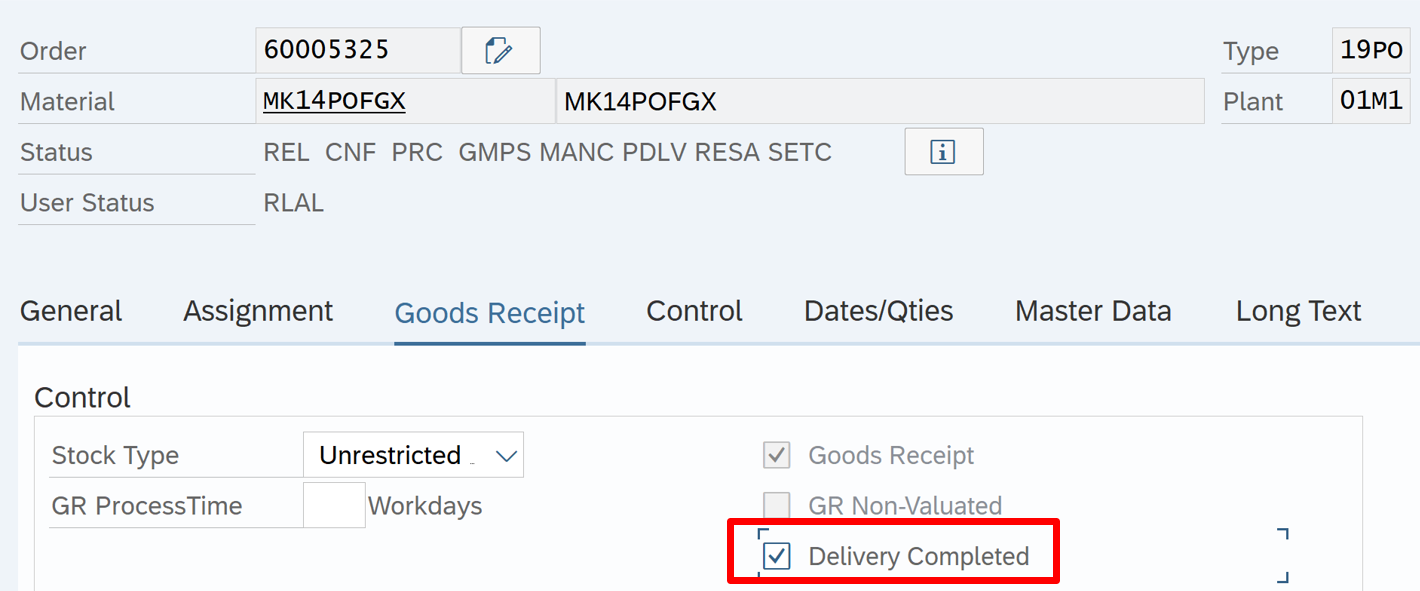

As Production Order status is Partially delivered, manually change it to fully deliver as below
Select Delivery Completed in the Goods Receipt tab and Save
Video 6
Manually enter actual activity Price: KBK6
System Calculation of Actual Activity price
Manual calculation of Planned activity Price: KP26
System Calculation of Planned Activity Price
- OKES
- OKEW
- KSS4
- KSPI
Revalue Operation Activities at actual price: MFN1
- Calculate Actual Over Heads
- Perform Month end cut off / period change for WIP: KKA0
- Perform WIP Calculation: KKAX
- Calculate Variance : KKS2
In this Month we manually maintain actual activity price as system calculated done in last month
Tcode: KBK6
Tcode: MFN1
Actual Price now have gone up
Check Production Order: CO03
Tcode: KGI2
Click Back arrow two times. Message Online processing completed. Than only it post to FI
Verify the cost in Production Order: CO03
Not required as same month
Please visit previous tutorial on Product Costing Business Process, Configuration in SAP
Please visit next tutorial on Profit Center Accounting
For Step by Step instruction to configure, test and understand Product Costing in SAP please join my SAP Controlling Course
Pingback: Course Material - AIERP2
